In JIRA timeline - I want to see start date, due date and actual completion date on bar

rohit_ambekar
January 1, 2026

In JIRA timeline - It is normally Start date and due date is seen if you hover over any bar of task, I want to know if I add one field "actual completion date" then can I see also in the bar actual completion date ? so that the bar shows in same bar - Target completion and actual completion. so that with this view - we can able easily see in that single bar - both dates and delay portion can it be with different colour ?

Is this possible ? and if Yes then how we can set it in configuration ?

1 answer

0 votes
Trudy Claspill
Community Champion
January 1, 2026

Hello @rohit_ambekar

Welcome to the Atlassian community.

No, that is not possible.

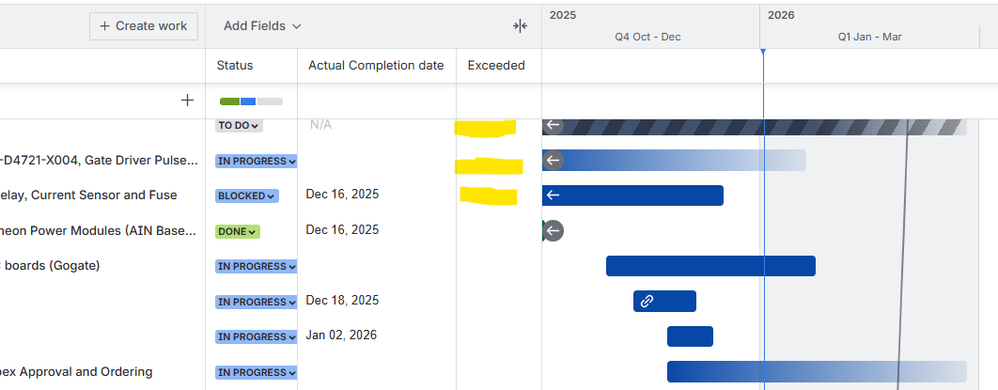

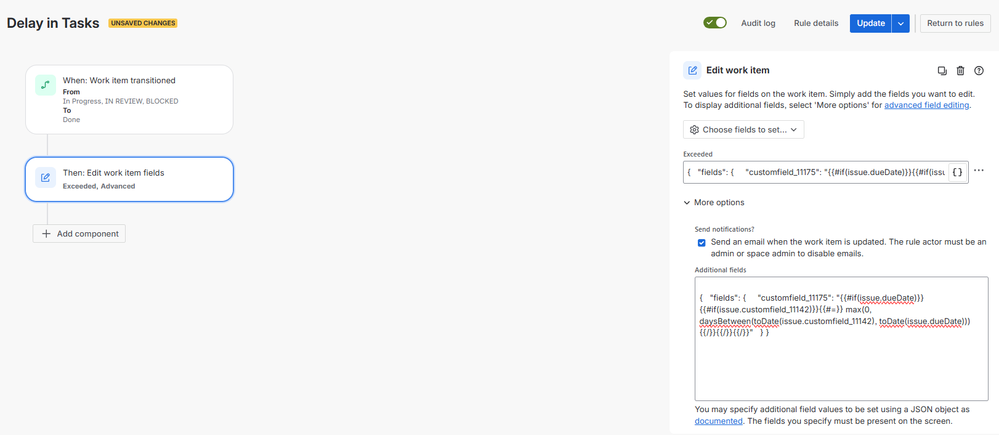

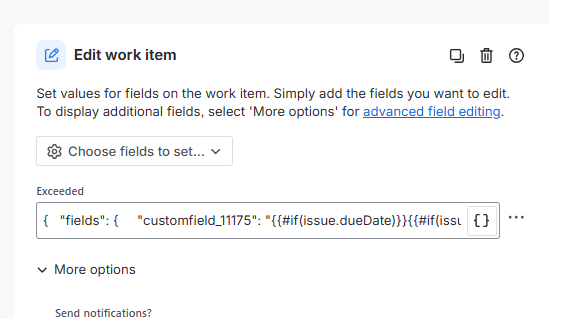

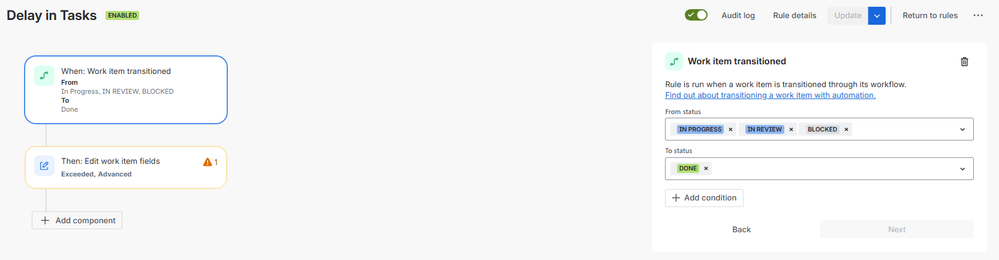

In a Plan in the Timeline view you can add the Actual date field to the Custom fields that are displayed, but you cannot show three dates on the bar.
