You're on your way to the next level! Join the Kudos program to earn points and save your progress.
Level 1: Seed
25 / 150 points
Next: Root
1 badge earned
Challenges come and go, but your rewards stay with you. Do more to earn more!
What goes around comes around! Share the love by gifting kudos to your peers.
Keep earning points to reach the top of the leaderboard. It resets every quarter so you always have a chance!
Join now to unlock these features and more
The Atlassian Community can help you and your team get more value out of Atlassian products and practices.
Hi there,

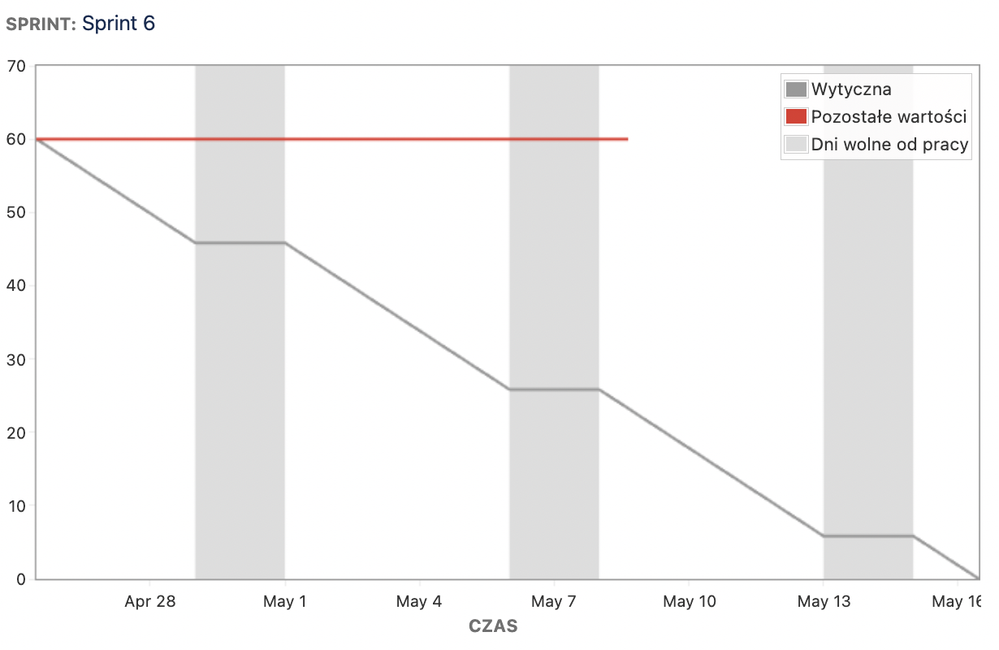

I've got a problem with my sprint burdonw chart. The team has been working on this project for several sprints now and there has never been such a situation. Although the story points are burned, the chart does not respond to changes ( attachment). Can anyone have an idea what the causes could be? I'd appreciate your suggestions.
Regards,
Ola
Are your issues being marked as "done"? That is, in the last column of the board?
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
Are the issues base-level issues (not sub-task types)? And are all their sub-tasks (if they have them) in the last column too?
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
@Nic Brough -Adaptavist- Each type of issues are marked as Done - status from the column on the far left.
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
Um, that's the wrong end of the board, as I said, your Done status needs to be in the last column, not the first.
Are the issues base-level issues (not sub-task types)? And are all their sub-tasks (if they have them) in the last column too?
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
Hi @Ola Czyż - Has there been any recent changes to workflow and/or board column config? The burndown is based upon issues in the far right column.
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
Hi @Mark Segall , thanks for the answer! I've already check this, as I know this could be an issue, but no, there were no changes within workflow or column board.
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
Have you verified that the completed issues also have a resolved date and resolution?
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
@Mark Segall yes, they have.Estimation of the story points was changed during the sprint. I am wondering, if this could affect?
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
That shouldn't impact. I just verified in my test environment that I can change story points after sprint start and still get a burndown.
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
