The Atlassian Community Forums are currently in read-only mode. We will be relaunching on a new platform on September 22 (read more here). We apologize for the extended downtime. For concerns or questions, please email communitymanagers@atlassian.com. See you on the other side, on the new Atlassian Community Forums! :)

×

Forums

Articles
Create
cancel
Showing results for
Search instead for
Did you mean:

difference between target, estimate, and actual

Consulente Atlassian
Rising Star
Rising Star
Rising Stars are recognized for providing high-quality answers to other users. Rising Stars receive a certificate of achievement and are on the path to becoming Community Champions.
April 19, 2017

in JIRA Portfolio 2.0  The "themes" function presents a report that shows three pie charts. Respectively they are: target, estimate and actual. Taking an example of three types of customer experience issue, issue two types of support and two types of sales, each of the estimated duration of one day, I would like to understand how you interpret the pie "estimated". That is, if the job estimate remains to be done in total days of all the issue is not "done"?

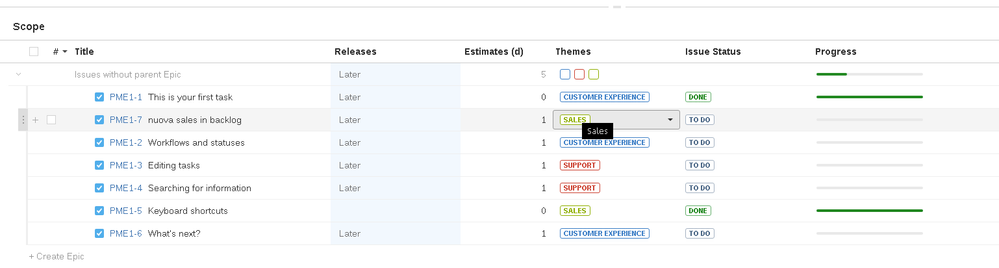

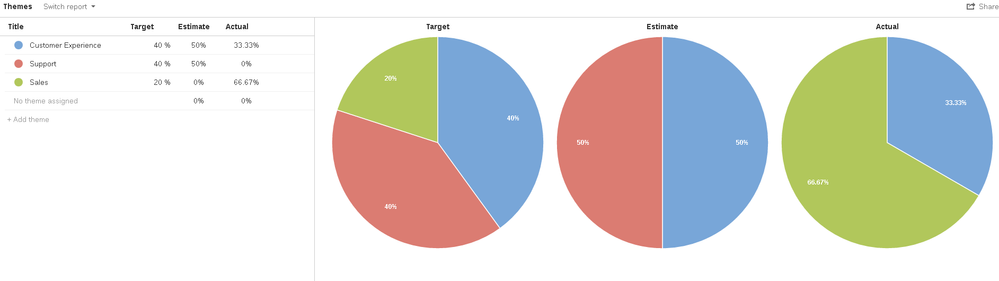

Schermata 2017-04-19 alle 16.12.49.pngSchermata 2017-04-19 alle 16.07.16.png

1 answer

Comments for this post are closed

Community moderators have prevented the ability to post new answers.

0 votes
Walter Buggenhout
Community Champion
April 19, 2017

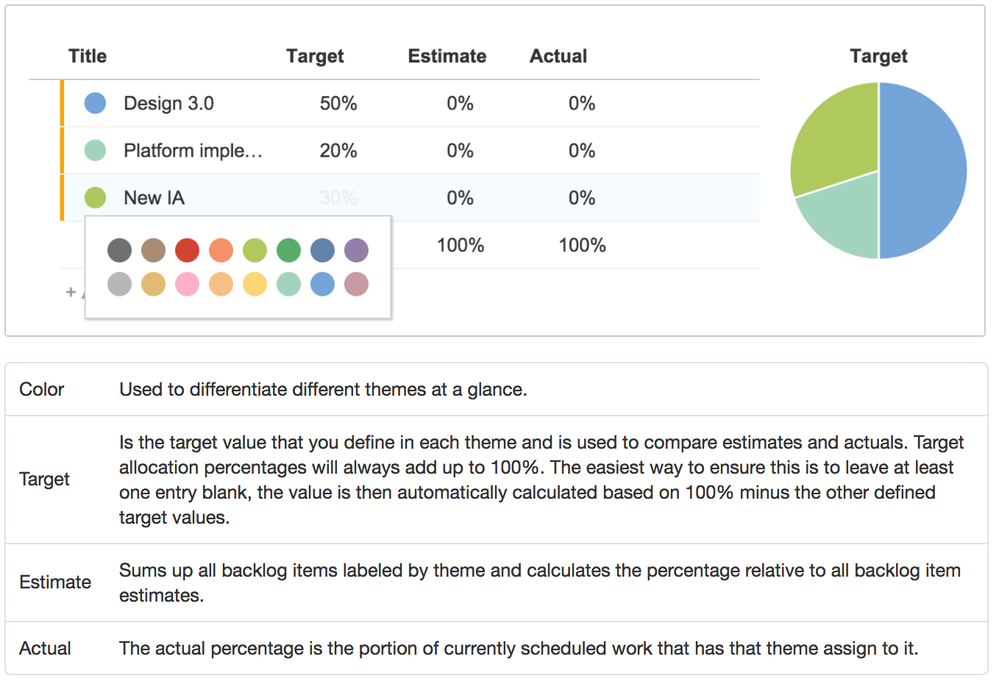

I hope this extract from the documentation answers your question:Screen Shot 2017-04-19 at 18.03.50.pngWhat the 'estimate' represents, depends on the estimation statistic you chose for your Portfolio Plan. If you selected time based estimates, this will be based on the original estimates field, if you selected story points, it will rather be the story points.
