Hello,

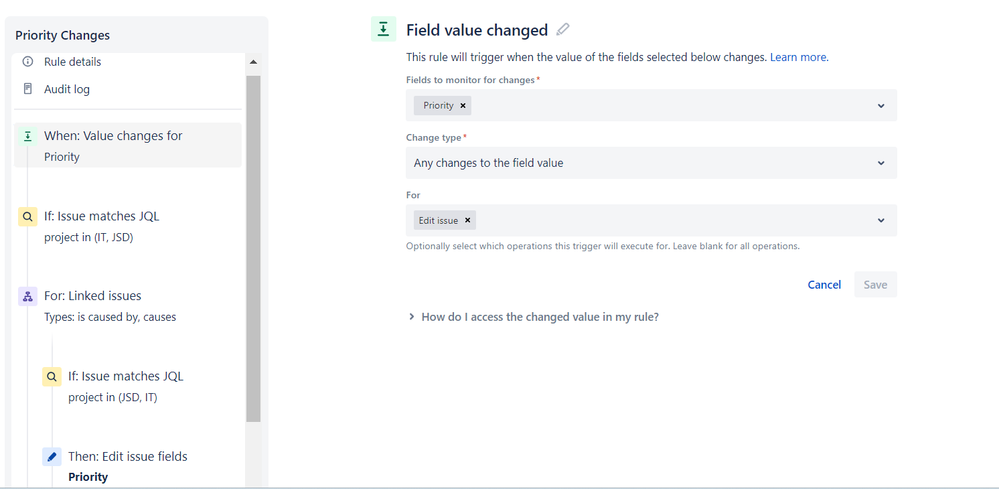

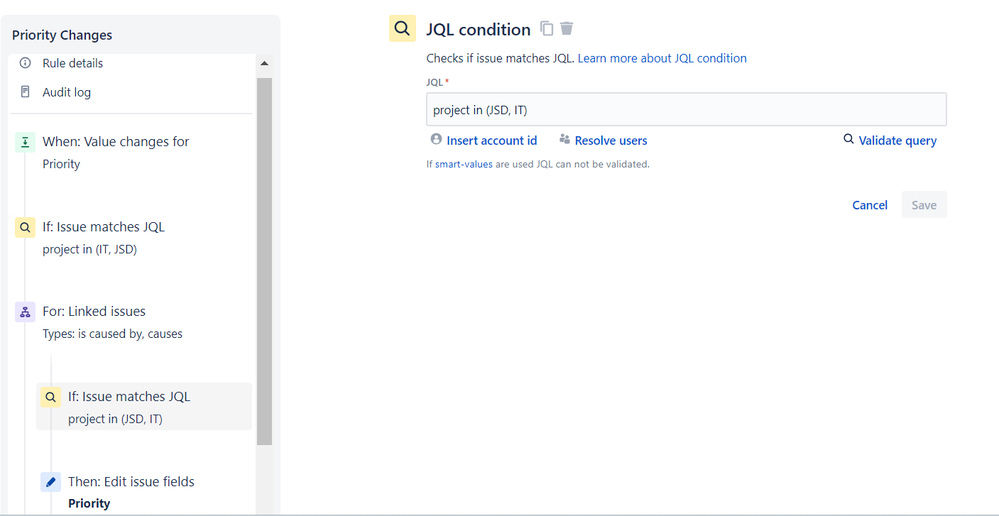

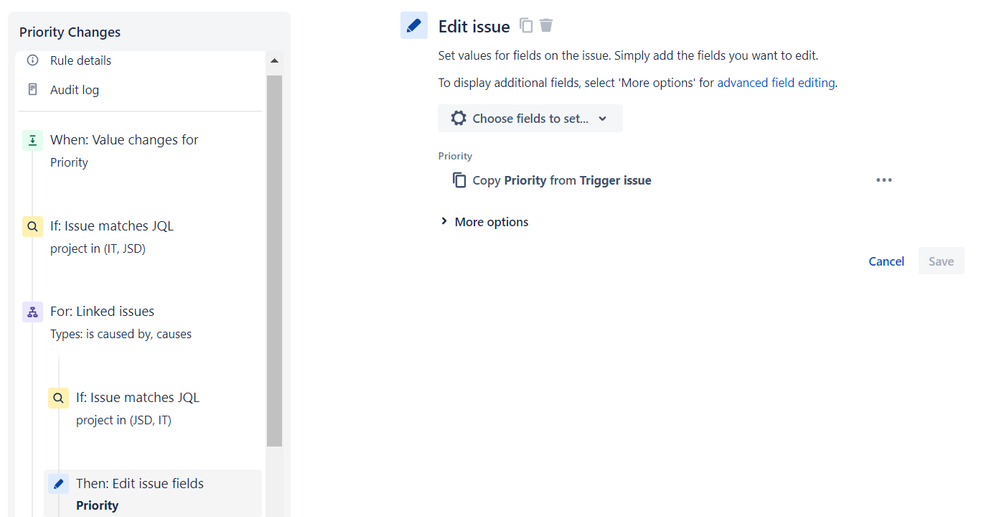

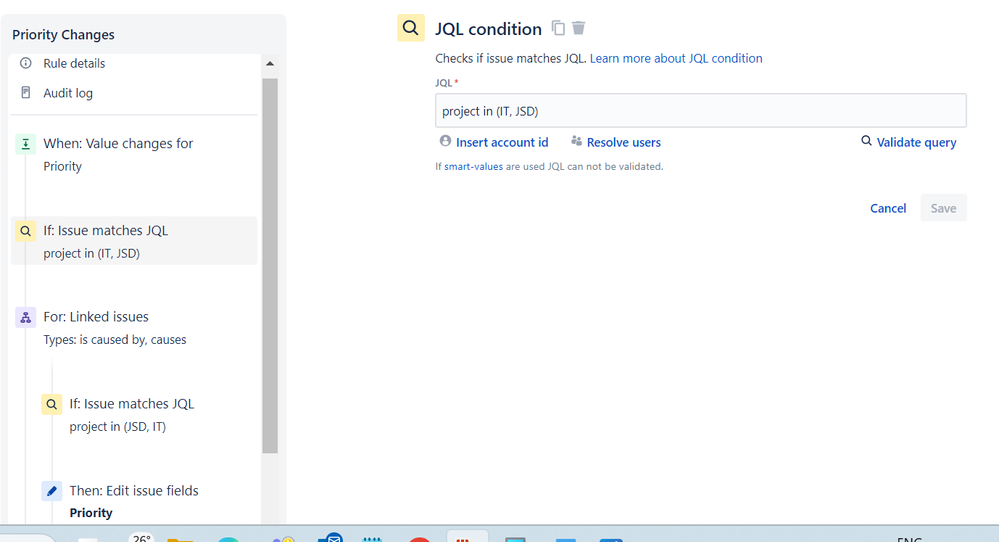

In this rule when priority is changed in A project then priority should be updated in B project. only for linked issues. as well as same if priority changes in B project, then it should update in A project. but here is as I am aware that we are using Jira standard version and we have limit for multiple project Automation rule.

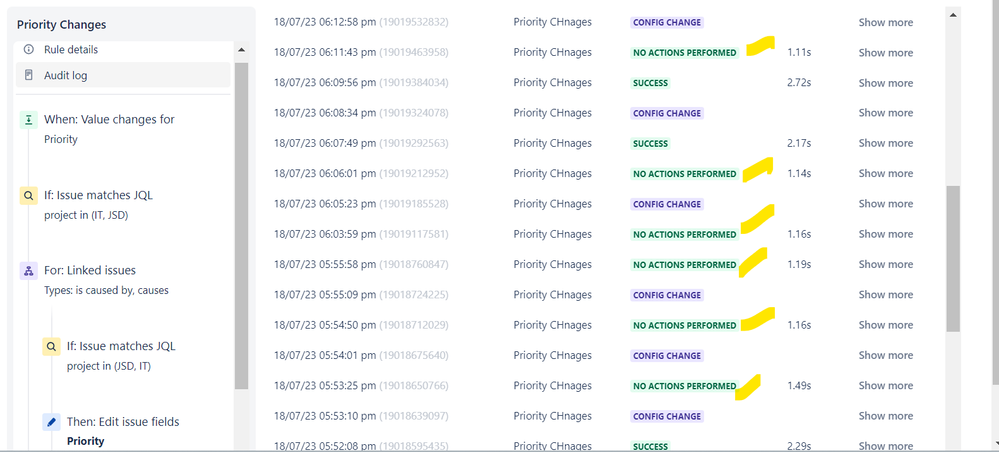

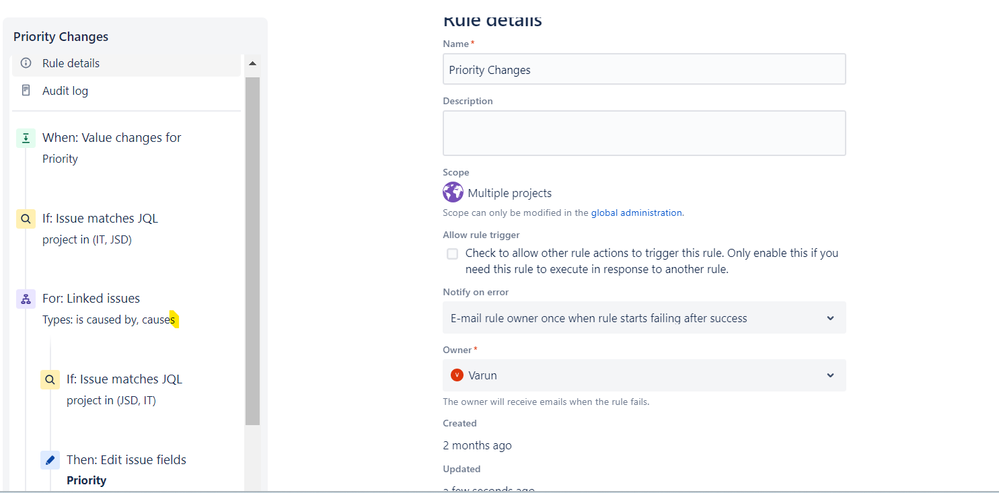

I already created rule I will share the SS. But here when I checked in Audit Log, I see many "no action performed" executions which is breaching our limit. I need Help in how I can overcome from that "No action Required". if anyone has alternative rule please share and guide me on that
Hello @Raman Varun Tej
Welcome to the Atlassian community.
Is your issue that you are breaching the limit of 500 global/multiple-project rule executions per month?
If so, is this the only global/multiple-project rule in your system, or are there other such rules that are contributing the the usage count?
Or is your issue that No Actions Performed is occurring when the rule is triggered?
If so, please click the Show More link next to the Audit Log entry that shows "No Actions Performed" to see the details of that execution. That will include information that explains why no actions were performed. Share that information with us if you are unable to determine the cause of your problem.
