Good day!
I would like to seek your help as to why our last 2 sprints in the Velocity Chart report are missing inputs on Committed SP.
I am not aware of any changes in our board.
When I checked the backlog insight from the backlog view, it is displaying the committed SP for current (Which I assume it is the same for the previous sprints that we have).
We are using JIRA Cloud version.
Hi

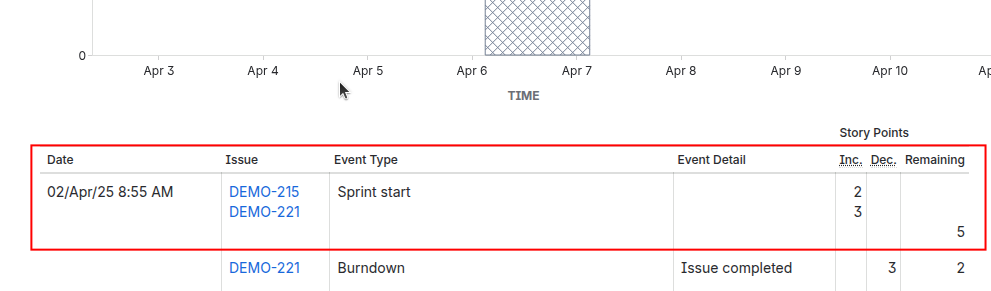

In Jira, velocity report commitment is nothing but how many story points you have commited while starting the sprint. That means there are 10 issues in entire sprint and you have given on average 5 story points to each issue, then commitment will be 50. As i can see in screenshot can you please check if you have added any story points to assignes issues in sprint?
Velocity report will show the graphs for last 7 sprints. you can see on that specific sprint have you added the story points or not?
