The Atlassian Community Forums are currently in read-only mode. We will be relaunching on a new platform on September 22 (read more here). We apologize for the extended downtime. For concerns or questions, please email communitymanagers@atlassian.com. See you on the other side, on the new Atlassian Community Forums! :)

×

Forums

Articles
Create
cancel
Showing results for
Search instead for
Did you mean:

How to confirm/limit the number of issues (story, epic, bugs) into JIRA ROADMAP Cloud

Renato Rodrigues
February 16, 2021

How to confirm/limit the number of issues (story, epic, bugs) that can be import into JIRA ROADMAP Cloud in February 2021

1 answer

1 accepted

Comments for this post are closed

Community moderators have prevented the ability to post new answers.

2 votes
Answer accepted
Walter Buggenhout
Community Champion
February 16, 2021

Hi @Renato Rodrigues ,

See this extract from advanced roadmaps documentation:

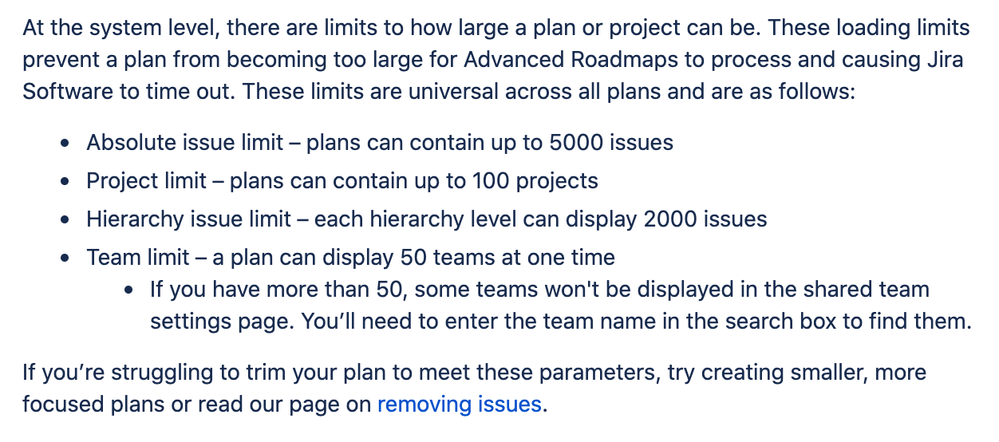

Screenshot 2021-02-16 at 16.00.26.png

Renato Rodrigues
February 16, 2021

@Walter Buggenhout the item "Hierarchy issue limit" does it mean about EPICs? I didn't get the reference about "ISSUE LIMIT" and "HIERARCHY ISSUE LIMIT".

It's clear and no questions about "Team limit" and "project limit".

Walter Buggenhout
Community Champion
February 16, 2021

Epics are indeed one level of the hierarchy. A traditional hierarchy in advanced roadmaps is set up like this:

  • Initiatives at the highest level
  • Epics at the level below
  • Task, Story, Bug, ... at the level below
  • Sub-tasks at the lowest level

Each of those is a hierarchy level. And so you can have a maximum of 2.000 issues at each level.

As the hierarchy will be more or less like a pyramid (fewer items as you move up to the higher levels), it is a good idea to assume you can have 2.000 Task, Story, ... issues in your plan and probably fewer epics, initiatives.

The absolute issue limit really is the total number of issues you can have in your plan, regardless of the level they are at.

Teams live on a separate tab in the roadmap. Most likely, you will have 1 team for each board or project you pull into your plan. You can have up to 50 of those in a single plan.

Like Renato Rodrigues likes this
