Dear members,
I have created a Gantt Chart in the JIRA Structure and want to calculate the Progress Calculation manually configured.

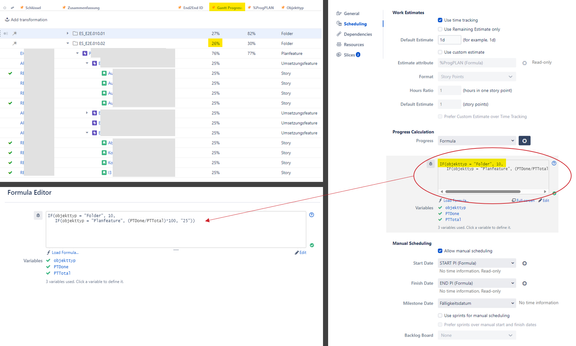

The following screenshot shows the formula for Progress Calculation. Despite the selection of the object type "Folder" and the fixed value of 10 -> 10%, it is still aggregated to folder level and shown a false value.
If anyone from the forum had a similar case and found a solution for this, then I am very happy about feedback.
Thanks a lot
Hello @Strawberry
Currently, it is not possible to define a custom logic for calculating progress for groups on Gantt charts. The progress for all such items - groups, parent issues and folders - is always calculated as the average of progress values of tasks inside of a group.
We have a feature in our backlog for allowing the customization. Once it is released, we will share an update in this post.
If you need our assistance with anything else in Structure - please reach out to us directly at our support portal and we'll get back to you shortly.
Best regards,
Stepan Kholodov
Tempo
Online forums and learning are now in one easy-to-use experience.
By continuing, you accept the updated Community Terms of Use and acknowledge the Privacy Policy. Your public name, photo, and achievements may be publicly visible and available in search engines.
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
