Hi everyone,
I'm looking for an automation to performs 2 actions on issues :
1. When an issue is moved from the backlog to a sprint, Update both Start date and Due date. --> I have an automation for this one, and it works well
2. When an issue is moved from a sprint to another, Update only the due date (start date must remains in the initial sprint) --> I can't find how to realize this one :(
I tried something with If/else block, but it doesn't work.
Does anyone have an idea ?
Thnak you,
Nicolas
Hi @Najm Polaris ,
Thank you for your answer.
As we use BigPicture, all the tasks in our project scope (even if they have no sprint yet) have a start date and an end date.
Is there a way to write a jql that look for the number of sprints in the field ?
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.

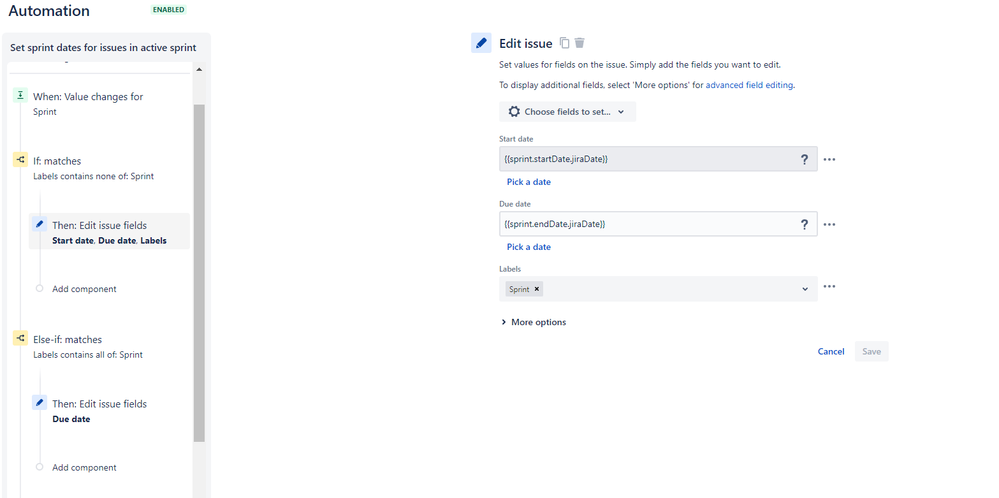

take another field to check if was added to a sprint or not. I used the label sprint for this. This would suffice both the conditions even if it has a start date.
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
What will the due date be set to? What date field will be used to set the Duedate?
if the sprint end date is used then maybe rethink your approach. Maybe Is sprint started as the trigger, and set the duedate to the sprint end.
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
Hi Jack,
I need the sprint end date to be defined as due date.
But I need it to be updated as soon as it is placed into the new sprint.
What do you mean by "set the due date to the sprint end" ? The sprint end date must remains as defined by the user. Only the issue due date must be updated accross the sprints.
Please let me kniw if my explaination isn't clear.
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
something to try...
trigger on Issue updated, field = sprint
condition - assess if sprint is in future sprint
action - edit issue and copy End date to Duedate
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
