Is it possible to configure velocity and capacity in Jira if there are 4 permanent team members and 3 occasional contributors? It's unclear when and for how long those 3 contributors will be added. The employer wants to include these parameters in the workflow, but I'm trying to explain that with an unstable team, these metrics become very inaccurate.
Could you please share how this works in your experience?
Hi @kafka max ,
You are right. It doesn't make sense to calculate capacity and velocity this way. In case these are the same contributors, I would suggest your employer organize 3 occasional contributers into a team, so that you can just sum up velocity and capacity of two teams. It won't be super accurate either, but it will be the best solution from my standpoint.
To sum up the metrics, you can do it manually or create a 3rd board with the following filter where velocity will be done automatically:
filter="%OCCASSIONAL_CONTRIBUTERS_TEAM%" and filter="%STABLE_TEAM%"
However, capacity will still need to be set manually.

To check the capacity and velocity for these 2 or more teams in a single view, you can use the app I developed - Multi-team Scrum Metrics & Retrospectives. With it, you can get the following view:

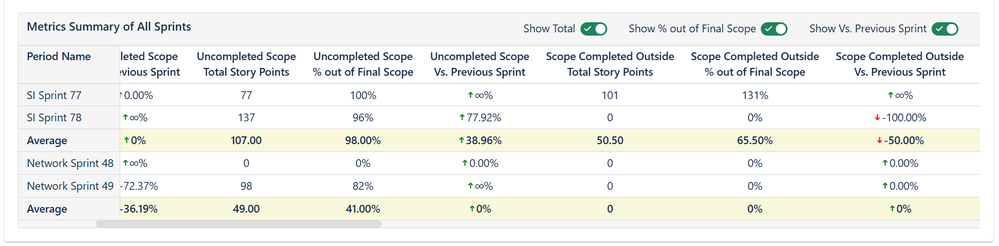

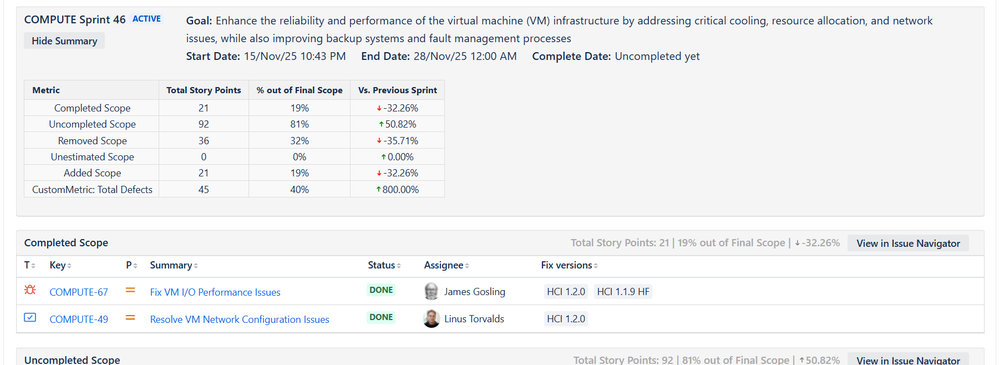

Analysis of the Sprint (all sprints bars at once):
Trends and averages:
Best regards,
Alexey
Hi @kafka max,
Since you're tagging your question as related to the free plan of Jira, velocity and capacity are planned at sprint level - that means for each iteration of (typically) 2 weeks.
If your team is volatile by design, the tool is not going to fix that for you. You can, during sprint planning, of course balance the commitment of your team to the capacity you will have available for each sprint. velocity reports will simply reflect what your team delivers and give you insights on average performance over time. You can - to some extent - then use that information for longer term forecasts.
Hope this helps!
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
In my experience, velocity and capacity can be configured in Jira, but they rely heavily on the consistency of the team. For stable teams, it's relatively easy to track and adjust these metrics based on the work completed over time. However, with an unstable team that includes both permanent members and occasional contributors, these metrics can become skewed, less reliable, and lead to fluctuations that don’t truly reflect the team's capacity to complete work.
One solution to manage capacity in such situations is Planyway. Planyway allows you to visualize team capacity in a more flexible way, accommodating changes in team composition. You can set up the resource management features to allocate different amounts of work to your permanent and occasional team members, even if the latter are not consistently available. This way, you can better manage the work distribution without relying on the often inaccurate velocity and capacity metrics in Jira.
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
