Getting sprint to reflect correct remaining days.

Jim Stewart
Contributor
June 25, 2020

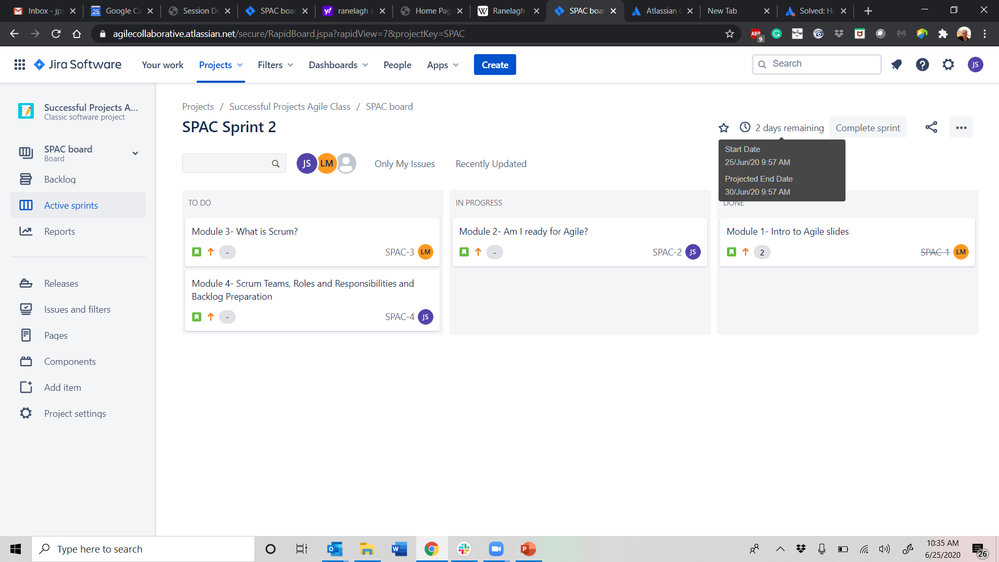

I'm working on creating a Scrum class and am using JIra. Note that I am in Sprint 2. You can see by the attached screenshot that the end of the sprint is June 30, 6 days from today (June 25.) So why on earth does it say 2 days left? What am I missing?


1 answer

1 accepted

0 votes
Answer accepted
Dave Theodore [Coyote Creek Consulting]
Community Champion
June 25, 2020

Check in your Board Settings. There is a "Working Days" section. My guess is you need to make changes there to have it display what you want.

Jim Stewart
Contributor
June 25, 2020

Yes, of course. Duh. Just like in Project, you have to convert non-working days to working days to true it up. Should have occurred to me. Thanks.
