What Makro do I Need?
Is there a specific JQL-Code available?
There is no option to do this in Cloud for security reasons, unfortunately.
For server, please find the link:
Let me know if it helped!
https://wiki.softwareplant.com/display/DOCUMENTATION/Integrations#Integrations-Confluencepages
Best&thanks
Karolina
@Dastin_Kuwałek__SoftwarePlant_
Is there any possibility that this will become available for cloud?
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
Hi @Blake Hodder , this is a good question :) However, only Product Management could say more in this case. Please contact Support@SoftwarePlant.com and you will receive more precise response
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
are you using server or cloud?
for cloud: i have never been able to figure this out
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
Hi Ericka, BigPicture/BigGantt gadgets work only for Server.
Cloud has limitations in terms of including external gadgets which are not available as full-jacket addons on the Cloud marketplace.
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
yes, I am aware of this, thank you!
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
Scope change!
We are migrationg from Cloud to Server right now.
So the new answer is:
Server!
I guess the Confluence Macro comes automatically with the big picture installation.
Right?
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
From the Confluence side it requires few steps:
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
I followed these instructions but am getting "Invalid Gadget URL" error when attempting to add the Gadget Specification URL in confluence. Any suggestions please?
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
From the error, it sounds like there is a problem with Jira<>Confluence connection.
To know more I would need to see that stack trace from Jira logs (if any) when you insert the URL in Confluence.
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
Hi Dastin
One of my coworkers investigated and he was able to add the Gadget Specification URL by whitelisting it. That worked, insomuch as the gaddget does now appear as an available macro in confluence.
However we have another issue. When attempting to add the macro to a confluence page, the preview window is blank - see screenshot below.
My coworker investigated further. His full analysis is below. It appears to be an issue with the 'show columns' option, which I verified myself when adding the gadget to a Jira dashboard. Would appreciate if you can take a look.
Thanks.
**********************
*********************************
Analysis from my coworker:

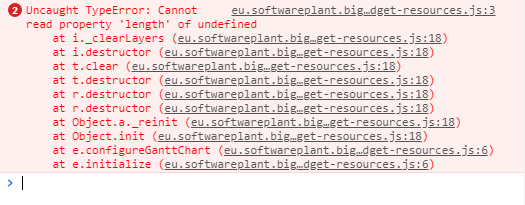

BigGantt is throwing this error when loading in a confluence page:

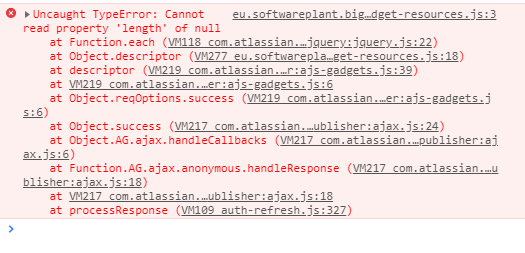

I did some research on it and found this external Jira issue referring to a similar error when using the gadget within Jira dashboards. Following their steps I can replicate it, indicating this is a BigGantt bug. Note, however, that if I delete the gadget in Jira and re-add, it works again. Here’s the error in Jira:
It seems to do with the DisplayColumns option on the gadget. The option doesn’t even appear in Confluence, but is available in Jira. When setting to No at first, saving and then selecting Yes, the gadget dies and you get this error. Now – the Jira issue linked above indicates the item is closed and, presumably, fixed in BigGantt Server version 3.11.0. We have version 4.4.1, so it looks like this bug has come back again.
I’d recommend contacting the vendor about this. We’re on their latest version, everything is whitelisted, the gadget is accessible, but doesn’t work.
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
Hey @Dorian Workman, this is a kick-ass analysis right here! You even found a related issue about this problem :D
At this point, please forward all of this information to SoftwarePlant support (support@softwareplant.com) where it will be passed to our devs teams to get fixed and released :)
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
All credit goes to my co-worker @Taylor Bond for this analysis. I forwarded to your support; Ticket ID is SUPPORT-315076.
Thanks.
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
Hello gents,
I know it's been almost a year and half since this comment was added, but I do have the same problem. My macro window is blank.
Any updates on the ticket you created for this ?
Thank you,
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
Hello @Mehdi Ziza
The issue was resolved. Please check if links and configuration are proper. If yes, please contact our Service Desk. We will ask you for more information/data necessary for further investigation.
