The Atlassian Community Forums are currently in read-only mode. We will be relaunching on a new platform on September 22 (read more here). We apologize for the extended downtime. For concerns or questions, please email communitymanagers@atlassian.com. See you on the other side, on the new Atlassian Community Forums! :)

×

Forums

Articles
Create
cancel
Showing results for
Search instead for
Did you mean:

Dows anyone know how to calculate and display the 'Ideal line'?

Michael Holian
Contributor
June 13, 2025

I've used the Atlassian out of the box 'issues created vs resolved' template to develop a burn-up chart, but I've like to add an 'ideal line', the line you see on the charts that show that if, for example, you want to complete 30 points in 10 days, you should be completing 3 points a day, and the associated line starts at zero and adds three every day until it reaches 30. Has anyone done on of these?

2 answers

Comments for this post are closed

Community moderators have prevented the ability to post new answers.

0 votes
Michael Holian
Contributor
July 8, 2025

did finally get this figured out. I had a little help from Atlassian support, but I definitely had to fill in the blanks. I'll see if I can summarize here:

The 'ideal line' can be calculated after listing all the issues per day, and creating a formula to calculate a running total of those issues:

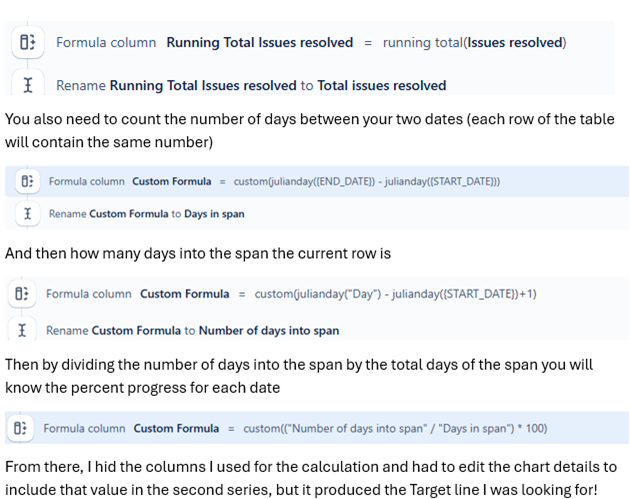

ideal line.png

0 votes
Jessie Turpin
Atlassian Team
Atlassian Team members are employees working across the company in a wide variety of roles.
June 17, 2025

Hi @Michael Holian! If you're still stuck with creating the 'ideal line' I'd recommend creating a support ticket with our team, as we'd be able to access your Analytics instance and could provide more specific recommendations based on your data.
