When you need Jira Plans (and when you don’t): 6 scenarios


At some point, every growing organization faces the same Jira planning problem. Several teams ship in their own spaces, dependencies pile up, and no one has a clean view of the big picture. Jira Plans is the feature many managers reach for at that moment. It pulls work items from multiple boards into one timeline, with capacity and dependency tracking layered on top. Whether it's the right call depends on how your teams actually work. This article walks through the key scenarios where Jira Plans is worth the setup, and a few where it isn't.

Key takeaways

  • Jira Plans is a valuable planning tool for large organizations with projects spanning multiple teams.
  • It is not the best choice for teams with loose workflow coupling, fast-pivoting product work, pre-delivery discovery, and full SAFe rollouts at enterprise scale.
  • A plan depends on the data feeding it. No feature will replace real-time status updates, consistent estimates, and explicitly specified dependencies.
  • Non-technical stakeholders may struggle to see the story behind a plan. Be prepared to add another layer for a strategic overview.

Jira Plans at a glance

Jira Plans (previously Advanced Roadmaps) is a set of cross-team planning features available on Jira Cloud Premium and Enterprise. The Timeline view handles planning within a single space (Jira project), but Plans is built for the case where work spans multiple spaces.



Jira Plans features explained

Feature

What it does

Custom hierarchies

Adds hierarchy levels above the Epic. Useful when teams need containers for a large-scale initiative to sit on top of the standard Epic/Task/Subtask structure.

Dependency mapping

Surfaces blocking and blocked relationships across work items. Dependencies appear as badges or lines on the Timeline, or in a dedicated Dependencies tab.

Capacity planning

Tracks team capacity by hours and days for Kanban boards, or by story points for Scrum boards. Overbooked sprints are flagged.

Release management

Jira Plans supports cross-space releases that align work across multiple spaces.

Scenario planning

Provides a sandbox for testing alternative paths. Adjust dates, resources, and other inputs to compare best-case and worst-case outcomes before committing.

See the Advanced planning overview for more details.

Scenarios when your team needs Jira Plans

Jira Plans pays off when you're running large, cross-team work: a major product launch, a coordinated marketing campaign, a company-wide system rollout, or a market expansion. Here are two clear ways in which a need for such a tool may manifest.

Scenario 1: Cross-team dependencies become a problem

Your backend team has a task to migrate order data into a new database table. The frontend team has to update the orders dashboard to display the new fields. Landing them in the same sprint is ill-advised. But if data is siloed in separate spaces, you don’t have a single source of truth in Jira to flag the issue.

If you somehow caught it, there is another challenge – capacity management. Moving the dashboard update to the next sprint may seem an obvious move. However, you can’t do it unless the frontend team has the capacity to handle the extra task. And that requires separate consideration.

One such conundrum may not pose much of a threat. After all, there is Slack, meetings, and spreadsheets to streamline the process. However, as the number of teams and cross-space projects increases, the risks mount. And one day, the lack of visibility may lead to a missed deadline and a lost business opportunity.

That’s exactly what Jira Plans is for. The Timeline view and the Dependencies tab visualize not only the links within team workflows or projects, but also between them. If you schedule two dependent tasks in the same time period, you will get warnings.

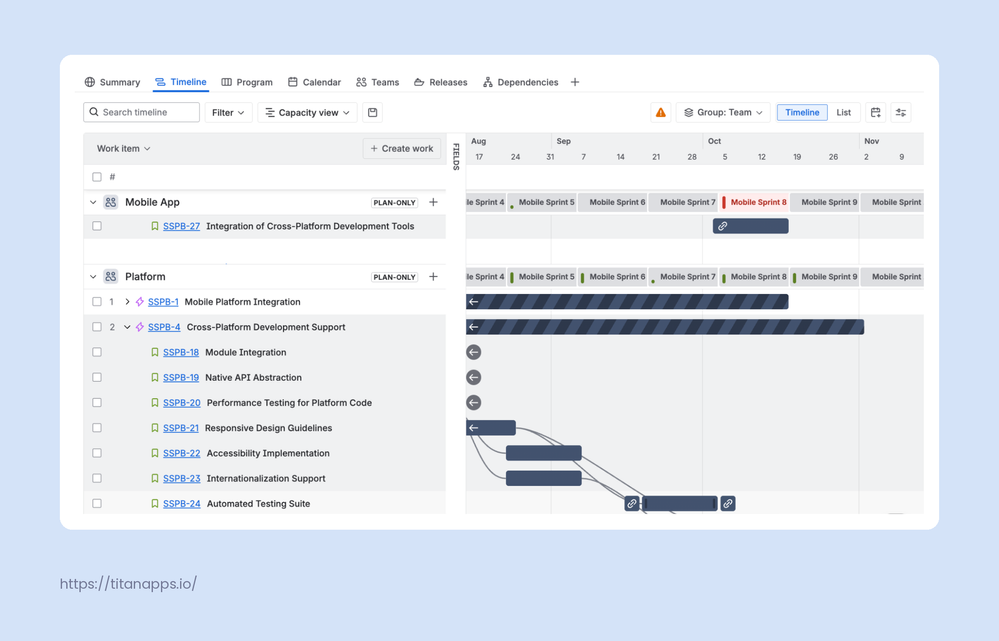

How Jira Plans helps: example

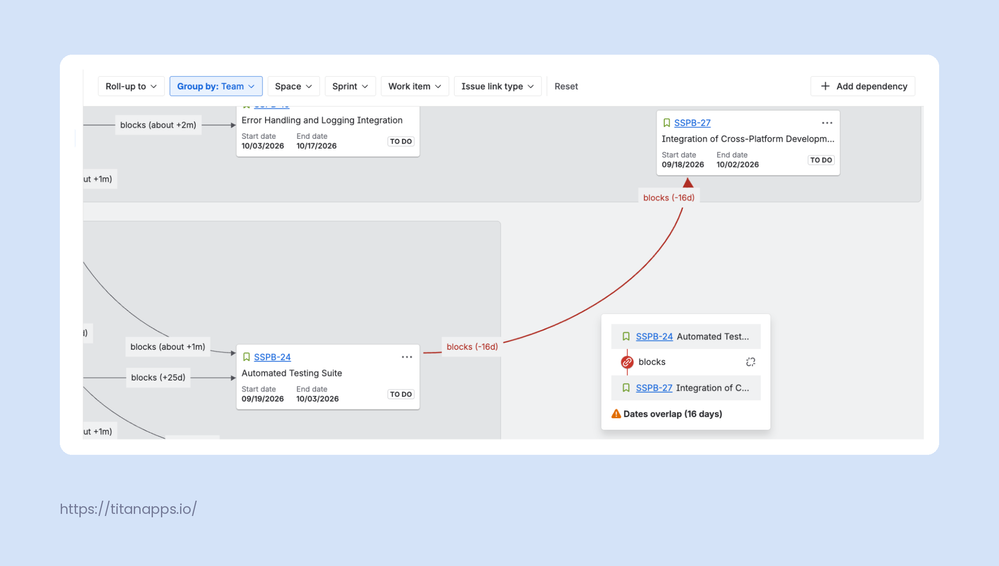

Look at the screenshot below. The Integration of Cross-Platform Development Tools task (Mobile App team) depends on the Automated Testing Suite task (Platform team) being completed first. If their timeframes intersect – say, they are both scheduled for sprint 7 – the link icons and/or the connecting line become red.

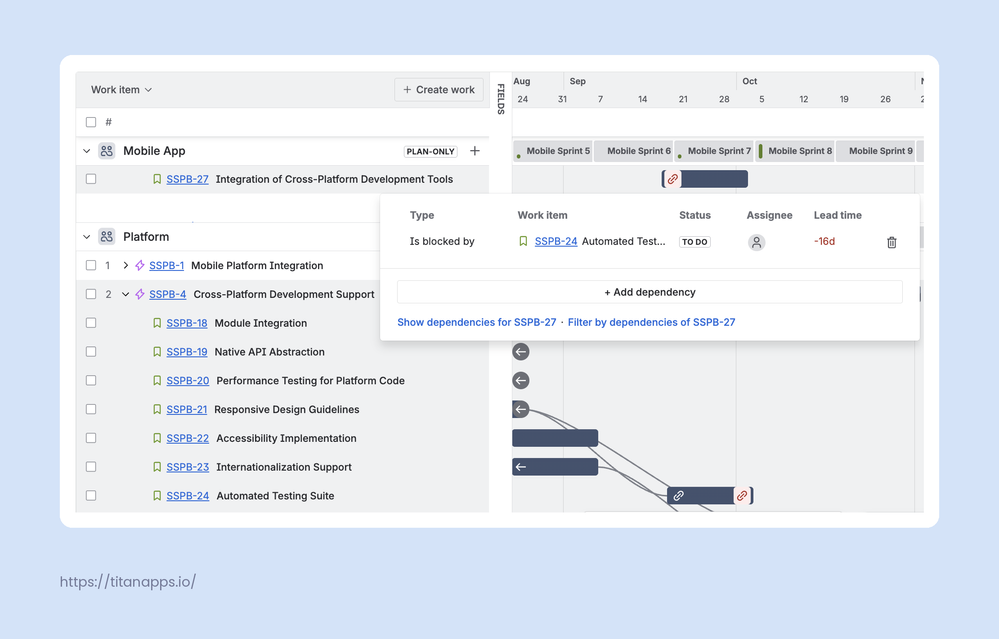

The first instinct is to move the Cross-Platform Development Tools task further, to sprint 8. But it triggers another flag, as sprint 8 becomes overbooked.


Once you reschedule properly, save the changes to push them to the underlying work items. One caveat concerning sprint planning: dragging a work item's bar on the Plans timeline only changes its start and end dates, not its assigned sprint. To update the sprint, either open the work item and edit the Sprint field, or add Sprint as a column on the Plans timeline and change it there.

Scenario 2: Leadership wants rolled-up progress for cross-team initiatives

Once an initiative spans several Jira spaces, status updates become a real challenge. Labels and saved JQL filters help, but the numbers still need to be hand-stitched into a spreadsheet or a presentation.

The Summary view in Jira Plans is the direct answer to this pain. With its help, you can monitor the statuses of all the work items within the given time range, segmenting the picture by projects (higher-level work items) or teams. Also, you can review key dependencies that may delay the progress.

When Plans is the wrong tool

Jira Plans solves a specific problem well, but it's a poor fit in four situations: organizations with few cross-team dependencies, workflows where the plan changes weekly, teams at the discovery stage, and large enterprises that need dedicated PI planning tools.

Scenario 3: Small team or loosely coupled squads

If a quick Slack thread or a 15-minute call resolves your planning questions, Plans is overkill. The real signal isn't headcount or number of teams – it's how intertwined their work is. A company with five product squads, each owning a separate product end-to-end, has five planning surfaces, not one. There's no cross-team picture to assemble because the work doesn't actually cross single-space boundaries.

Scenario 4: Team roadmap shifts every other week

Jira Plans feature assumes the plan is roughly stable for the period it covers. Early-stage products, pre-product-market-fit startups, and teams in active pivot mode rarely have that stability. The roadmap from two weeks ago is now half-irrelevant. Updating dates, reassigning capacity, and re-tagging dependencies will become an excessive administrative burden. If you focus on what the team is working on right now rather than planning, Jira Plans is useless.

Scenario 5: You're still figuring out what to build

Plans is a delivery tool. To assign dates, capacity, and dependencies, you need to know what you are working on. Otherwise, you need an instrument to list and manage product ideas and sketch high-level roadmaps. And Jira Plans wasn’t built for that.


Scenario 6: Full SAFe at enterprise scale

Jira Plans can be configured to support the Scaled Agile Framework (SAFe). In particular, it includes a Program board that shows work and dependencies across multiple teams and is optimized to support Program Increment (PI) Planning rituals, an important part of the SAFe methodology. However, if you want native SAFe support for hundreds of employees, that is beyond what Jira Plans was designed for.

Jira Plans: alternatives and complementary tools

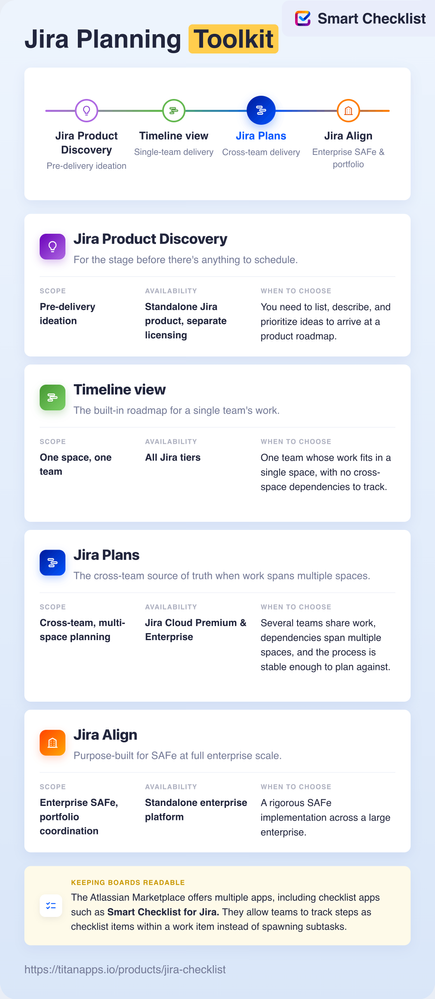

If Jira Plans is the wrong tool for the four situations mentioned above, what is the right one? The sprawling Atlassian ecosystem offers several options. Note that this isn’t exactly an “either-or” question – those are just tools built for different use cases. You can use them both instead of or alongside Jira Plans.

Jira Plans Alternatives (5).png

Jira Plans best practices

Jira Plans has to be used properly to deliver the most benefit for cross-team planning and reporting with minimal administrative overhead. Here are several pieces of advice to point you in the right direction.

Data hygiene is a must

Plans depend on the information in your Jira – statuses, estimates, work item links, etc. – to be correct and up to date. Otherwise, the plan doesn’t reflect reality and becomes either “admin theater” or a weekend cleanup chore for someone.


A few basic rules to start with:

  • Enforce strict hierarchy integrity. Every child item should have a valid parent across the full hierarchy (e.g., Task → Story → Epic → Initiative). Use workflow validations that prevent work from starting or transitioning if a valid parent link is missing.
  • Standardize estimation. If one team estimates in story points and another in hours, aggregating that data becomes impossible. Mandate a consistent estimation model across all teams.
  • Systematize dependency tracking. Ensure teams track dependencies strictly via Jira work item links, not through a mix of spreadsheets, Slack, and meetings.

Decide where estimation happens

Atlassian documents a known inconsistency in how Plans handles estimate rollups. Let’s assume you estimate an Epic at 15 story points and its two Stories each get 5 points from the engineers. The rollup widget will show 10 (5+5 from the children, hiding the parent). However, the progress bar can show 25 (10 from the children plus 15 from the parent). The discrepancy is acknowledged in Track progress using estimates in Plans.

The practical fix is a team-wide rule: estimate at only one hierarchy level. Either the Epic carries the number and the Stories stay unestimated, or the Stories carry the numbers and the Epic stays unestimated. Mixing both creates the double-count behavior.

Plan a translation layer for non-technical stakeholders


The Plans was made for delivery teams. Non-tech stakeholders, however, might see a wall of bars and links instead of a story. Summary view helps, but a completion percentage still needs context. For example, 19% done could mean on track or two sprints behind depending on the timeline. Accept that a shared plan or a summary view alone won’t cut it. Add a brief explanation defining progress, risk, and next steps. Do it weekly in Slack or in Confluence, and stakeholders will have a clear picture.

Account for the team-managed space limits

Plans accepts both team-managed and company-managed projects (spaces) as work item sources, but team-managed ones have three documented limitations inside Plans:

  • Fields created in a team-managed space can't be reused across other spaces in the plan.
  • You can’t “reparent” a team-managed task or story under a parent in a company-managed space.
  • Scope exclusion rules that automatically remove work items don’t apply.

Those limitations might not be deal-breakers, but make sure to account for them if some or all of your teams use team-managed spaces.

Work on visibility

Visibility can become a problem within a single space if it is crowded with multiple Epics, Tasks, and Subtasks. Things may get even more confusing when Themes and Initiatives pile up in custom hierarchies. The level of detail Jira Plans provides gives granular control, but it may be overwhelming even for a seasoned delivery professional.

One way to combat this problem is to declutter the boards by pruning some work items. Atlassian Marketplace offers a variety of checklist apps, such as Smart Checklist for Jira, that let users track steps as checklist items within a parent task instead of creating multiple subtasks.

Learn more about Smart Checklist for Jira

Getting set up

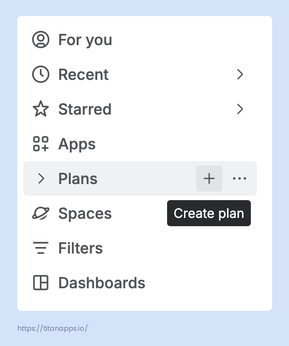

If the decision to adopt Jira Plans is in motion, the setup itself is straightforward. On Premium and Enterprise, Plans appears in the Jira sidebar.

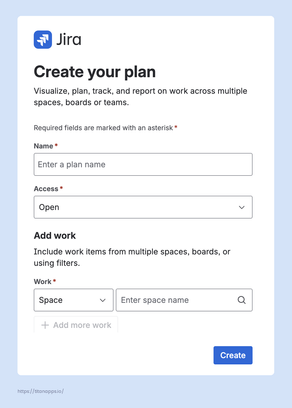

Click the plus icon, and the plan creation form asks for three inputs: a name, an access level (Open or Private), and the work item sources you want to include (boards, filters, or whole spaces).


Two things to know on the first pass:

  • Sources are editable later. The initial scope doesn't have to be perfect. You can add or remove boards, filters, and spaces from the plan settings once you see how the data lands.
  • A sample plan is available. Before building against your real work, Atlassian provides a sample plan with dummy data so you can explore the views, widgets, and scenarios in a low-stakes environment. The View a sample plan page has all the details.

For configuration beyond the basics, the advanced planning guide with tutorials covers teams and capacity, custom hierarchy levels, dependencies, and scenarios in depth. Atlassian also offers a top-level planning template with a preconfigured hierarchy and structure for cross-functional initiatives, providing a faster starting point than building from scratch.

Sum-up: should you use Jira Plans?

Use Jira Plans for project management when several teams share work, dependencies span multiple spaces, and the underlying delivery process is stable enough to plan against. The single source of truth pays for itself in those conditions. Skip it for small autonomous teams, for workflows where priorities reshuffle every week, and for product work still in discovery. It is also not the best choice for enterprise SAFe rollouts, where dedicated PI planning tools handle the scale better.

Jira Plans FAQ

How is Jira Plans different from Jira Product Discovery?

Jira Product Discovery is for the pre-delivery stage: collecting ideas, scoring them, prioritizing what to build, and producing a high-level roadmap. Once the prioritized ideas are linked to delivery work items in Jira, Plans helps coordinate dates, capacity, and dependencies across teams that share the same roadmap.

What plan sizes does Jira Cloud support?

A single Cloud plan can load up to 10,000 work items and span up to 100 spaces, including those pulled in indirectly through boards or filters. Atlassian recommends staying at or below 50 teams per plan and up to four work item sources for clean performance. If you hit the space limit in your plan, they suggest adjusting the board or filter’s JQL to limit the number of spaces. Another alternative is to use exclusion rules to pull in only relevant work items or to move specific items to a different space. Read full details on limits on plan size.

How is capacity calculated in Plans?

In Jira Plans, capacity refers to the number of story points or hours your team can complete in a single iteration. Scrum Teams can use both time-based estimates and story points. For the former, sprint capacity equals the team's weekly capacity (200 hours by default) multiplied by the number of weeks in the iteration. Story points are defined for the entire iteration (30 story points by default). Kanban teams can only use time-based estimates and one-week iterations. They can set the weekly capacity in either days or hours, but you cannot change the iteration length. The full mechanics are documented in Manage capacity in your plans.
