The Time Blind Spot in Jira Product Discovery — and How to Close It

Product teams using Jira Product Discovery are usually great at prioritization.

Ideas are scored by impact, effort, confidence, reach, customer feedback, and business value. Roadmaps become more objective, discussions become more structured, and prioritization decisions are easier to justify.

But there is one dimension that often remains invisible:

Time.

Not deadlines. Not release dates. The actual amount of time ideas spend moving through your discovery process.

Questions like these are surprisingly difficult to answer:

  • How long does an idea stay in review?
  • Which stage creates the biggest delays?
  • How quickly do approved ideas actually reach delivery?
  • Is our discovery process becoming faster or slower over time?

Jira Product Discovery tells you where an idea is. It doesn't automatically tell you how long it has been there. That missing perspective creates a blind spot that affects planning, forecasting, and continuous improvement.

Why time matters in product discovery

Imagine an idea enters your backlog. A product manager reviews it, stakeholders discuss it, and eventually it's approved and added to the roadmap. Everything appears to be moving in the right direction.

Then… nothing happens.

The idea remains in the same status for two weeks. Or four. Or longer. Since the status hasn't changed, nothing draws attention to it. No alert is triggered, and no dashboard highlights that the idea has quietly stopped moving.

When someone eventually asks, "What happened with this feature?", the answer is often based on memory rather than data.

Without measuring elapsed time, it's hard to tell whether the process is working as expected or whether work is quietly piling up. Is the review process taking longer than usual? Are approvals becoming a bottleneck? Has development slowed down? Or has the idea simply been forgotten?

Fortunately, Jira already contains the information needed to answer these questions. Every status transition is recorded with a timestamp — the missing piece is turning that workflow history into meaningful time-based insights.

Your workflow already contains the answers

Every idea in Jira Product Discovery records each status transition together with its timestamp. That history contains everything needed to calculate process metrics such as time spent in discovery, approval time, development time, delivery time, lead time, and cycle time.

The missing piece is turning those timestamps into meaningful measurements.

This is where Time Metrics Tracker comes in. The app analyzes Jira workflow history and calculates elapsed time between the status transitions you define. Because the metrics are based on your existing workflow, there's no need to introduce a new process or ask teams to record additional data.

Setting up meaningful time metrics

Good metrics start with good definitions. A few configuration choices make measurements far more useful.

1. Define start and end statuses

Every metric measures the time between two workflow statuses. For example:

  • Parking Lot → Added to Plan
  • Reviewed by PM → Added to Plan
  • In Development → Ready for Delivery
  • Ready for Delivery → Done

Each pair answers a different business question.

2. Use business calendars

Calendar time and working time are not the same. If your team doesn't work weekends, those hours shouldn't inflate your metrics. Time Metrics Tracker lets you configure working schedules so measurements reflect actual working time rather than elapsed calendar hours.

3. Exclude stages that don't represent active work

Not every workflow status should count. Ideas waiting indefinitely in a backlog or parking lot may be perfectly acceptable. Including those stages in every metric often creates unnecessary noise. Measure only the workflow sections that answer the question you're asking.

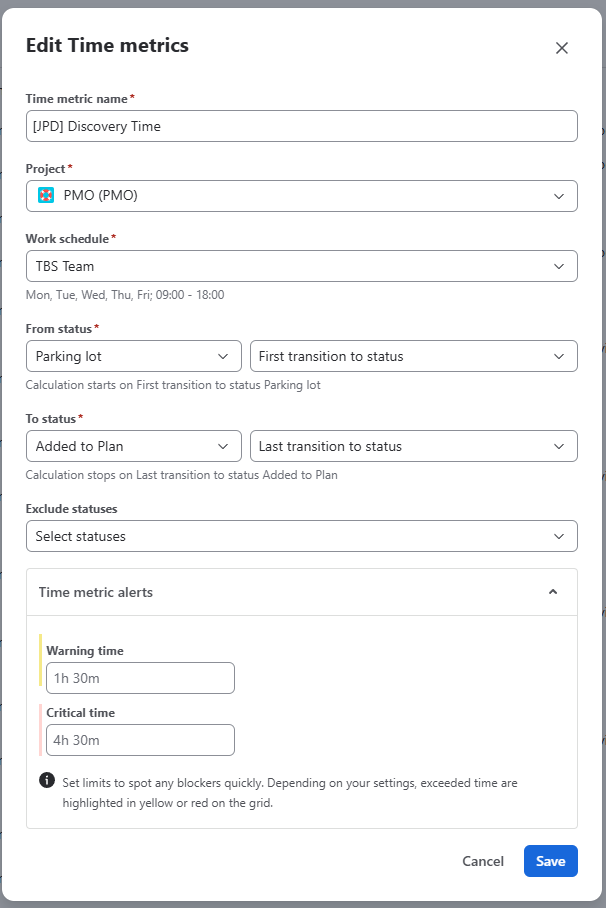

4. Set warning thresholds

Sometimes numbers don't look alarming until it's too late. Configurable warning and critical thresholds make unusually long durations immediately visible, helping teams identify aging work before it becomes a delivery problem.


The metrics every Product Discovery team should track

You don't need dozens of metrics. A small set covers the entire discovery lifecycle.

Metric Status Transition What it Measures Why it Matters
Discovery Time Parking Lot → Added to Plan How quickly ideas move from initial capture into the roadmap. Helps evaluate the speed of idea validation and prioritization.
Review Time Reviewed by PM → Added to Plan The time spent in the decision-making stage. If this rises while others stay stable, approvals — not development — may be the bottleneck.
Development Time In Development → Ready for Delivery How efficiently ideas move through implementation. Helps identify engineering bottlenecks and delivery slowdowns.
Delivery Time Ready for Delivery → Done The final stage before release, including testing and deployment. Highlights delays between completed development and production delivery.
Lead Time First Workflow Status → Done The total time from idea creation to delivery. Shows the complete end-to-end journey of an idea.
Cycle Time Reviewed by PM → Done Execution after an idea has been approved. Helps distinguish slow delivery from slow prioritization.

Group 6273270.png

Once you've configured your metrics, they appear as additional columns directly in your grid. From there, you can sort ideas by any metric in ascending or descending order, quickly identify the fastest or slowest-moving work, and see the average duration for each metric at the top of the column. You can also narrow the view using filters such as labels, assignees, and statuses, or create a selection of ideas for a specific time period to analyze a particular release, quarter, or initiative.

Group 6273271.png

These capabilities make it easy to compare ideas, spot outliers, and understand how different parts of your discovery process are performing — without leaving Jira Product Discovery.

Looking beyond individual metrics with Flow Insights

Once your metrics are in place, you'll have a clear view of how long ideas spend moving through each stage of your workflow. But individual numbers rarely tell the whole story.

A long Cycle Time tells you that delivery is slower than expected, but it doesn't explain why. Is the entire process slowing down? Is one workflow stage creating a bottleneck? Or are only a handful of ideas skewing the average? Finding those answers by sorting columns and comparing individual ideas can quickly become time-consuming.

Flow Insights brings all of that context together in a single view. Instead of looking at isolated durations, you can analyze one metric across a selected project and time period without exporting data or building reports elsewhere.

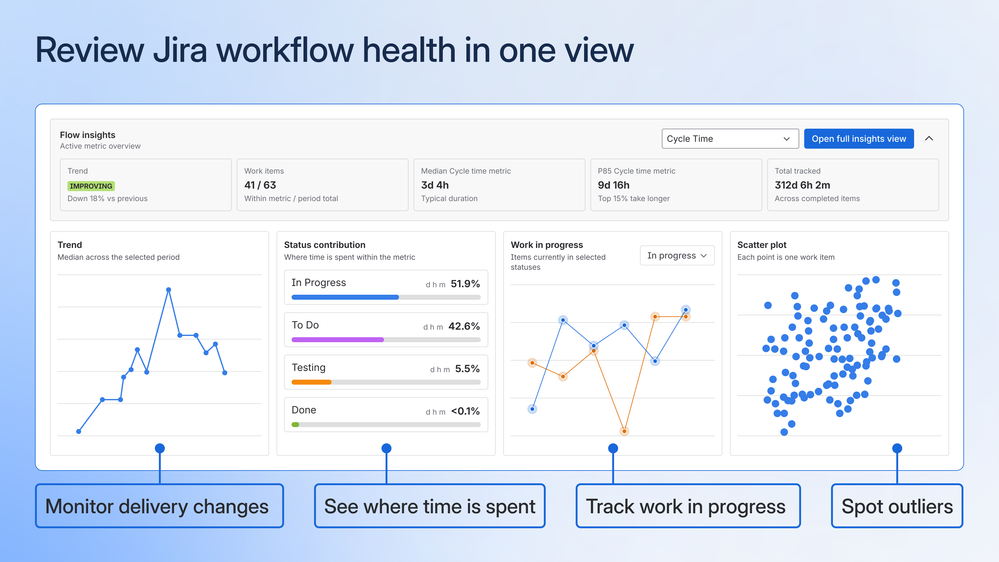

Review Jira workflow health in one view.png

The overview starts with five summary cards:

  • Trend shows whether the selected metric is improving, stable, or worsening over time.
  • Work Items shows how many ideas completed the selected metric out of all ideas in the selected period (for example, 88 / 429).
  • Median represents the typical duration, minimizing the impact of outliers.
  • P85 highlights how long slower ideas take, making it easier to understand the experience of the slowest 15% of work.
  • Total Tracked Time shows the cumulative time recorded for the selected metric.

These indicators provide a quick health check, but understanding why a metric changes requires a closer look. The detailed view includes four visualizations that help uncover where time is being spent:

  • Trend Chart reveals how the metric changes over time, and highlights warning or critical thresholds if they are configured.
  • Status Contribution breaks the metric down by workflow status, making bottlenecks immediately visible.
  • Work in Progress (WIP) shows how many ideas are active over time and how long they have been aging in progress.
  • Scatter Plot plots every idea individually, helping distinguish systemic slowdowns from isolated outliers.

Most charts support drill-down views, allowing you to open the exact ideas behind a trend or bottleneck and investigate them directly in Jira.

A practical example

Imagine you're reviewing Cycle Time for a Jira Product Discovery project and notice that it's 35% higher than during the previous period.

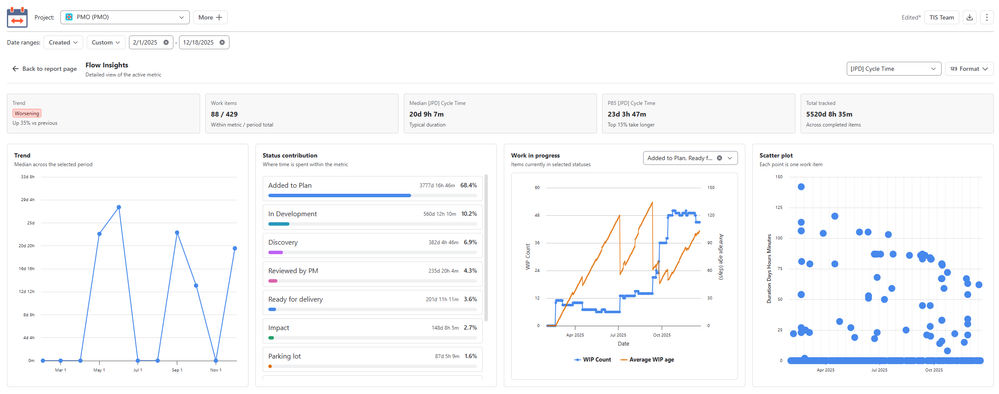

The summary cards immediately provide context. The Trend indicates that Cycle Time is consistently increasing rather than reflecting a one-off spike. At the same time, the Median and P85 remain relatively close, suggesting that the slowdown isn't caused by just a few unusually slow ideas — it affects the overall flow.

Next, the Status Contribution chart shows that nearly 70% of the total Cycle Time is spent in the Added to Plan status. In other words, ideas are being approved but are waiting to enter development.

You don't have to stop at identifying the bottleneck. Click the Added to Plan bar, and Main Delay opens a drill-down showing the exact ideas behind that number. The list includes every idea for which Added to Plan was the longest stage within the selected metric, together with the time spent in that status, the average time per item, and each idea's overall Cycle Time.

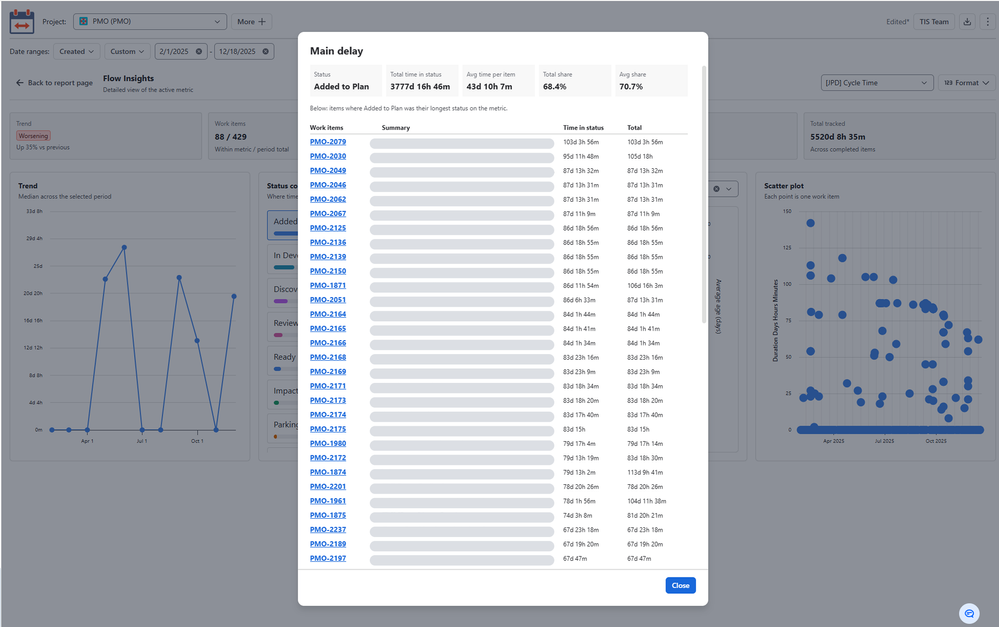

In this example, the average time spent in Added to Plan is around 43 days. The longest single idea sat there for over 100 days, with many others clustered in the 80–95 day range — a large group of aging ideas, not one lone exception. Since every issue key links directly to the corresponding idea in Jira Product Discovery, you can immediately investigate why an idea is waiting, update its priority, or move it into development

Group 6273273.png

The Work in Progress chart reinforces this finding by showing that ideas in the planning queue are aging over time instead of steadily moving forward. Finally, the Scatter Plot confirms that the delay is spread across many ideas rather than concentrated in a handful of exceptions.

Within a few clicks, you've moved from a simple observation — "Cycle Time has increased" — to a clear, actionable insight: ideas are entering the roadmap faster than development capacity can absorb them, creating a growing queue before implementation begins. That's a conclusion backed by workflow data, giving product managers concrete evidence to support planning, prioritization, and capacity discussions.

Closing the time blind spot

Product Discovery already helps teams decide what should be built. Measuring workflow time helps them understand how efficiently those ideas become reality.

By combining prioritization with time-based metrics, product managers can identify slow approval stages, detect delivery bottlenecks, monitor end-to-end Lead Time, catch aging work before it becomes a problem, improve forecasting using historical process data, and make continuous improvements based on evidence rather than intuition.

If you're already using Jira Product Discovery, adding time-based metrics is a simple way to gain deeper visibility into how ideas move through your workflow — and where improvements will have the greatest impact.

Ready to uncover your team's time blind spots? Start with a 30-day free trial of Time Metrics Tracker and explore time-based metrics and Flow Insights using your own Jira Product Discovery data.
