Jira progress tracking seems straightforward when you only need to answer one question: What is the current status of this work item?
But what if you need answers to more detailed questions like:
This is where Jira progress tracking gets more complicated.
Jira shows the history of an individual work item. However, when you need to analyze status changes and completion across multiple work items, checking items one by one quickly becomes impractical.
For teams with organized workflows, delivery targets, or audit needs, knowing that a work item is currently Done isn't enough. You need to understand how it got there.

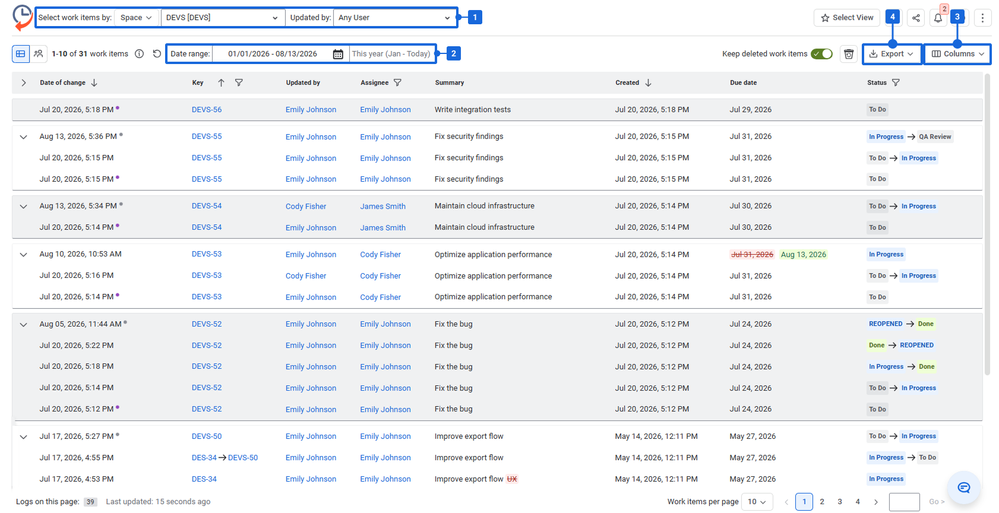

Let's say your project has 500 work items. You can filter them to see which ones are Done, In Progress, or waiting for Review. This gives you a quick view of the project. However, a quick view isn't the same as understanding the history.
Imagine one work item currently shows: Status: Done
That doesn't tell you whether its lifecycle went like this:
Planned → To Do → In Progress → Review → QA Review → Done
or like this:
Planned → In Progress → Review → In Progress → Review → QA Review → Improvement → QA Review → Done → In Progress → Done
Both work items are Done today. But in practical terms, they tell very different stories.
The second item may indicate rework, an unexpected workflow path, a QA problem, or another process issue.

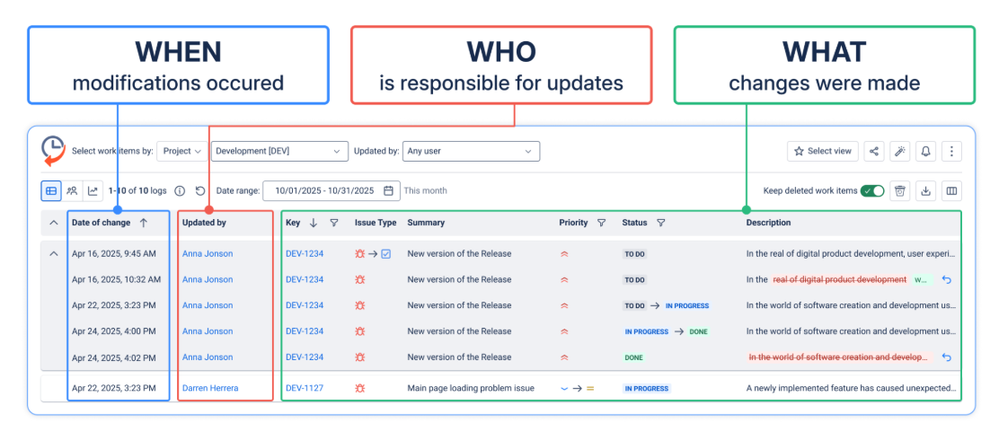

For a single work item, Jira's activity and history information allows you to look into past changes. The problem arises when you need to perform the same analysis for an entire project.
If you have 100 completed work items, manually opening each one and piecing together their status histories is not an efficient way to track progress in Jira. You need to view multiple histories at once.
This becomes especially important when the question shifts from:
“What is the status?”
to:
“How did our work move through the workflow?”
Good Jira progress tracking should do more than just count work items by their current statuses. Looking at historical progress can help answer a variety of questions.
| What to track in Jira | What it tells you |
|---|---|
| Current status | Where the work item is now |
| Status transitions | How it moved through the workflow |
| Completion date | When it actually was done |
| Creation → Done | Total lifecycle duration |
| Time between statuses | Where work spent its time |
| Due date vs. completion | Whether work was completed on schedule |
| Reopened statuses | Whether completed task returned to active work |
| Skipped statuses | Whether the expected workflow was followed |
| Repeated transitions | Where rework may be happening |
These data points give a clearer picture of project progress.
Suppose your company needs every work item to follow a strict workflow. The process shouldn't skip any required stages. Once a work item reaches Done, it shouldn’t be reopened.
Just checking the current status doesn't show if those rules were followed. You need the Jira status history. For example, you may find:
Expected: Planned, To Do, In Progress, QA Review, Done
Actual: Planned, To Do, In Progress, Done, In Progress, QA Review, Done
Now there are important questions to explore.
That's the difference between tracking status and analyzing workflow.
Another important question is: When was the work item actually completed?
A current Done status tells you where the work item is today. The completion date tells you when it reached that point. This becomes especially useful when comparing completion dates with deadlines.
For example:
Due date: May 15
Reached Done: May 19
The Jira work item is currently has the status Done. So, current status report may look perfectly healthy. However, if we explore it in detail, the work item was completed four days after its due date. For delivery analysis, that difference matters.
Completion dates of Jira work items are even more useful when paired with creation dates. Consider this example:
Created: April 2
Completed: April 28
This shows that 26 days passed between the work item entering Jira and moving to Done. But you can dig deeper. What happened during those 26 days?
The work item may have spent:
2 days in Planned
3 days in To Do
5 days in In Progress
11 days in Review
2 days in QA Review
3 days in Improvement
Now, the problem isn't just that the work item took 26 days. The key insight is: almost half of the process was spent in Review. That's something a team can look into.
Checking all work item changes manually can take a lot of time, especially when a project has hundreds or thousands of them.
Issue History for Jira (Work Item History) app makes this analysis much simpler. Instead of opening the History tab for each work item separately, you can create a detailed history report for multiple work items in one place.
You can filter the data you need and review all the changes across the project. The app tracks changes to both standard and custom fields and provides exports in Excel and CSV formats. Exports can also include reports such as field change duration and time in field values.
This lets you quickly prepare data to answer questions like:
Instead of manually reconstructing the history of each Jira work item, you get structured historical data that is easier to review, filter, export, and understand.
Yes. Once you've exported your Jira history report to CSV or Excel, you can use an AI assistant that supports file analysis to find patterns in the data.
For instance, you might upload an exported report to Claude or another approved AI tool and ask it to identify delays, unusual status transitions, reopened work items, or possible workflow bottlenecks.
Important: Before uploading your Jira data to any AI service, you need to check your company's security, privacy, and AI-use policies. Jira exports may contain sensitive business or personal information. Export only the fields needed for your analysis and remove or anonymize confidential data when necessary.
The workflow is straightforward:
This approach changes Jira progress tracking from manually checking individual histories to a more scalable analysis process.
Instead of just asking how many work items are in the status Done, you can explore more valuable questions: were they completed on time, did they follow the expected workflow, where did they spend the most time.
👉 Explore Issue History for Jira on Atlassian Marketplace
The quality of the results depends heavily on the question you ask. Instead of just saying “Analyze this Jira report”, share your expected workflow and clarify what you want to investigate.
For example:
Prompt 1: Find workflow violations

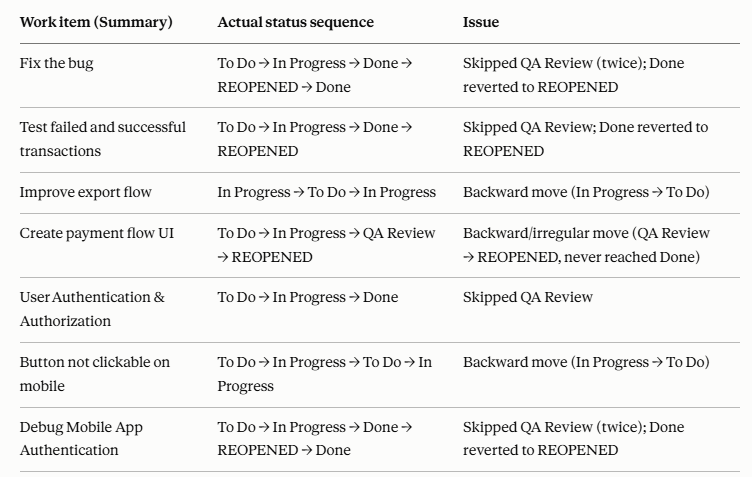

Check this Jira work item history report. The expected workflow in our company is: Planned, To Do, In Progress, QA Review, Done. Find all the Jira work items in the report that skipped a required status, were moved backward in the workflow, or changed from Done to any other status. Provide the work item key, actual status sequence, and the identified issue. Suggest what might have gone wrong.
Prompt 2: Find bottlenecks

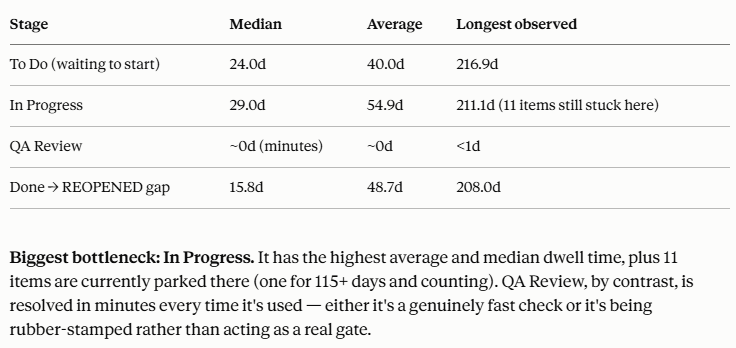

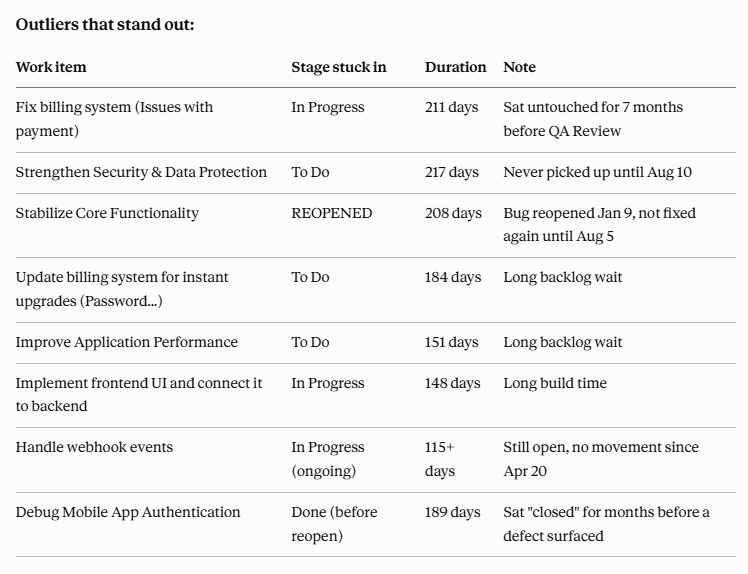

Examine the status history of the Jira work items in this report and identify which workflow stages cause the most delays. Summarize the time spent on work items at each stage where the data allows. Highlight those statuses with unusually long durations. Identify work items that stand out as significant outliers.
Prompt 3: Analyze completion performance

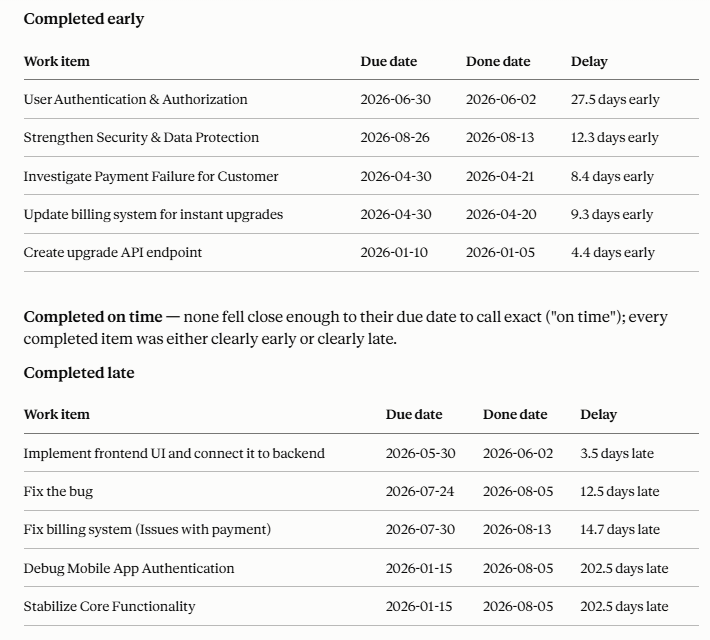

Compare each Jira work item's due date in this report with the date it reached Done. Separate those work items that were completed early, completed on time, and completed late. For overdue work items, calculate the delay where possible and look for common patterns in their status histories.
Prompt 4: Create a management summary
Review this Jira work item history report and prepare a project progress summary for PM in a table format. Include completion performance, overdue completions, reopened work items, skipped workflow stages, repeated status transitions, and the most likely workflow bottlenecks. Give the relevant Jira work item keys for each important finding. Don't make assumptions when the report lacks sufficient data.
Jira progress tracking involves more than just seeing what’s done. Knowing the status changes, completion dates, and time each stage takes helps teams identify delays and workflow problems.
Issue History for Jira (Work Item History) gathers this information from multiple work items. This makes it quicker and easier to analyze progress.
Natalia_Kovalchuk_SaaSJet_
0 comments
