You're on your way to the next level! Join the Kudos program to earn points and save your progress.
Level 1: Seed
25 / 150 points
Next: Root
1 badge earned
Challenges come and go, but your rewards stay with you. Do more to earn more!
What goes around comes around! Share the love by gifting kudos to your peers.
Keep earning points to reach the top of the leaderboard. It resets every quarter so you always have a chance!
Join now to unlock these features and more
The Atlassian Community can help you and your team get more value out of Atlassian products and practices.
Using well-organized and properly maintained checklists in Jira issues can help your team invaluably while struggling to manage and distribute tasks effectively. As with everything in this prone-to-forgetting universe, some crucial tasks that must be completed before marking a given issue as "done" will be forgotten once in a while. As you probably know, even the most detailed and thought through plan means little if not executed due to the faulty of human memory.
With this guide, you will hopefully avoid such a dark fate. It explains how to use Jira issue transition validator, delivered with Multiple Checklists for Jira. Validator ensures that nobody will be able to move an issue to a selected status unless all the checklists' items are complete.

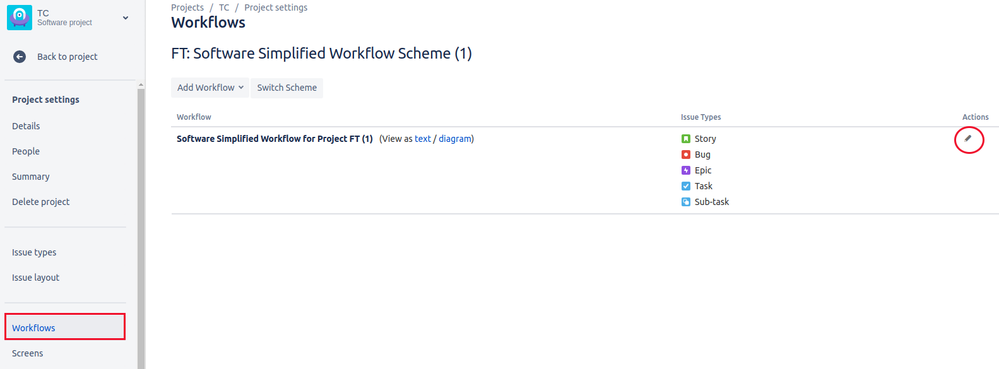

Please note that only the Jira project administrators are able to change workflow configuration and therefore add issue transition validators. If you have the necessary rights, you can find the workflow configuration page in the project settings on the left-hand menu. Go there and click the pencil icon next to the workflow scheme assigned to your project and issue types you want to configure validators for.
Issue transitions are represented by arrows from one ticket status to another. For example, you can have a transition from the “To Do” status to “Done”, as well as a transition from the “In Progress” status to “Done”. Once you have clicked on the transition you want to add validation for, click on the “Validators”.
From the list of all available validators, select the “All checklist items are checked”. That’s all you need to do! Simply click “Add” and your new validator will be added to the selected transition.
Make sure to repeat the above steps for all of the transitions that are meant to be protected. If there are multiple transitions that lead to the “Done” status, and you want to make sure that no issue is moved to “Done” if checklist items are not completed, you should configure the validation for each of those transitions.
Once you have added the checklist validators to all of the transitions you wanted to, one step that remains is to publish the workflow scheme. To do so, click on the “Publish Draft” above the workflow diagram.
Once the adjusted workflow is published, the transitions that had the validator added will not be possible until all checklist items are marked as completed. This won’t affect issues that don’t have any checklists added or that don’t use checklists. Try it out yourself! Add a checklist with some items, and try to move an issue through a transition that is protected with a validator! It should work very similar to the below.
Multiple Checklists for Jira are available on the Atlassian Marketplace for both Jira Cloud and Jira Server. You can also consult our documentation in case of any problems.
