Dependency Management Use Cases in Jira Align

Dependency management in Jira Align handles a couple of scenarios which are listed below.

Dependency between

  • Teams within an ART(Agile Release Train)/Program

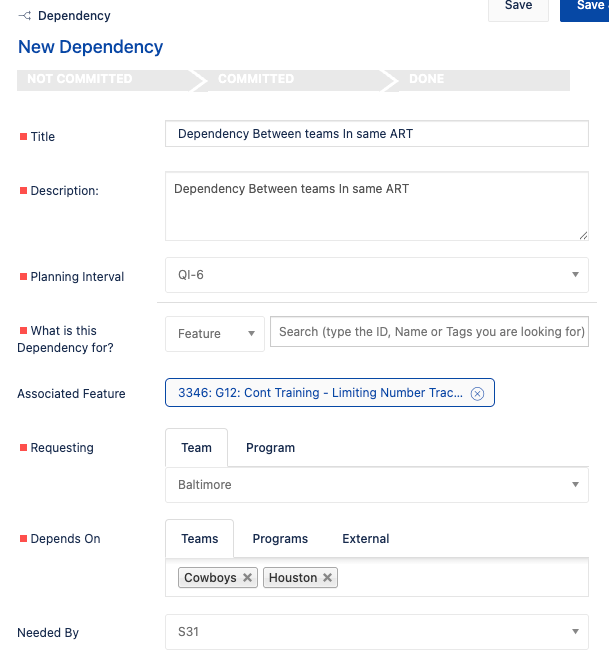

Dependency Between teams In same ART.png

  • Teams from different ART(Agile Release Train)/Program

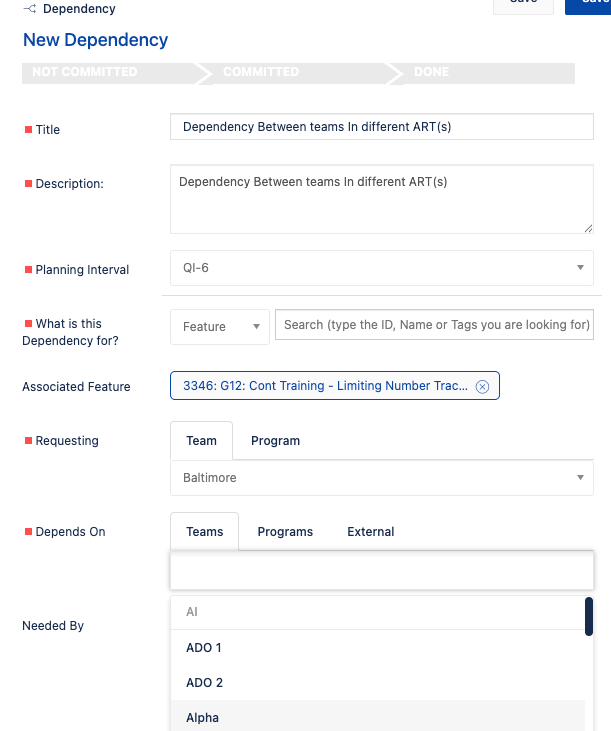

Dependency Between teams In different ART(s).png

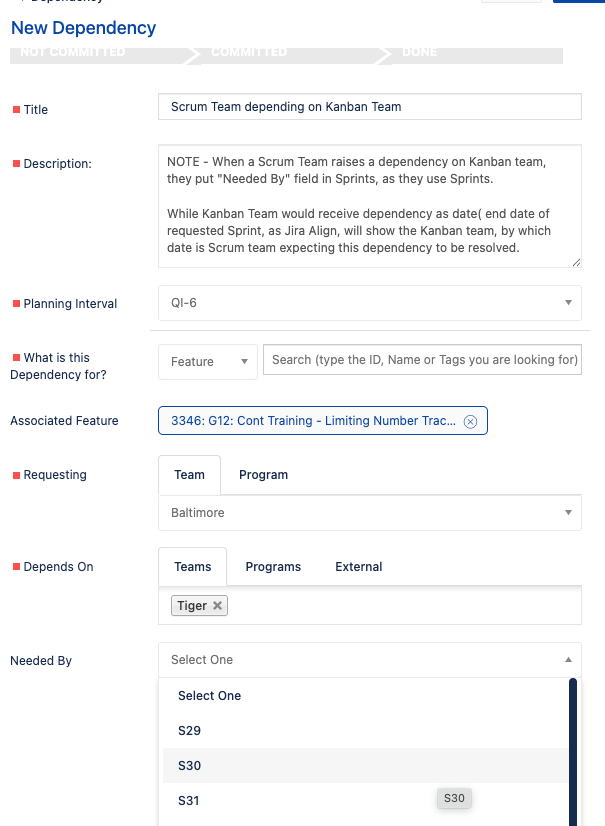

  • Scrum Team depending on Kanban Team within/different ARTs

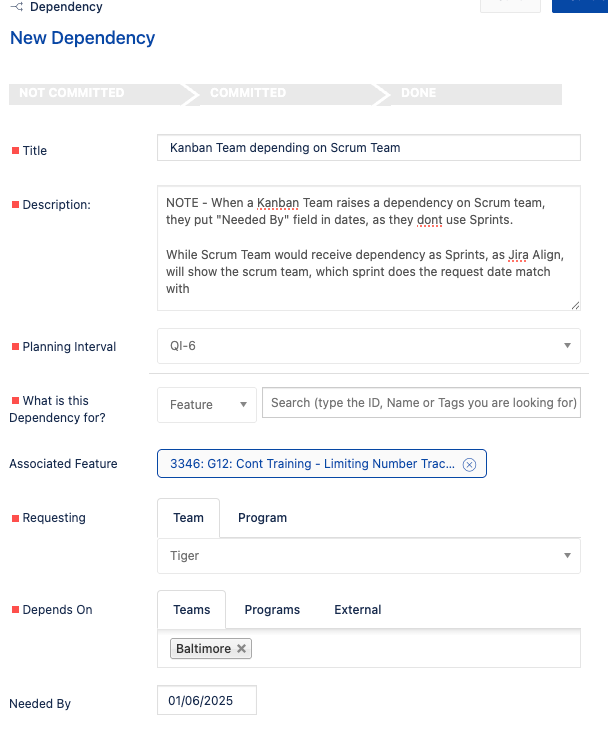

Screenshot 2025-05-21 at 14.38.40.png



  • Kanban Team depending on Scrum Team within/different ARTs

Screenshot 2025-05-21 at 14.36.46.png

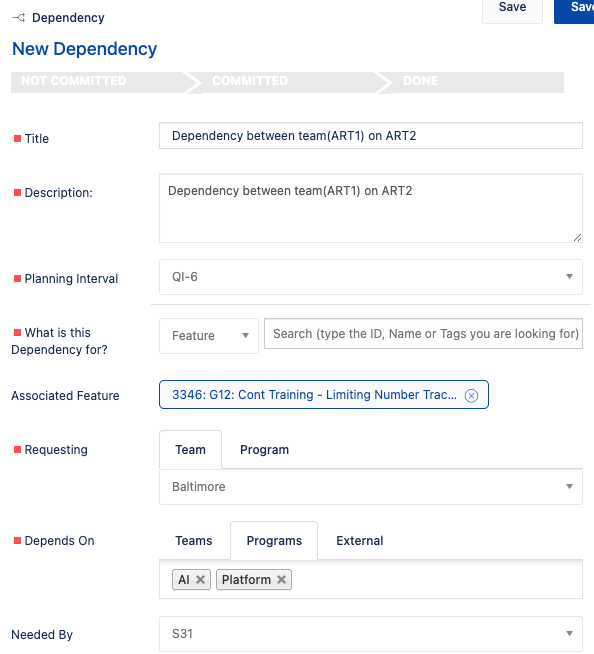

  • Team(ART1) and ART2

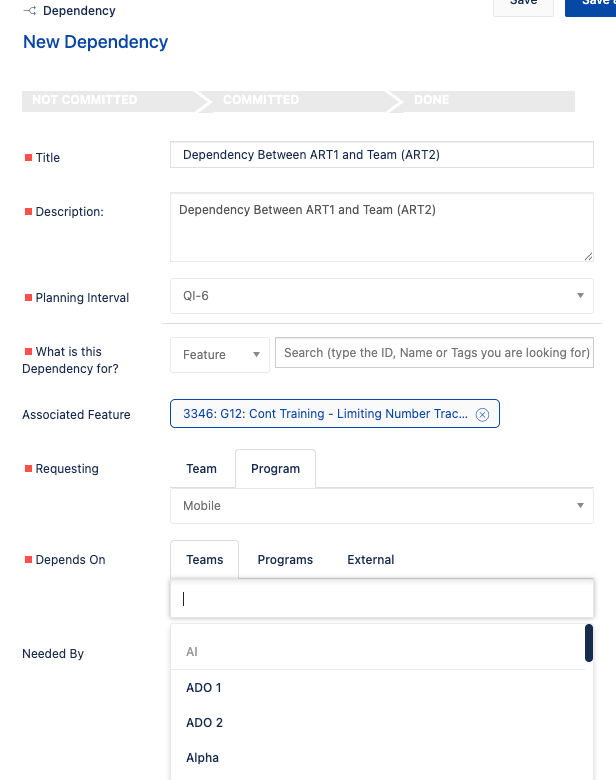

Dependency between team(ART1) on ART2.png

  • ART and Team(ART2)

Dependency Between ART1 and Team (ART2).png

  • 2 ARTs

Dependency between ART1 and ART2.png

  • Team/ART on External Entities like

    • Team not in JA

    • Team/Department not in Jira ( say Finance, HR..)

    • Team working in Scrum

    • Team working in Kanban

    • Team not working in Agile

    • Team not part of an organisation ( say a vendor/supplier)

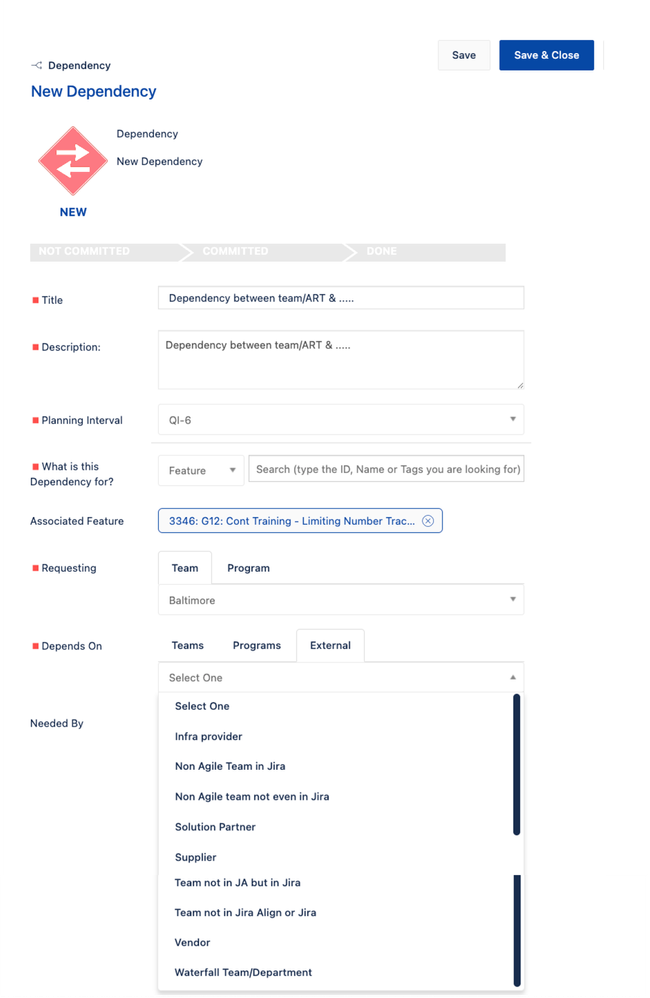

Dependency External.png

All this can be visualized in Jira Align in one place.



Dependency Lifecycle(Happy Flow)

Step1 - Dependency is raised between 2 parties(requestor and respondent).

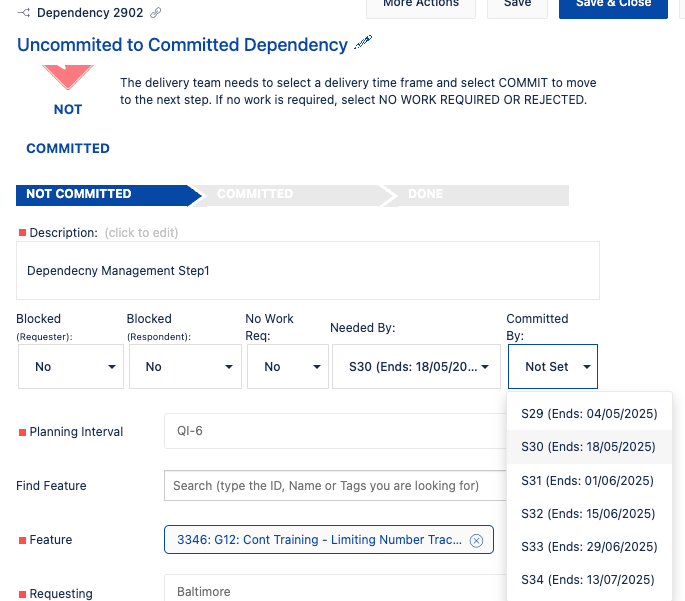

Step2 - Respondent confirms back to requestor on time proposition.

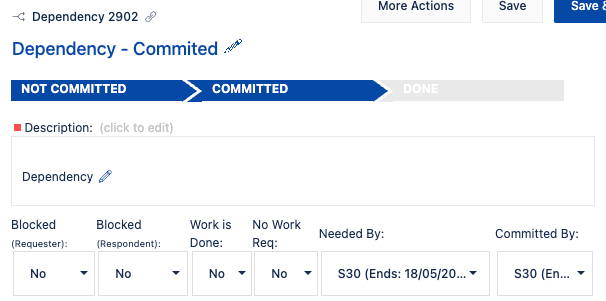

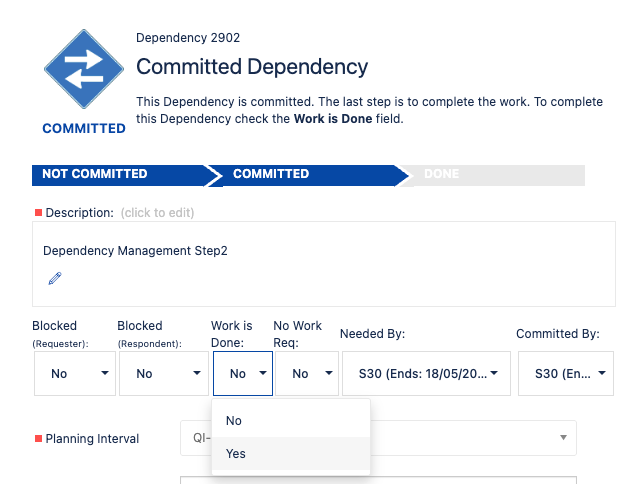

Step2 Committed.png

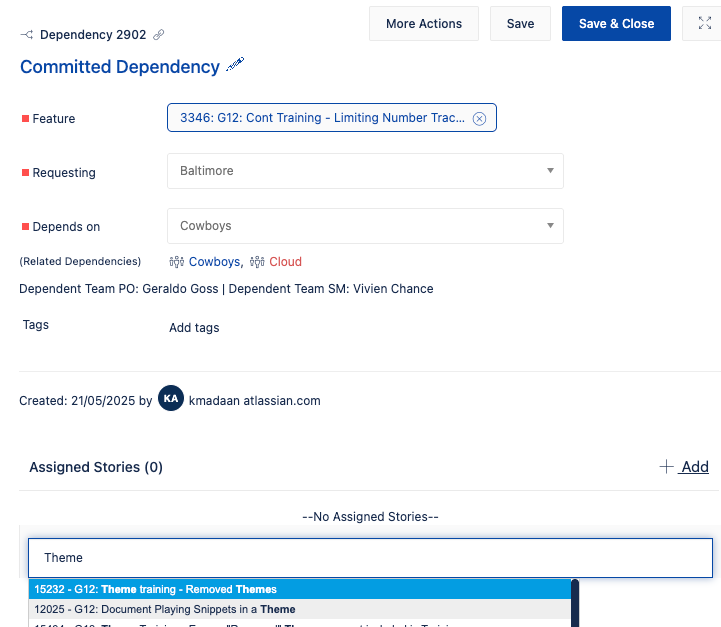

Step3 - Respondent can add work items via which the respondent team is going to resolve the dependency.

Step3 Updates.png

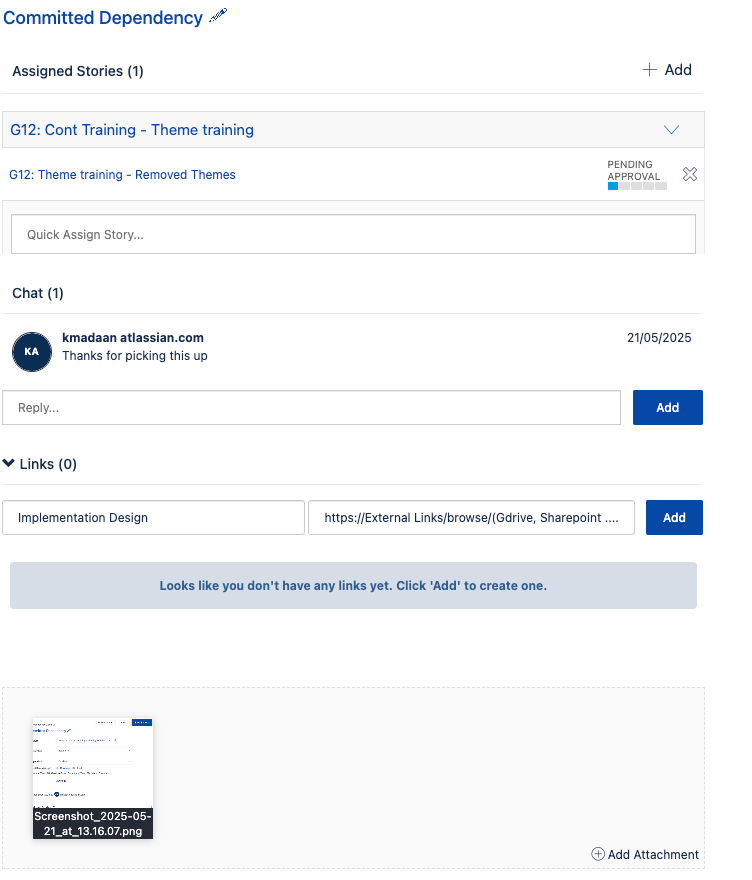

Step4 - Requestor and respondent can chat with each other regarding the dependency, add additional information links, also attachements

Step4 add key elements.png



Step5 - Respondent confirms dependency has been sorted.

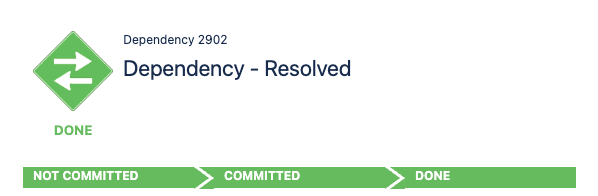

Last Step.png



Step6-  Dependency appears as resolved.
