“We delivered 75 story points, but committed to 60. Velocity is up… or is it?”
For most teams, sprints end with a sense of ambiguity. Success is declared, but when pressed, even seasoned Scrum Masters struggle to articulate what truly worked and what didn’t. Jira burndown charts show progress, but they don't show patterns. Manual reports may track velocity, but rarely explain the why behind performance fluctuations.
This isn’t a tooling work item—it’s a visibility and interpretability work item.
The 17th State of Agile Report highlights that many organizations face challenges in scaling Agile practices, often due to organizational resistance and a lack of understanding among leadership. And yet, these metrics are key to scaling agile maturity.
That’s where two powerful Jira-native tools step in:
Let’s examine how these tools work together to form a comprehensive Sprint Intelligence System.
→ Not just what you did, but what happened, why, and how to improve.

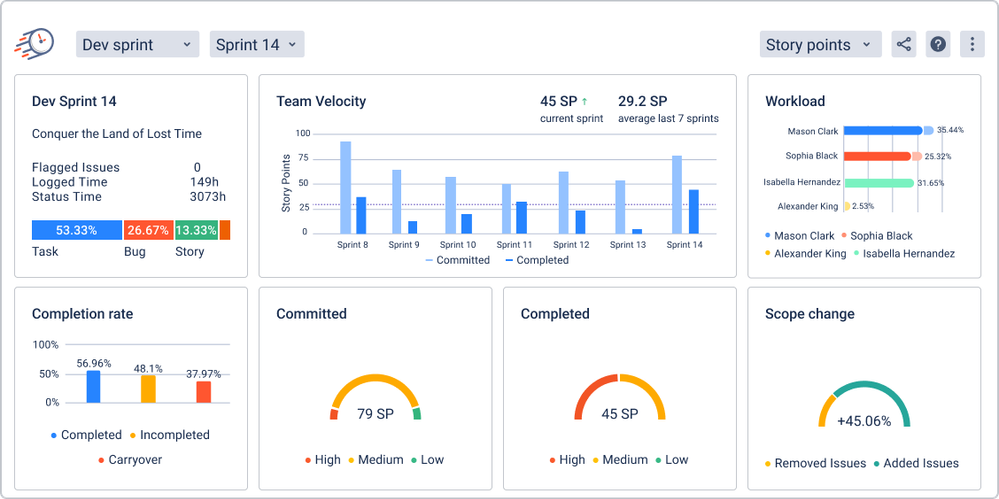

Jira informs you which work items have been completed. The Sprint Report in the Time in Status app tells you what it really took to complete them. It delivers more than just velocity or completion—it gives you a multi-dimensional breakdown of sprint health across seven key performance categories.
The Velocity chart compares committed vs. completed work over the last seven completed sprints, using your board’s estimation method (Story Points, Original Time, or Work Item Count). It also calculates Average Velocity, helping you:
✅ Insight: If your team consistently completes more than what is committed, is that a sign of excellent output or uncontrolled scope additions?
This stacked bar chart illustrates the amount of work committed, added, and removed by each team member, as well as unassigned tasks. It exposes:
Each bar utilizes estimated values (based on the board setting), providing a quantitative view of each person’s sprint journey.
✅ Insight: If one developer has a disproportionate number of added items, they may be compensating for unclear backlog prioritization or task reassignment mid-sprint.
This trio of metrics shows:
It uses formulas to reveal real delivery efficiency:
Completion Rate = Completed / Committed × 100%
Carryover = Incomplete work moved into next sprint / Committed × 100%
✅ Insight: A high completion percentage may appear impressive, but if 30% of the work delivered was added after planning, the metric is misleading. This view restores context.
Displays how much work was added or removed after the sprint began, via a dedicated scope change pie chart. This is crucial for identifying:
The tool even quantifies change as a percentage of committed work.
✅ Insight: If your sprint scope changed by 45%, you aren’t just missing targets—you’re sprinting in shifting sand. This metric helps start the conversation.
Not all work is equal. This chart shows what the team intended to complete, broken down by work item priority. It clarifies:
✅ Insight: Planning sprints with 80% medium-priority work when leadership expects high-priority turnaround? This chart helps catch the misalignment early.
This view focuses on what actually reached completion, again segmented by priority. It enables a direct comparison with committed work.
✅ Insight: If low-priority tasks dominate completed items, it may indicate risk aversion, blockers on critical work, or a lack of alignment between developers and sprint goals.
A pie chart shows the composition of work items (bugs, stories, tasks, etc.) present at the sprint's completion. It’s ideal for understanding:
✅ Insight: If bugs dominate the pie, your team may be stuck in reactive mode rather than progressing product goals.
With these seven sections, the Sprint Report becomes your sprint’s MRI scan—detecting imbalances, tracking historical patterns, and revealing improvement opportunities.
Metric Area |
Question It Answers |
Velocity Trends |
Are we improving over time, or are we overcommitting? |
Workload by Assignee |
Who’s overloaded or underutilized? |
Completion Rate |
Are we reliably delivering what we plan? |
Scope Change |
Is our sprint plan being disrupted mid-cycle? |
Committed by Priority |
Are we committing to the most important work? |
Completed by Priority |
Are we finishing what matters most? |
Work Item Structure |
What kind of work dominates our sprints? |
→ Bring your sprint data to life where your team actually works: the Jira dashboard.
The Sprint Report provides in-depth insight into sprint performance, but it is presented as a static analysis view. What if you want to track those same sprint metrics continuously, or compare multiple sprints, teams, or filters, without rerunning the report?
This is where sumUp for Jira becomes essential. sumUp is a modular dashboard gadget suite that helps you monitor Jira metrics with:
It turns complex Jira filters into immediate, visual answers to critical sprint questions by accessing them through predefined filters or individual custom JQL.
Here’s how.
“How much work was completed in this sprint—and how much was added?”
✅ Insight: Use separate filters for committed vs. added work to track scope creep metrics live, not just in retrospectives.

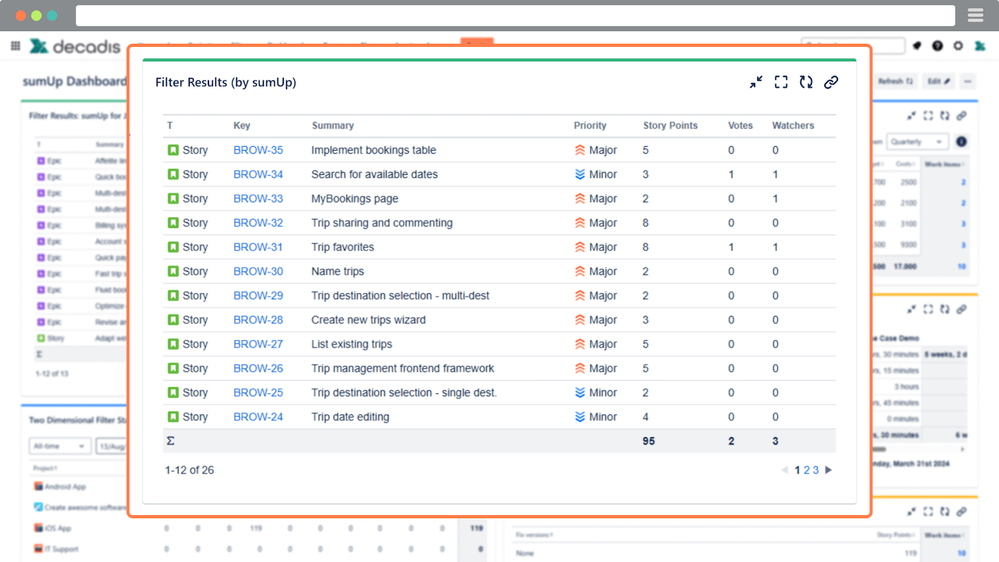

“How is work distributed across team members, priorities, or epics?”
This gadget groups work item values (Story Points, etc.) by a selected field, like:
It’s ideal for comparing totals across categories.
✅ Insight: If 50% of high-priority work items are completed by 2 developers, your team may have uneven knowledge silos or role mismatches.
Ready to check out sumUp for Jira for yourself and click through your first gadget?
“Who’s doing what—and on which types of work?”
This gadget builds a pivot-style table comparing two fields. Examples:
✅ Insight: If QA team members show up heavily under “Story” work item types, your workload classification might be flawed, or your grooming process might be too generic.

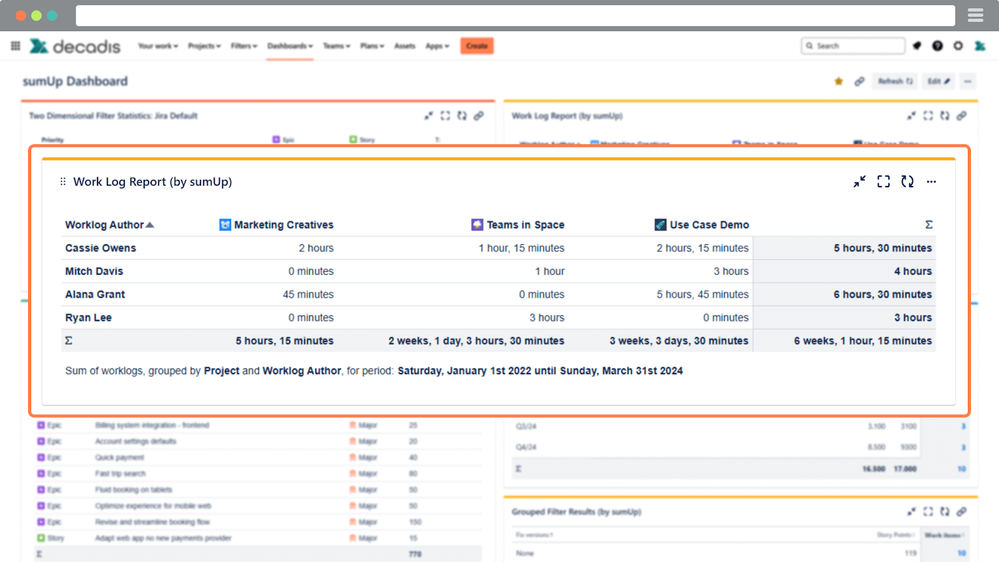

“Where is our time really going?”
This gadget focuses on time tracking. It can:
✅ Insight: If the time spent on medium-priority bugs exceeds high-priority stories, your team might be firefighting instead of progressing roadmap items.
Because sumUp gadgets sit right on your Jira dashboard, they empower you to:
You can track and surface velocity changes by sprint, incomplete work per sprint, and scope change volumes over the past quarter. And additionally, using sumUp for Jira Cloud, your Work Item Navigator transforms into a lightweight reporting tool. Get totals for effort, progress, or any numeric field—automatically calculated and displayed alongside your filtered issues.
✅ Insight: When your completion rate dips, sumUp can show whether it's due to more scope added, less capacity logged, or priority misalignment—because each is visible.
Gadget Type |
Use Case |
Key Benefit |
Filter Results |
Totals and deltas for one metric |
Live sprint scorecard |
Grouped Filter Results |
Per-user or per-epic summary |
Spot imbalance or sprint blockers |
2D Filter Stats |
Task breakdowns across categories |
Analyze focus areas or misalignment |
Work Log Report |
Actual hours spent |
Understand time investment and ROI |
The Sprint Report shows you what happened. sumUp for Jira shows it happening.
And for managers, stakeholders, or agile delivery leads, real-time metrics mean faster feedback loops—and fewer surprises at the end of a sprint.
Use sumUp to:
Time in Status Sprint Report |
sumUp Gadgets |
Structured sprint summary (once per sprint) |
Live, ongoing metric visibility |
Team velocity historical analysis across 7 sprints |
Dynamic comparison across filters |
Root-cause insights into sprint patterns |
Snapshot metrics across teams, sprints, and users |
Together, these tools give you a closed feedback loop: Plan → Monitor → Analyze → Improve → Repeat
You no longer need to manually calculate velocity averages, explain scope changes, or prove workload disparities. The data speaks for itself—clearly, visually, and where it matters.
Agile teams thrive on iteration, but only when each iteration yields meaningful insights.
With the Sprint Report from Time in Status app, you gain insight into what happened. With sumUp gadgets, you stay on top of things as they happen. Together, they help you close the loop between planning, execution, and improvement—the core of agile maturity.
Here’s how to start:
Iryna Komarnitska_SaaSJet_
