The Ultimate Guide to Jira Story Points: From Estimation to Reporting

Ever get that sinking feeling when a stakeholder asks: "So, how many hours will this take?" You know your answer is a complete shot in the dark, a number destined to haunt you in a few weeks. There’s a better way, and it revolves around the story point—the most powerful, and most misunderstood, number in all of agile.

This article will walk you through what they actually are (and why they absolutely crush estimates in hours), how to use them with your team, and how to turn them into predictable reports.

What Are Story Points? (And Why They Beat Hours)

Story point is a single number that represents three things: the amount of Effort involved, the Complexity of the work, and the level of Uncertainty or risk. The best way to understand this is to stop thinking about software and start thinking about … dogs.

Imagine you have to walk three different dogs. A Corgi is a 2-point task. A Golden Retriever is a 5. A Great Dane is a 13. You have no idea if walking the Corgi will take 15 minutes or 30 (depends on the squirrels), but you know for a fact it's way less work than wrangling the Great Dane. That's relative sizing, and it’s the simple, powerful idea behind story points.

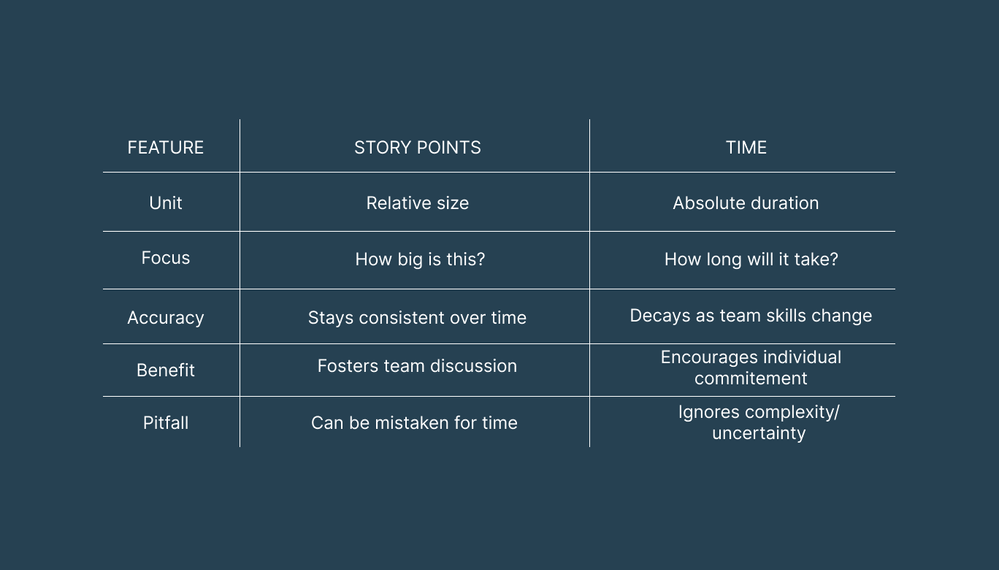

story points vs hours.png

This is why the eternal debate of story points vs. hours isn't much of a debate at all. Let's put them head-to-head:

Time-based estimates are brittle; a senior dev’s “4-hour task” is a junior dev’s “12-hour marathon”. A single unexpected bug can turn your perfect hourly estimate into a punchline. A 5-point story, however, is always a 5-point story to your team, regardless of who works on it. It’s a stable measure of size, not a fragile promise of duration. This allows you to build a reliable team forecast (velocity), focusing on what the team can achieve together, not on holding one person's feet to the fire over a bad guess.

How to Add Story Points in Jira

You open your Jira backlog, ready to start estimating, and... the story point field is nowhere to be found. Don't worry. This is a classic Jira admin puzzle.

  • If you’re the admin, here’s the quick fix: go to Project Settings > Features, enable Estimation. Then go to Work types  and add the Story Point Estimation field
  • If you’re not the admin, just send this paragraph to the person who is—it'll save you both a headache.

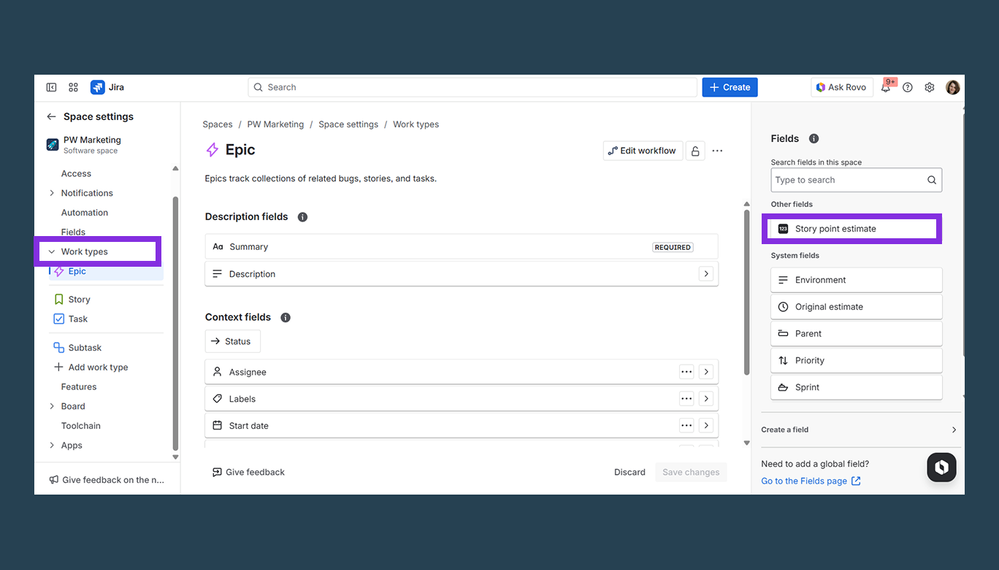

how to add story points in jira.png

How to Use Story Points in Jira

Now for the big question: you can add a number, but which numbers should you use?

Most agile teams use a modified Fibonacci sequence: 1, 2, 3, 5, 8, 13, 20... There's a brilliant reason for this. The gaps between the numbers get bigger as they go up. The jump from a 3 to a 5 is small, but the jump from an 8 to a 13 is huge. This is intentional. It forces your team to acknowledge that the difference between a big task and a really big task is full of complexity and unknown risks. It stops you from agonizing over whether something is a 7 or an 8 and makes you have a real conversation: "Is this an 8, or is it so much bigger that it's actually a 13?"

Some teams start with T-shirt sizes (XS, S, M, L, XL) and assign them point values later (e.g., S=2, M=5, etc.). This is a great way to get your team comfortable with relative sizing without getting hung up on specific numbers. You'll probably want to switch to the number scale eventually, though, because Jira's reports are built to work with numbers directly.

How to Estimate Story Points

Estimation is a team sport. It's not a task where your lead dictates numbers from an ivory tower. The value comes from the discussion, the debate, and the collective "aha!" moment when your quietest engineer points out a massive risk nobody else saw. Here are the two best ways to harness that collective brainpower.

  1. Planning Poker

This is the classic for a reason: it works. Planning Poker is a simple game designed to force a conversation and get everyone's perspective on the table. While Jira doesn't have a built-in poker tool, the process is what matters. On your next sprint planning call, try this:

  1. Your Product Owner presents a single story, explaining the "what" and the "why".
  2. The development team asks clarifying questions. "Does this need to work on Internet Explorer?", "Is the API for this already built?" This is where assumptions go to die.
  3. Once the discussion dies down, everyone decides on their own story point estimate. On the count of three, everyone reveals their number at the exact same time. You can hold up fingers, type it in the Zoom chat, or use a free planning poker web app. The simultaneous reveal is non-negotiable.
  4. Did you get all 5s? Great, put a 5 on the Jira issue and move on. But what if you got two 3s, three 5s, and one 13? You don't just average it out. You ask the 13-voter and a 3-voter to explain their reasoning. This is the most valuable part of the entire ceremony. The 13 knows something the 3s don't, or vice-versa.
  5. After the discussion, you vote again. Repeat until the team's votes converge on a single number.
  1. Asynchronous Estimation

What if your team is spread across six time zones? Getting everyone into a "poker" meeting is a nightmare. This is where you can use Jira itself to run the process asynchronously. It's less collaborative in real-time but monumentally more efficient.

  1. Your team lead or Product Owner picks a handful of stories from the top of the backlog that need estimating. In the comment section of each issue, they tag the entire dev team with a simple message: "Time to estimate this one. Please leave your vote and a quick reason".
  2. Over the next day, each team member reviews the story on their own time. They leave a comment with their estimate and a one-sentence justification. For example: "Voting 5. The front-end work is simple, but the database changes feel risky".
  3. The team lead checks back in. If the votes are all close (e.g., a mix of 5s and 8s), they can make a judgment call (rule of thumb: take the higher number), update the story point field, and move on. If there’s a massive gap (a 2 and a 13), the lead tags just those two developers in a threaded comment: "@Charlie you voted 2, @Dana you voted 13. Can you two quickly sync up here and figure out why you're seeing it so differently?" This turns Jira into a focused forum, saving the entire team from another meeting.

Where to See and Track Story Points in Native Jira

So, your Jira issues are now beautifully adorned with little numbers. Now what? This is the part where your effort pays off, turning abstract points into a powerful tool for planning and prediction. Here’s where to look.

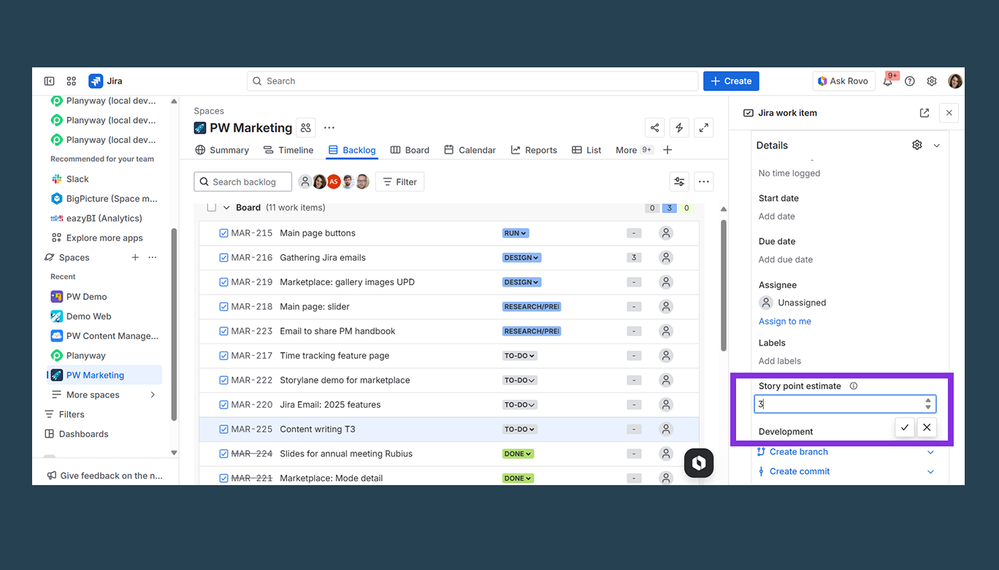

how to see story point in jira.png

First up is The Backlog View. As you drag issues from your backlog into the "next sprint" panel, watch the top of that panel. You’ll see Jira automatically add up the story points for you. This simple-but-mighty total is your first check. If your team usually completes about 30 points per sprint and that number is creeping up to 50, you have a visual warning right there that you're trying to defy the laws of physics.

Once the sprint begins, you’ll spend most of your time on The Active Sprint / Board. Look at your cards. You should see the story point value displayed in a small circle on each one. This isn't just decoration; it's a constant, at-a-glance reminder of the "weight" of each task. During your daily stand-up, it provides instant context. "I'm still working on this 8-pointer" means something very different than "I'm still working on this 1-pointer".

Jira's Built-in Reports is where your story points transform from simple labels into a crystal ball for your project. There are two reports that you absolutely need to know:

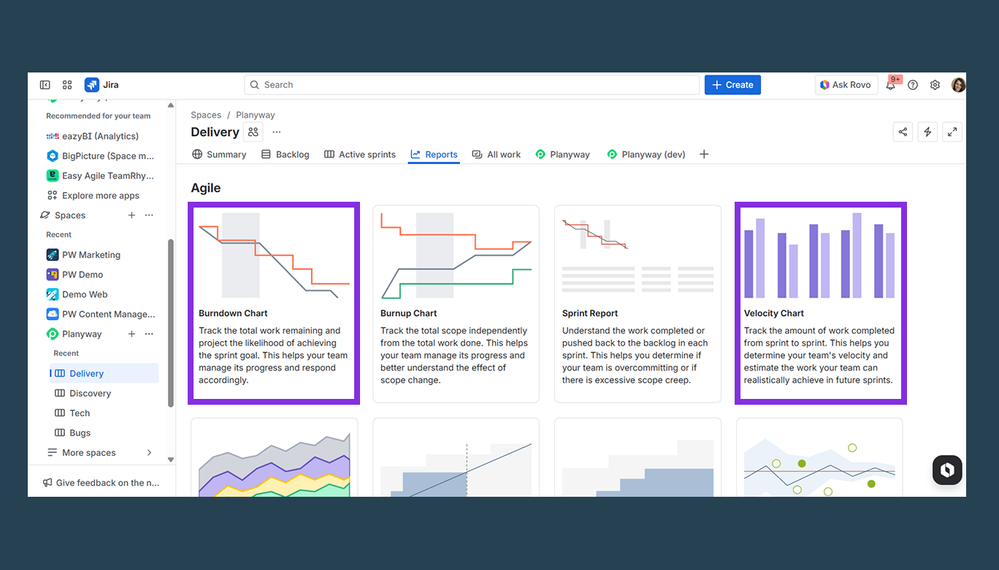

jira story points report.png

  1. The Burndown Chart

It shows a simple line graph: the gray line is the "ideal" path, showing a steady burn of story points to zero by the end of the sprint. The red line is your team's actual progress as you complete issues. If your red line is hugging or staying below the gray line, you're in great shape. If it's floating way above, it’s a clear signal that you’re falling behind and need to have a conversation about what's blocking the team. It answers one question, and one question only: Are we on track to finish this sprint?

  1. The Velocity Chart

If the Burndown Chart diagnoses your present, the Velocity Chart predicts your future. This simple bar chart shows the total number of story points your team actually finished in each of the last several sprints. Below the chart, Jira calculates the average. That number—your average velocity—is the most valuable planning metric you have. If your team's average velocity is 32, then you know you can confidently commit to about 32 points of work in your next sprint. This is how you stop making promises and start making plans.

How to Assign Story Points in Jira and Visualize Them with Planyway

Jira’s reports are godsends for looking back and telling you how you did. But what about right now, in the middle of a chaotic sprint planning session? Proactively managing your team's workload is another story. It's shockingly difficult to see who is working on what points, who is swamped, and who has room. It's exactly where Planyway steps in.

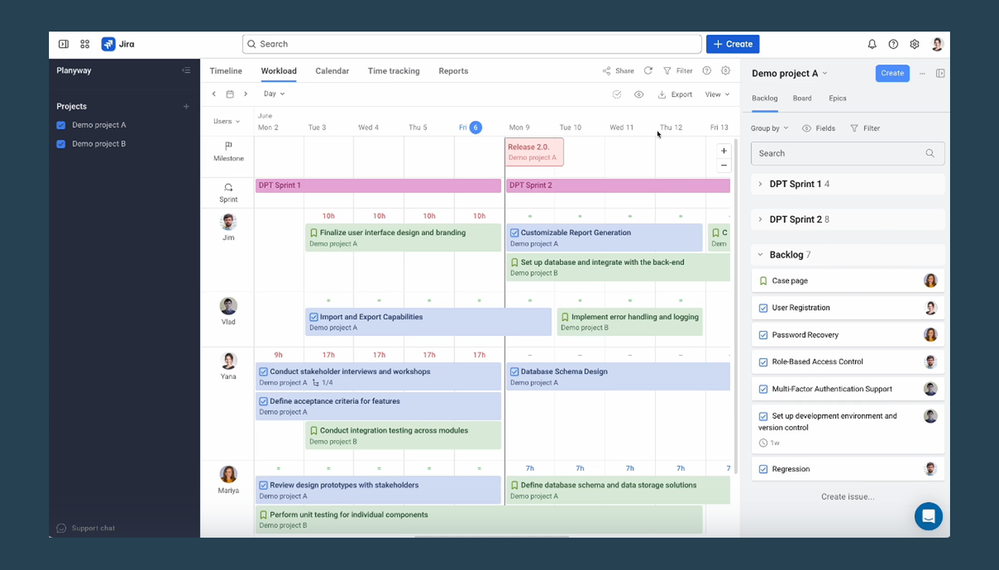

 planyway for jira story points.png

Planyway lays out all your Jira issues on a visual timeline to see when things are planned to happen along the sprint and who is working on them.

You can set a capacity for each person, mark vacations and get a workload view to distribute work accordingly. As you drag and drop issues onto the timeline to assign work, you see the capacity bar fill up in real-time. If you assign too many, the bar turns red, instantly warning you someone is over-allocated.

Story Point Best Practices and Common Pitfalls to Avoid

You've got the theory, you've got the tools. Now, let's talk about how to do this right, because it's frighteningly easy to do it wrong.

DO:

  • Find a simple, well-understood task that everyone on your team agrees is a "2." This is your baseline. Every other story is now just a question: "Is this new story smaller, bigger, or about the same as our baseline '2'?"
  • Be boringly consistent. A "5-point" story should feel roughly the same size this sprint as it did three sprints ago. If you feel your scale is drifting, take a moment to re-establish your baseline and get everyone back on the same page.
  • Involve the whole team. The final number must be a consensus agreed upon by the people who will actually do the work. The insights from your QA engineer are just as valuable as the ones from your senior backend developer.

DON'T:

  • Ever, ever, ever equate story points to hours. The moment someone on your team says, "So, one point is about four hours, right?" you must politely but firmly shut it down. That thinking taints the entire process, turning a relative estimate back into a time-based promise and sucking all the value out of the system.
  • Use story points to judge individuals. This is the fastest way to destroy psychological safety and turn estimation into a political game. Story points measure the size of the work, not the speed of the worker. They are a team planning tool, period. If you use them to compare developers, your team will start sandbagging estimates to look better, and your velocity chart will become worthless.



The Biggest Pitfall Everyone Faces

Sooner or later, it will happen. You'll get to the end of a sprint with a 13-point monster of a story that's half-finished. What do you do? Do you carry over the full 13 points to the next sprint's plan, or do you re-estimate the remaining work (maybe it's an 8 now)?

Here are the two schools of thought, and my take on which one is better.

  1. You keep the original 13 points. The story wasn't "Done", so you got zero points for it in the last sprint. You get the full 13 points when you finally finish it in the next sprint. This keeps your velocity pure and brutally honest—you only get credit for what you completely finish.
  2. You re-estimate the work that's left. The team feels there are about 8 points of work remaining, so that's what goes into the next sprint's plan. This gives you a more accurate picture of the actual capacity being used in the new sprint.

My opinion? Stick with Camp #1.

While it feels "wrong" to not get partial credit, re-estimating inflates velocity and hides problems. It makes it look like you're getting more done than you are. Keeping the original estimate is a powerful incentive for the team to break down huge stories into smaller, completable chunks. If you're constantly carrying over half-done 13-point stories, that's not a velocity problem—it's a sign you need to write better, smaller stories. Don't fudge the numbers; fix the root cause.

Conclusion

Story points are a team-based measure of effort, not a promise of time, and when used correctly, they are the key to predictable delivery. Jira gives you the basic building blocks to track points and generate backward-looking reports like Velocity and Burndown charts. But to truly master your workflow, you need to see your plan in real-time. Tools like Planyway bridge that critical gap, turning your story point data from a report into a dynamic capacity planning tool that prevents burnout and keeps your sprints on track.

What's your team's #1 golden rule for story point estimation? Share your best practices in the comments below.
