The Sprint That Looked Successful — and Quietly Ruined the Next Three

Some sprints look great on paper. The burndown ends where it should. The completion rate is strong. Velocity is healthy. The team closes the sprint, the retrospective is short and positive, and everyone moves on.

Then, three sprints later, the team is behind on everything.

Velocity is unstable. Bugs are increasing. Carryover is growing. Two developers seem permanently overloaded. The team starts asking the usual retrospective questions: Did we overcommit? Did priorities change? Did something unexpected happen?

Sometimes the answer is yes.

But sometimes the problem started much earlier, inside a sprint that everyone thought had gone well. More specifically, it started on the last Friday of that sprint, when several “almost done” issues were moved to Done at 4:45 PM. Jira recorded the success. The Sprint Report recorded the completion. The burndown looked green. But the work was not actually finished.

By Monday, some of those issues were back in progress. By Wednesday, they had created new bug tickets, follow-up tasks, and “quick fixes.” By the next sprint planning session, the team was already carrying over work from the sprint they had just celebrated.

That is the uncomfortable part: the velocity was real, but the completion was fragile.

image 1 art.png

The Problem with a Sprint That Looks Too Successful

A sprint can look successful because the right number of issues reached Done. That does not always mean the work is truly complete, stable, tested, or free from hidden follow-up.

This is not about blaming teams or accusing anyone of gaming metrics. In most cases, nobody is being dishonest. Teams are simply responding to the system around them.

If the main question at the end of the sprint is:

“Did we complete the committed work?”

Then teams naturally optimize for completion.

If the board, report, and stakeholder conversation all focus on whether issues reached Done, then reaching Done becomes the visible goal. Quality of completion becomes harder to see.

That is how a sprint can close with 92% completion, strong velocity, and a green burndown while quietly creating problems for the next three sprints.

The issue is not that the sprint data is wrong. The issue is that most teams stop reading the data too early.

Sprint Boundaries Create a Psychological Reset

Sprint boundaries are useful. They help teams plan, focus, and reflect. But they also create a strange blind spot.

Once a sprint ends, the team mentally resets. Sprint N is complete. Sprint N+1 is a new plan. New goals, new issues, new commitments.

That reset can make cause and effect harder to see.

A rushed issue closed at the end of Sprint N may create bugs in Sprint N+1. The repair work may push planned work into Sprint N+2. By Sprint N+3, the team finally feels the accumulated pressure but no longer connects it to the “successful” sprint that created the debt.

The timeline looks like this:

Sprint

What the team sees

What may actually be happening

Sprint N

Strong completion, good velocity, green burndown

Some work is rushed to Done late

Sprint N+1

Bugs and follow-up tasks appear

Deferred work comes back under new labels

Sprint N+2

Carryover increases

Team is still absorbing the repair work

Sprint N+3

Delivery feels unstable

The original debt has compounded

This is why some retrospectives miss the real story. Sprint N’s success and Sprint N+1’s struggle feel like separate events. In the data, they may be connected.

image 2 art.png

The Friday Afternoon “Done” Pattern

A useful place to look is the final 24 hours of a sprint. Not because late completion is always bad. Many teams finish work near the end of a sprint, and that is normal.

The warning sign is different.

Look for issues that were moved to Done near the end of the sprint and then quickly moved backward, reopened, or replaced by bug tickets and follow-up tasks in the next sprint.

This pattern often looks like:

  1. Several issues were moved to Done late on the final day.
  2. The sprint closes with strong completion.
  3. The same issues return to In Progress, Review, or QA shortly after.
  4. New bugs or follow-up tasks appear in the next sprint.
  5. The original assignees spend much of the next sprint repairing work that was counted as complete.

The team may describe Sprint N+1 as “interrupted.”

But the interruption was not random. It was created by unfinished work from the previous sprint.

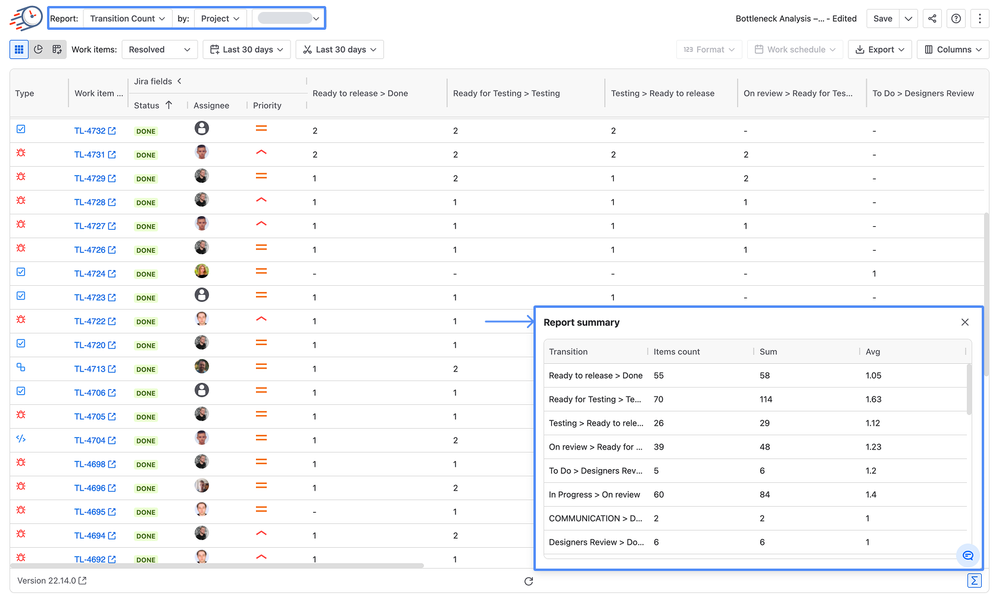

Signal 1: Transition Count Shows Work That Came Back

The first signal is the Transition Count report.

A normal sprint has some movement between statuses. That is expected. Work may go from In Progress to Review, from Review back to In Progress, from QA back to Development, and so on.

But when issues that reached Done move backward shortly after the sprint close, that is worth attention.

A high number of backward transitions in Sprint N+1 can reveal that some of the work in Sprint N was not truly finished. This is especially important when the backward moves are concentrated around issues closed near the end of the previous sprint.

The question is not only:

“How many issues did we complete?”

The better question is:

“How many completed issues came back?”

That one question completely changes the retrospective.

A sprint with high completion and low backward transitions is probably healthy. A sprint with high completion and high backward transitions may have simply pushed unfinished work into the future.

Signal 2: Scope Change Reveals the Follow-Up Work

The second signal is Sprint Scope Change.

When a team adds work during Sprint N+1, it is easy to call it an interruption, stakeholder pressure, or changing priorities. Sometimes it is. But sometimes those added items are actually the consequences of rushed completion in Sprint N.

They appear as:

  • bug tickets
  • quick fixes
  • missed edge cases
  • follow-up tasks
  • “small cleanup” items
  • urgent support requests

On paper, they are a new scope. In reality, they may be unfinished work wearing a different label.

This is where Sprint Scope Change becomes more than a planning metric. It helps explain whether the next sprint was disrupted by truly new work or by repair work from the previous sprint.

If a scope change spikes right after a “successful” sprint, it is worth asking:

“How much of this added work is connected to issues we marked Done last sprint?”

That question is uncomfortable, but useful.

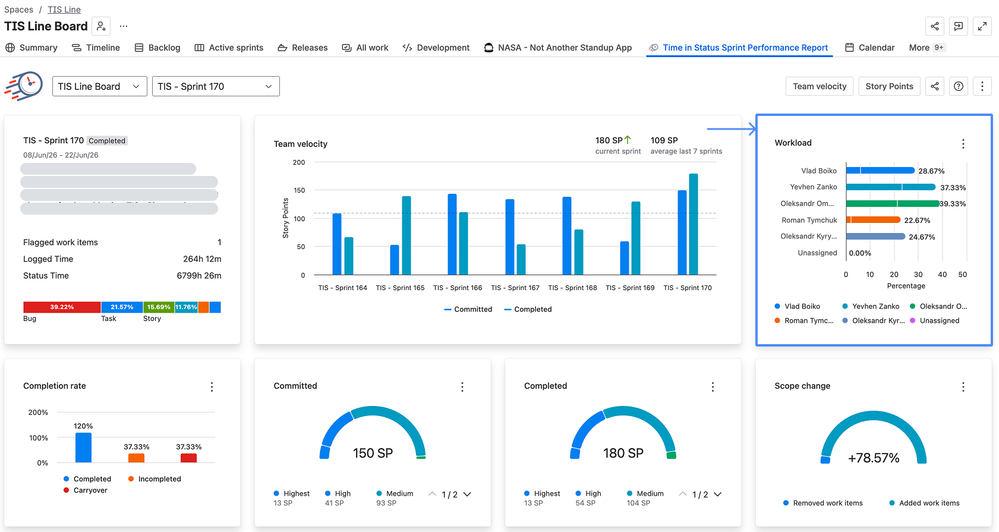

Signal 3: Workload by Assignee Shows Who Pays the Price

The third signal is Workload by Assignee. When rushed work comes back, it does not affect the team evenly. Usually, the repair work falls on specific people.

Maybe it returns to the developers who closed the original issues. Maybe it lands on the person who knows the component best. Maybe QA spends half the sprint retesting work that should have been stable.

This is where a sprint-level problem becomes personal.

The team says:

“We are overloaded.”

The data may show something more specific:

“Two people are carrying the repair work from the last sprint.”

That distinction matters.

If one person is repeatedly responsible for closing late-stage issues and then fixing them in the next sprint, the problem is not just capacity. It may be review quality, unclear Definition of Done, late testing, or pressure to close work before the sprint end.

Workload by Assignee helps connect sprint results to the people who bear the consequences.

The Burndown Shape Matters More Than the Final Line

A completed sprint burndown is useful not only because it shows whether the sprint ended successfully. It also shows how the sprint ended.

Two sprints can complete the same amount of work but tell very different stories.

In one sprint, work burns down steadily. Issues move through the workflow throughout the sprint. Testing happens early enough. Review does not pile up. Completion is gradual.

In another sprint, the burndown stays flat for most of the sprint, then drops sharply on the final day or two.

Both sprints may technically finish well.

But the second one carries more risk.

A late cliff in the burndown can indicate batching, delayed testing, rushed review, or pressure to close work at the end. It does not prove that quality suffered, but it tells you where to look next.

That is why the burndown for a completed sprint is such an important retrospective tool. It helps teams discuss not only whether the work is finished, but also how it was finished.

A healthy sprint is not only about the final number. It is about the shape of delivery.

Status Count Helps Confirm the Pattern

Transition Count shows how often work moved between statuses.

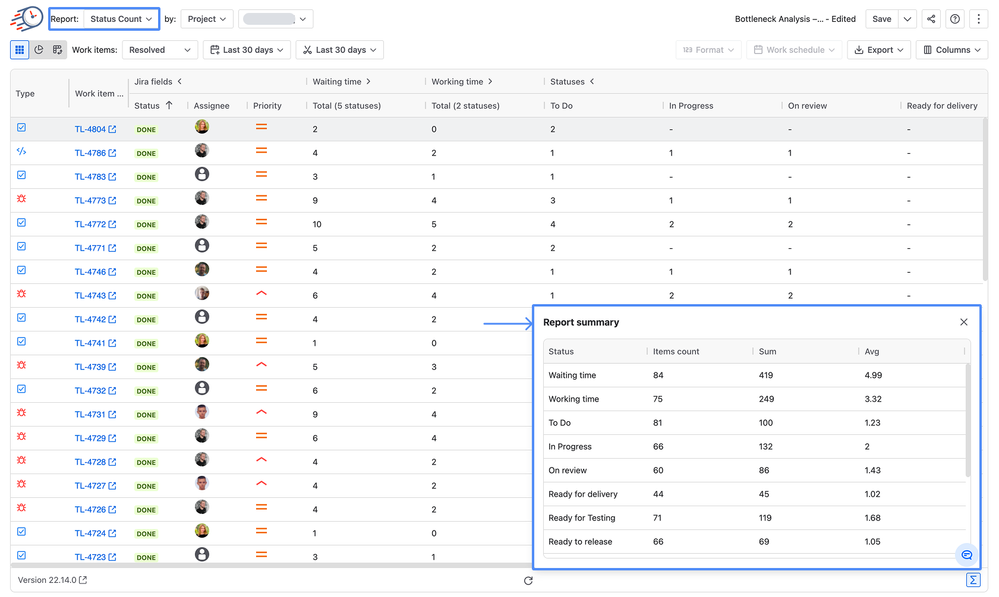

Status Count helps show how many times issues have entered specific statuses.

Together, they can reveal whether a sprint created repeated loops.

For example, after a “successful” sprint, the next sprint may show increased visits to:

  • In Progress
  • Code Review
  • QA
  • Reopened
  • Waiting for Fix

If the same issues keep returning to these statuses, the team may not be dealing with new work. It may be dealing with work that should not have been considered complete yet.

The Report Summary is useful here because it gives a quick overview without forcing the team to inspect every issue manually. Instead of arguing from memory, the team can quickly see where status visits, transition counts, or unusual patterns increased.

That turns the retrospective from opinion into investigation.

A Simple Early Warning Metric

Here is a practical habit worth trying. After every sprint, check the backward Transition Count in the first week following sprint close.

Specifically, look at issues that were completed in the final 24 hours of the sprint.

Then ask:

  • Did any of them move backward after the sprint closed?
  • Did they generate bugs or follow-up tasks?
  • Did the same assignees spend time repairing them?
  • Did the Sprint N+1 scope increase because of them?
  • Did the burndown show a late completion cliff?

This does not need to become a complicated process. It can be a five-minute check before the retrospective. The point is not to punish late completion. The point is to understand whether “Done” is staying Done.

What to Look at in Time in Status

This is where Time in Status can help teams connect the dots across sprints rather than looking at each metric in isolation.

  • The Sprint Report gives the starting point: completion rate, velocity, scope change, and burndown. It helps identify the sprint that looked healthy and whether the work finished gradually or all at once near the end.
  • The Burndown Chart for a completed sprint helps reveal the shape of delivery. A steady burn and a last-minute cliff may produce the same completion rate, but they are not the same workflow story.
  • The Transition Count report helps determine whether completed work was returned. This is especially useful for finding backward moves from Done, QA, Review, or other late-stage statuses.
  • The Status Count report helps confirm whether issues are repeatedly entered in the same statuses, which can indicate rework loops rather than normal progress.
  • The Report Summary makes it easier to see totals and averages across statuses or transitions without having to dig into every single issue first.

Individually, each report answers one question.

Together, they answer a much better one:

“Did this sprint really finish the work, or did it move the cost into the next sprint?”

A Retrospective Prompt That Changes the Conversation

Most retrospectives ask:

  1. What went well?
  2. What did not go well?
  3. What should we improve?

Those are good questions.

But after a sprint that looks successful, it may be worth adding one more:

“Which completed work came back?”

This prompt is simple, but it changes the tone of the discussion. It moves the team away from celebrating or criticizing a single number and toward understanding the quality of completion.

It also keeps the conversation fair. The goal is not to blame the person who moved an issue to Done late on Friday. The goal is to understand why that became the rational course of action.

  1. Was the sprint overloaded?
  2. Was QA too late?
  3. Was the Definition of Done unclear?
  4. Were stakeholders pushing for a green sprint?
  5. Was the review treated as a checkbox?

The data does not answer those questions on its own, but it gives the team a better starting point.

Try This in Your Next Retrospective

Before your next retro, pick the most recent successful sprint.

Then check:

  1. Did several issues move to Done in the final 24 hours?
  2. Did any of those issues move backward in the following week?
  3. Did Sprint N+1 include bugs or follow-up tasks connected to them?
  4. Did the burndown show steady progress or a late drop?
  5. Did the repair work concentrate around specific assignees?

If the answer is yes, the sprint may not have been as successful as it looked.

And that is not bad news.

It is useful news.

Because once the pattern becomes visible, the team can act on it.

Maybe the Definition of Done needs to be tightened. Maybe testing needs to start earlier. Maybe late-sprint work should be flagged as a risk. Maybe the team needs to stop treating “almost done” as close enough.

The important thing is to catch the pattern before Sprint N+1 becomes Sprint N+2, and Sprint N+2 becomes the moment everyone asks:

“How did we get so far behind?”

The answer may already be in Jira.

You just need to look one sprint earlier.
