The One-Page Sprint Report Leaders Actually Read

Most sprint reports fail for one simple reason: they answer the team’s questions, not the leader’s.

A delivery lead, Head of Product, or CTO doesn’t wake up thinking, “How many story points did we burn?” They’re thinking:

  • Are we on track to deliver what we promised?
  • If we’re not, when will we know—and what should we do about it?
  • Is the team building predictability or accumulating chaos?
  • Is scope stable enough to plan the next move?

A one-page sprint report becomes “leader-readable” when it tells a clear story—fast—without forcing the reader to interpret raw metrics. It’s not about making charts prettier. It’s about making decisions easier.

Below is a practical way to turn your Sprint Report (including the new active sprint view with a Burndown chart) into a one-page narrative leaders will actually use (as an example of such a report, we use the sprint report from the Time in Status app by SaaSJet).

What leaders want from a sprint report (and what they don’t)

Leaders don’t need a forensic document. They need a dashboard with judgment.

They want:

  • Confidence: “We’re likely to finish” or “We’re at risk.”
  • Early warning: “If this trend continues, we miss the goal.”
  • A learning loop: “This happened because…” not “This happened.”
  • A small set of levers: “Do we de-scope, add capacity, or renegotiate the deadline?”

They do not want:

  • A points debate
  • A list of tickets
  • A retro transcript
  • A chart that requires a Jira PhD to decode

So the goal is not “more data.” The goal is less noise, more signal.

The three design rules of a one-page report

1) Make it answer three questions in 60 seconds

If a leader gives you one minute, your report must still work.

  1. Where are we now? (progress and risk)
  2. What changed? (scope and surprises)
  3. What do you want me to decide? (next action / support needed)

If your page can’t answer those quickly, it won’t get read.

2) Separate “running the sprint” from “learning from the sprint”

This is exactly why the update to active sprint reporting matters.

  • For active sprints, leaders need a forward-looking control panel → Burndown chart + dynamic metrics (calculated from sprint start → now).
  • For completed sprints, leaders need a retrospective pattern view → Velocity trends + carryover (finalized, saved values).

This distinction sounds subtle, but it’s the difference between steering and autopsying.

3) Use metrics as conversation starters, not scorecards

If a metric can be “won,” it will be gamed. If it can’t be acted on, it will be ignored. Leader-grade metrics do one thing well: trigger the right question at the right time.

For active sprints: why Burndown beats Velocity for leadership

Velocity is backward-looking. It’s useful, but it’s not a steering wheel. For an active sprint, leaders care about trajectory. The burndown gives that instantly:

The Burndown chart: the only chart that earns its space

A leader should be able to glance and say one of these:

  • On track: actual line roughly follows forecast
  • Behind: actual stays above forecast
  • Scope is unstable: actual jumps up repeatedly
  • Work isn’t finishing: long flat segments (lots “in progress,” little “done”)

What makes the burndown powerful is that it exposes behavior, not just output:

  • going down = finishing
  • going up = adding scope
  • flat = not closing work

Deep insight leaders appreciate: A burndown doesn’t just measure the sprint. It measures the team’s ability to turn effort into outcomes. A flat line is rarely a productivity problem—it’s usually a flow problem (handoffs, unclear acceptance criteria, testing bottlenecks, hidden dependencies).

Make it leader-ready with one annotation: Add a single callout when the line jumps:

  • “+12 SP: compliance request added (Dec 18)”
  • “-6 SP: de-scoped integration due to vendor delay (Dec 20)”

One sentence turns “mystery chart” into “managed reality.”

Group 23.png

Sprint report for Active sprint by Time in Status app by SaaSJet

The supporting sections leaders actually use (and what each should mean)

Sprint information: health signals, not trivia

Keep the “busy-ness” metrics, but frame them as risk indicators:

  • Flagged work items: not “how many flags,” but “how many unresolved risks exist right now?”
  • Logged time: not “hours spent,” but “is effort converting to completion?”
  • Status time: your best early warning for flow blockage—especially mid-sprint.

A leader doesn’t need the exact number of hours in a status. They need to know: Are we stuck anywhere?

Work item structure: detect “type drift”

The structure pie is a quiet hero. Leaders read it like this:

  • “Are we spending this sprint mostly on planned feature work—or drowning in bugs/support?”
  • “Did we accidentally turn a delivery sprint into a maintenance sprint?”

The value isn’t the percentages. It’s the shift from expectation.

Workload: show balance, but also ownership risk

Workload isn’t just fairness. It’s continuity:

  • A sprint where one person owns the hard stuff is fragile.
  • A sprint where too much is “unassigned” is usually a planning smell.

Leaders don’t need to micromanage assignments, but they do need to see single-point-of-failure risk.

Completion rate: interpret it like a reliability metric

Completion rate is not a trophy. It’s a reliability signal.

  • <80% repeatedly → commitments are unrealistic or scope changes are uncontrolled
  • ~100% consistently → planning is becoming trustworthy
  • >100% → could be great… or a sign commitment was sandbagged, or scope was poorly defined at start

Leaders love one sentence here:

  • “Completion rate is 72% because we added 18% scope mid-sprint and had 2 blocked items.”

That sentence is the report.

Committed vs Completed by priority: is urgency consuming strategy?

These charts are where strategy leaks into execution. If “High priority completed” is always strong but “Medium/Low” never moves, the team may be stuck in permanent urgency mode (support, escalations, unclear roadmap). Leaders should see that pattern early.

Scope change: the truth serum

Scope change is often the most honest chart on the page because it reveals:

  • how stable planning is
  • how disruptive outside requests are
  • whether the sprint goal is protected or constantly renegotiated

This is where a leader can act immediately:

  • “What can we stop accepting mid-sprint?”
  • “Which requests must wait for next sprint?”
  • “Do we need a policy: any added work requires equal removal?”

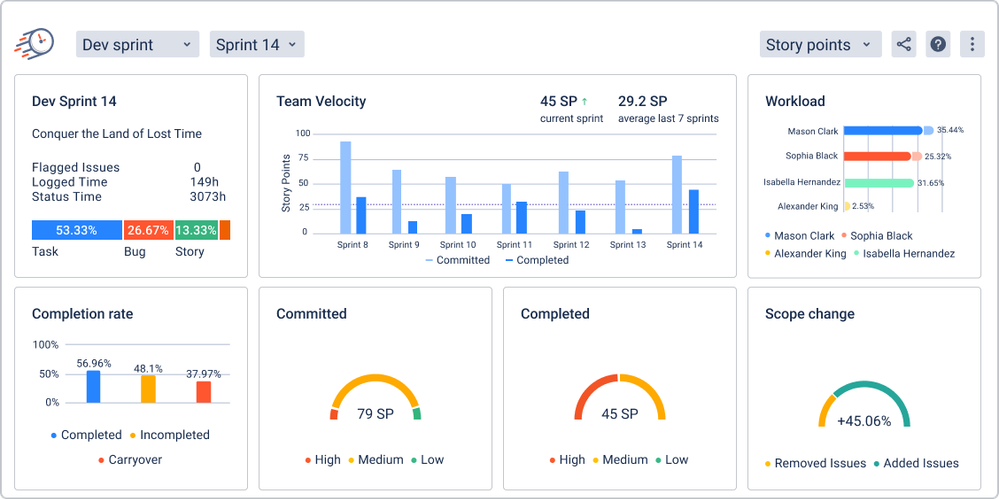

Sprint report for Completed sprint by Time in Status app by SaaSJet

The difference between a report that gets read and one that gets ignored

A report gets ignored when it feels like bookkeeping.

A report gets read when it feels like leadership leverage.

The secret is not adding more sections. It’s making every section answer one of these:

  • Are we on track?
  • What changed?
  • Where is the risk?
  • What decision do you need from me?

Your new active sprint support (Burndown + dynamic “until now” calculations, with carryover hidden until completion) is exactly the right direction—because it turns the sprint report from a rear-view mirror into a windshield.

Leaders don’t read reports to admire the dashboard.

They read them to steer.
