Few topics can make an agile team sigh faster than story points. Is this a 3 or a 5? Should bugs have points? Why did an 8-point story finish faster than a 2-point one?
Are we estimating complexity, effort, uncertainty, risk, or all of the above depending on how tired everyone is during refinement?
Story points were supposed to help teams talk about relative size. Instead, they often become a quiet promise about time. A 3-point story is expected to be “small,” a 5-point story is expected to be “medium,” and an 8-point story is expected to come with a warning label and at least one uncomfortable silence.
Then reality arrives.
The 3-point story sits blocked for a week. The 8-point story gets finished in two days because the scope was clearer than expected. The team starts asking whether the points were wrong, whether estimation is broken, or whether they should stop using points entirely.
This article is not another “story points vs. no estimates” debate. That debate has been having the same meeting with itself for years.
The more useful question is simpler:
What have your story points actually meant in practice?
Because story points are an opinion. They are guesses made before the work begins, under uncertainty and with limited information.
Cycle time is different. Cycle time is what actually happened. Jira records when work moved through the workflow. It shows how long an issue took from start to finish. It does not care how confident the team felt during refinement.
That does not make story points useless. It means story points need to be checked against reality.
One reason teams get frustrated with story points is that they quietly start treating them like time.
A 1-point task should be quick. A 3-point story should take a few days. A 13-point story should probably be split, feared, or moved to the next sprint before anyone gets too attached.
But story points do not measure time directly. They are usually meant to describe relative complexity, effort, uncertainty, or risk. They help the team say, “This looks bigger than that,” not “This will take exactly four days.” That distinction matters.
A small story can take a long time if it waits for a dependency. A large story can move quickly if the requirements are clear and the right person picks it up. A well-understood 8-point story may be less risky than a mysterious 3-point story with the words “just update the integration” in the description.
Story points are useful because they help teams estimate before they have perfect information. Cycle time is useful because it shows what happened after the uncertainty became real. The mistake is expecting the first number to behave like the second one.
Cycle time gives teams something story points cannot: a factual record of delivery.
It shows how long work actually took to move through the workflow. Not how long the team hoped it would take. Not how long it felt like it took. Not how long the estimate implied it should take.
Actual time.
That makes cycle time especially useful after the sprint ends, when teams are trying to understand whether their estimates matched reality.
For example, imagine a team looks at several completed sprints and groups issues by story point value.
|
Story Points |
Average Cycle Time |
|
1 point |
2 days |
|
3 points |
4 days |
|
5 points |
6 days |
|
8 points |
11 days |
This does not mean every 5-point story will take exactly six days. That would be too neat, and software delivery enjoys ruining neat things.
But it does give the team a real baseline.
Now a 5-point story is no longer just “medium complexity.” For this team, based on recent history, 5-point work has usually taken around six days to complete. That is a much better planning conversation.
The first useful insight is the average cycle time by story point value. The more interesting insight is the spread. A team might discover that its 5-point stories look like this:
|
Issue |
Story Points |
Cycle Time |
|
Story A |
5 |
4 days |
|
Story B |
5 |
6 days |
|
Story C |
5 |
9 days |
|
Story D |
5 |
14 days |
|
Story E |
5 |
2 days |
At first, this looks like bad estimation. Maybe it is. But often the variation tells a different story.
If 5-point stories range from 2 days to 14 days, complexity may not be the main driver of duration. Something else may be affecting the work:
That is where the conversation becomes useful.
Instead of arguing whether a story should have been a 3 or a 5, the team can ask:
Why do some 5-point stories finish in two days while others take two weeks?
That question is much more valuable than another round of estimation philosophy.
If a team only looks at story points, it knows the relative size but not the actual duration.
A team may know that an 8-point story is bigger than a 3-point story. That helps with capacity planning, but it does not automatically answer when the work is likely to finish.
“Bigger than that one” is not a forecast.
This is why sprint planning sometimes gets strange. Teams commit to a set number of points because it matches past velocity, but the actual sprint remains unpredictable. The point total looks reasonable, yet the work behaves differently once it enters the workflow.
Maybe the sprint contains fewer issues but more dependencies. Maybe the work sits in review longer than usual. Maybe several stories are technically small but require input from another team.
The point total does not show that. Cycle time does.
The opposite is also true.
If a team only looks at cycle time, it knows how long work took, but not how complex the work was expected to be.
A story that took 10 days might be a problem. Or it might have been a large, risky, genuinely complex piece of work. Without the estimate, the team loses important context.
This is why the best approach is not “story points or cycle time.” It is story points plus cycle time. Story points tell you what the team believed before the work started. Cycle time tells you what happened after the work moved through the system. Together, they show whether the team’s expectations and reality are starting to align.
A practical way to start is simple: group completed issues by story point value and compare average cycle time across several recent sprints. The goal is not to create a perfect prediction model. The goal is to understand your own delivery behavior.
For example, a team might look at the last six sprints and ask:
This gives the team a baseline built from real history. Not a generic agile textbook. Not another argument about whether Fibonacci is sacred. Actual team data.

This type of analysis becomes much easier when Jira history is turned into time-based reporting.

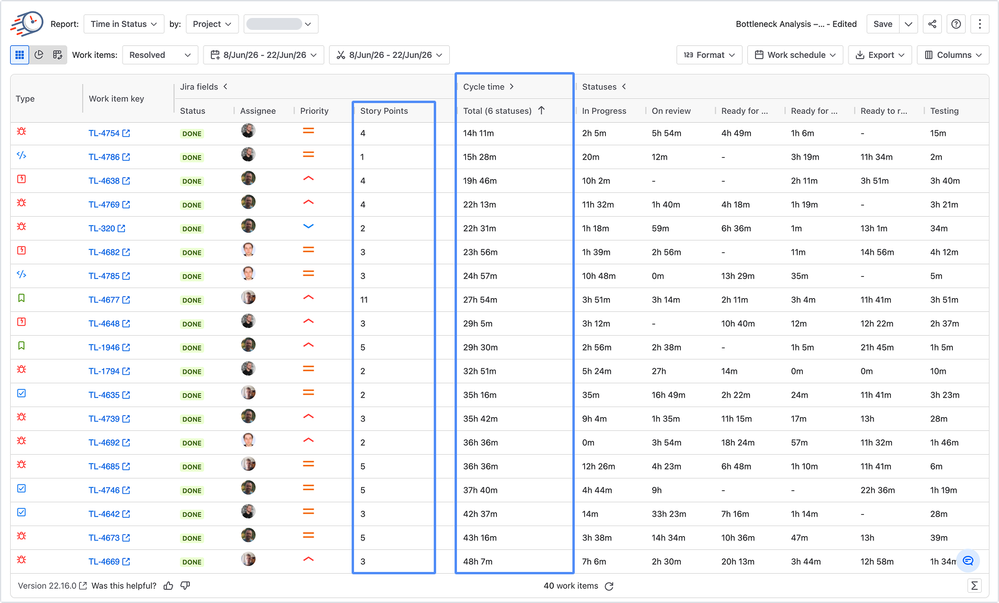

In Time in Status by SaaSJet, teams can use reports such as Average Time and Time in Status to understand how long issues actually spend in different workflow stages. When those reports are grouped or pivoted by story point value, the team can compare estimates against real cycle time.
A useful setup could look like this:

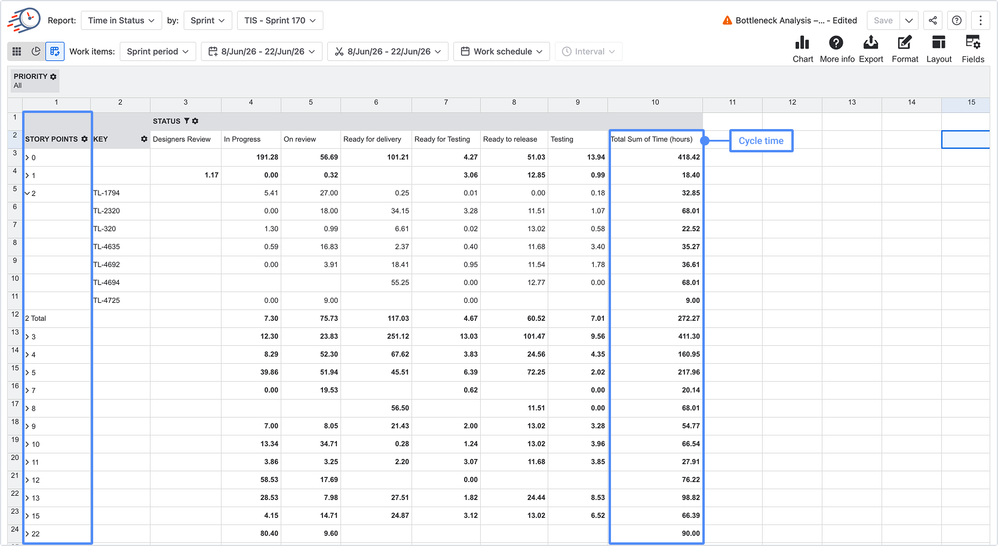

This is where Pivot Table View or row grouping becomes especially useful. Instead of scanning issue by issue, the team can compare story point values across groups and see whether the data support the assumptions behind the estimates.
For example:
|
Story Points |
Average Cycle Time |
What to Check |
|
1 |
2 days |
Usually predictable |
|
3 |
4 days |
Healthy baseline |
|
5 |
6 days |
Good planning reference |
|
8 |
11 days |
Watch for splitting opportunities |
|
13 |
18 days |
High risk, likely needs refinement |
This is not about turning points into exact time. It is about learning what points tend to mean for this team.
Most estimation debates focus on making the estimate more accurate up front. Should this be a 3 or a 5? Did we point this consistently? Should we recalibrate?
Those questions can help, but only to a point. The predictive power does not come from endlessly refining the opinion. It comes from checking the opinion against the fact, again and again, until the gap becomes informative.
If the team estimates something as 3 points and it takes 12 days, that is not automatically failure. It is a signal.
Maybe the work was poorly understood. Maybe dependencies were invisible. Maybe the workflow created waiting time. Maybe the story was small, but the system around it was slow.
That is the important distinction.
Story points can be wrong because the estimate was poor. Cycle time can be high because the workflow was unhealthy. You need both numbers to know which conversation to have.
Instead of asking only:
Did we complete the points we committed to?
try asking:
Did our point values behave the way we expected?
That opens better follow-up questions:
This moves the retrospective away from blame and toward learning.
The point is not to punish the team for inaccurate estimates. The point is to make estimation less mysterious over time.
Before the next planning session, take a small sample from the last few sprints. Group completed issues by story point value. Then check the average cycle time for each group.
Start with three questions:
Instead of saying:
“This feels like a 5.”
the team can say:
“Our recent 5-point stories usually took 4 to 9 days. This one has an external dependency, so it may behave more like the upper end of that range.”
That is not perfect forecasting. It is better forecasting. And in delivery planning, better usually matters more than perfect.
Story points are not facts. They are useful opinions.
Cycle time is not an opinion. It is a record of what happened.
One helps the team make a decision before the work starts. The other helps the team learn after the work is done. Used separately, both can mislead.
Used together, they help teams build a more honest planning system: one where estimates are not treated as promises, and historical data is not ignored after the sprint closes.
The goal is not to win the story points debate. The goal is to make the next estimate a little more informed than the last one.
And Jira already has the history needed to do that. You just have to look at what your points have actually meant.
