Sprint Retros That Actually Work

From opinions to evidence with the Sprint Performance Report (now on Data Center & Cloud)

There’s a special kind of retro that starts with “What went well?” and ends with “Let’s try harder next sprint.” No villains, no heroes—just déjà vu. The problem isn’t your team. It’s the lack of shared, trustworthy evidence about what actually happened.

That’s the job of the Sprint Performance Report in Time in Status for Jira. It turns your sprint into a clear story you can coach from—now available on Jira Data Center as well as Jira Cloud.


Why many retros stall (and how to unstick them)

Symptom: Conversations drift into opinions (“we were blocked a lot”, “QA was slow”).
Fix: Put objective signals on the screen and name the pattern.

Use these five evidence anchors:

  1. Velocity trend (last 7 sprints). Shows whether output is stable, rising, or noisy.
    What to do: If variance is high, shorten stories, reduce WIP, and tighten the definition of ready.
  2. Completion rate & carryover. Reveals the planning delta between “committed” and “done.”
    What to do: Re-calibrate forecast using rolling average velocity; isolate scope churn.
  3. Workload by assignee. Visualizes who took the heat (committed, added, removed).
    What to do: Balance by skills, guard focus time, pair on hotspots.
  4. Scope change. Quantifies how much was added/removed after the sprint start.
    What to do: Add intake guardrails, re-negotiate mid-sprint policy, label urgent vs optional.
  5. Issue mix & status time. Shows where time actually went (review, QA, waiting).
    What to do: Fix slow lanes (SLAs for reviews, more apparent acceptance, automation).

Coach’s rule: “Name the pattern, then pick one lever to pull.” Don’t create a wall of action items—choose the most minor change with the most significant upstream effect.

Read the report like a coach (not like a bookkeeper)

Below are concise reads for each section and an immediate next step. Each block is a self-contained insight you can paste into your retro notes.

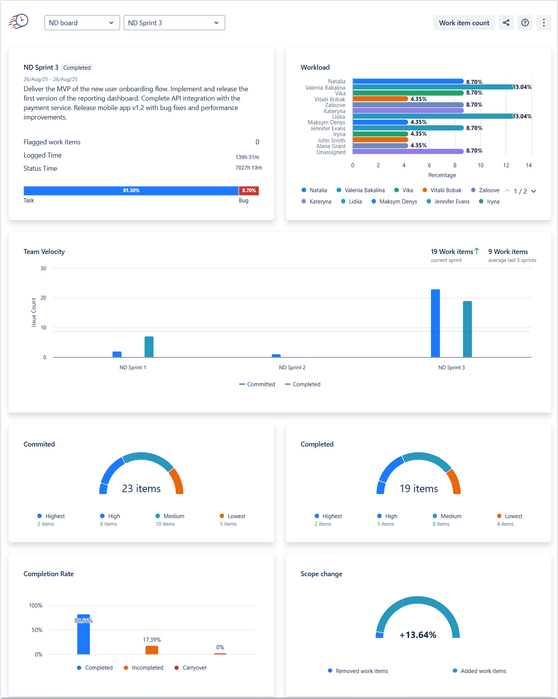

image 11.png

1) Team Velocity — Is our forecast honest?

Statement: Velocity across the last 7 sprints exposes consistency.
Interpretation: Stable = predictable; rising = capacity/process gain; falling = debt, staffing, or hidden work.
Action: Use the 7-sprint completed average as the next sprint’s ceiling. If you add scope mid-sprint, track it separately.

2) Completion Rate & Carryover — Where did the promise break?

Statement: Completion = Completed / Committed; Carryover is unfinished work moved forward.
Interpretation: Low completion with low scope change → overcommitment. Low completion with high scope change → intake problem.
Action: Set a mid-sprint checkpoint; any add/remove is explicit, with trade-offs.

3) Workload by Assignee — Was the sprint humane?

Statement: Bars show committed, added, and removed per person.
Interpretation: Tall positive bars on one name = load imbalance; frequent negatives = churn.
Action: Pre-assign reviewers/testers to high-risk items; rotate “interrupt” duty weekly.

4) Scope Change — Did the plan stay a plan?

Statement: Pie slices show the size of adds vs removes relative to commitment.
Interpretation: Adds ≫ removes means planning is leaking; removes ≫ adds means the plan was off or priorities shifted.
Action: Create a “gate” label for urgent intake; cap total adds as % of commitment.

5) Sprint Information — What else should we not ignore?

Statement: Flagged items, logged time, and time-in-status reveal friction.
Interpretation: Many flags + long status time in review/testing = approval bottleneck.
Action: Establish SLAs for code review & QA; add dashboards that surface aging items.

Three real retro storylines (and how to fix them)

Each storyline pairs what you’ll see in the report with a concrete change to try in the next sprint.

A) “Scope balloon” sprint

  • Signals: Velocity stable; completion rate dips; scope change shows a big “added” slice.
  • Likely cause: Unplanned intake enters mid-sprint; forecasts are accurate, but plans get overridden.
  • Try this: Add a “triage lane” with a hard weekly capacity cap; anything beyond the cap requires trading out committed work. Track triage items with a label and review them in the next planning.


B) “Rework loop” sprint

  • Signals: Completion lags; Status Count/Transition Count show repeated Dev ↔ QA moves; time-in-status spikes in QA Review.
  • Likely cause: Vague acceptance, late test data, or unstable environments.
  • Try this: Add a quality checklist to the Definition of Done, pair a tester on the top 3 risky stories at the start, and time-box rework. Monitor with Status Count and Time in Status for the next sprint.


C) “Hero bottleneck” sprint

  • Signals: The workload chart indicates one overloaded assignee, with flagged items concentrated on that person’s stories.
  • Likely cause: Single point of review/deployment knowledge.
  • Try this: Create a “review guild” of 2–3 folks; split ownership of critical paths; add a Status Entrance Date check to see how fast items enter Review after Dev completes.


💡 Quick retro scripts (steal these)

  1. Planning honesty check: “Completion was 78% with +22% scope added. What should we cap as ‘urgent intake’ next sprint—5% or 10%?”
  2. Flow check: “Two stories spent >40% of the sprint in Review. What one change would cut review wait times in half?”
  3. Workload sanity: “Three people had >130% net workload. Which skills can we cross-train to spread the critical path?”
  4. Quality loop: “Transition Count shows 3+ back-and-forths Dev↔QA on five items. What acceptance rule was missing?”

Data Center or Cloud: same outcomes, same path

We launched Sprint Performance Report on Cloud first, and it’s now available for Jira Data Center—with the same clarity. Wherever you run Jira, you can base retros on facts instead of folklore.

Where you’ll find it:

  • ReportsTime in Status Sprint Performance Report
  • From Active sprints or Backlog via the Sprint Report dropdown
  • Or the sidebar entry in Time in Status

It respects your estimation method: Story Points, Original Time Estimate, or Work Item Count (use the same one your board uses).

📕 Monday-morning playbook (30 minutes)

Before the retro

  1. Open the last sprint’s report. Screenshot the Velocity and Scope Change charts.
  2. Filter hotspots by label/component; note any items with long Review/QA status time.
  3. Write one hypothesis: “Scope adds >15% → completion falls below 85%.”

During the retro

      4) Show the five evidence anchors. Ask the team to name the pattern.
      5) Vote on 1–2 minor changes. Assign owners and a check date.
      6) Save the report view as a preset to reuse next sprint.

After the retro,

      7) Post screenshots + decisions in Confluence.
      8) Add a dashboard gadget for “aging in status” to watch the experiment mid-sprint.
      9) In the next retro, compare before vs after with the same charts.

FAQ (the useful kind)

Does this replace burndown?
No—burndown shows progress over time. The Sprint Performance Report explains why the burndown looked that way.

Will this work across multiple teams?
Yes, if your board’s JQL unifies the scope. For clean comparisons, keep separate boards per team and roll up trends.

What about industries with formal reviews (finance, public sector)?
Use Status Groups in Time in Status app to define business phases (e.g., Analysis, Build, Review, Compliance). Track cycle time by group and put SLAs on slow groups.

Try it on your next retro

If you’re running retros without a shared view of reality, you’re debating stories, not improving them.

  • 🎯 Install Time in Status for Jira → Sprint Performance Report (Cloud & Data Center)
  • 🧭 Want a walkthrough? We’ll map the report to your workflow in 20 minutes. (Cloud & Data Center)

Make the invisible visible—and make every sprint a step forward.
