When working with templates in Jira, we naturally expect certain information to be reused across issues. This is one of the biggest advantages of templating: data such as names, descriptions, links, or responsibility details automatically flow from one task to another, eliminating repetitive copy-and-paste work.
But what about date fields?
Copying them as-is rarely makes sense – the dates from your template rarely match the real timeline of your new project.
At the same time, manually adjusting each date after cloning is slow, error-prone, and completely defeats the purpose of using templates in the first place.
In many real workflows, the sequence of tasks follows a defined timeline: some steps must happen 2 days later, others 10 working days later, and others right before go-live.
So what do we do with date fields?
Jira’s native cloning does not let you adjust dates before cloning or shift them intelligently afterward. Every date is copied one-to-one, forcing users to rebuild the timeline manually.
This is exactly why Auto-Adjustment exists.
Let’s dive into how you can automatically adjust all date fields while cloning your work items, so your entire template instantly aligns with your project timeline – whether you rely on calendar days or working-day offsets.
To use Auto-Adjustment effectively, you first need a set of work items to serve as your template – or simply an existing issue you want to duplicate with an adjusted timeline.
You can prepare your template in several ways:
1. Build a template following the approach described here:
👉 Why repetitive work deserves better than manual effort
This method guides you through creating a clean, reusable structure in Jira.
2. Use your own templating approach
Some teams already maintain their own collections of issues that serve as templates – and that works perfectly fine. Auto-Adjustment will work with any structure.
3. Select any set of existing issues
You can also choose a group of tasks that are not connected by hierarchy but still represent a repeatable workflow you want to keep consistent. Auto-Adjustment preserves the chronological relationship between their dates and intelligently shifts them during cloning.
Auto-Adjustment recalculates date offsets based on the original timeline in your template.
To make this possible:
This initial timeline acts as a “reference schedule.”
Auto-Adjustment is available in Clone Expert for Jira, so make sure the app is installed and enabled.
Once your work items are prepared with the correct dates and timeline logic, you’re ready to start cloning and let Auto-Adjustment do its work.

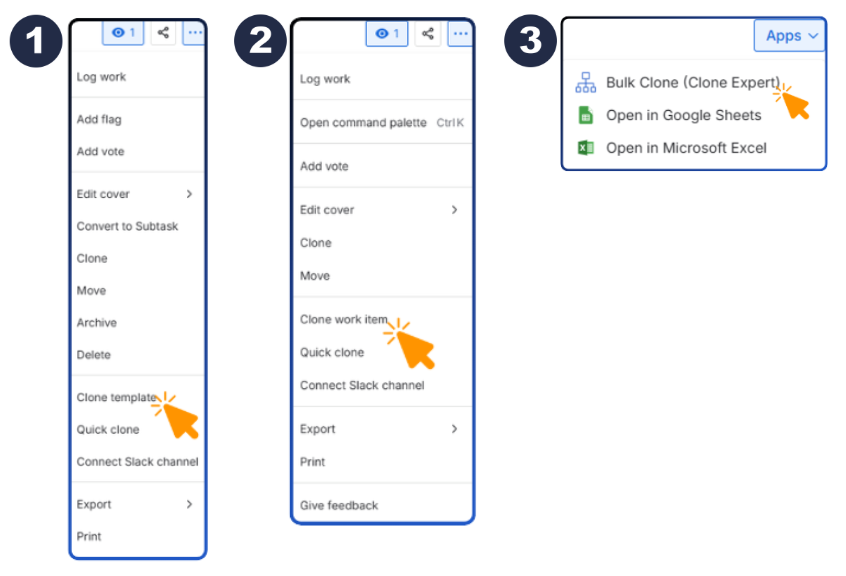

You can begin cloning in several ways:
1. From inside an Epic: Actions → Clone template
Clones the Epic and all its child issues.
2. From any individual work item: Actions → Clone work item
Useful when cloning any work item with children or without children.
3. From a list of issues (Bulk clone) in the Search Work Items view: Apps → Bulk clone
You can select any group of issues, even without hierarchy.

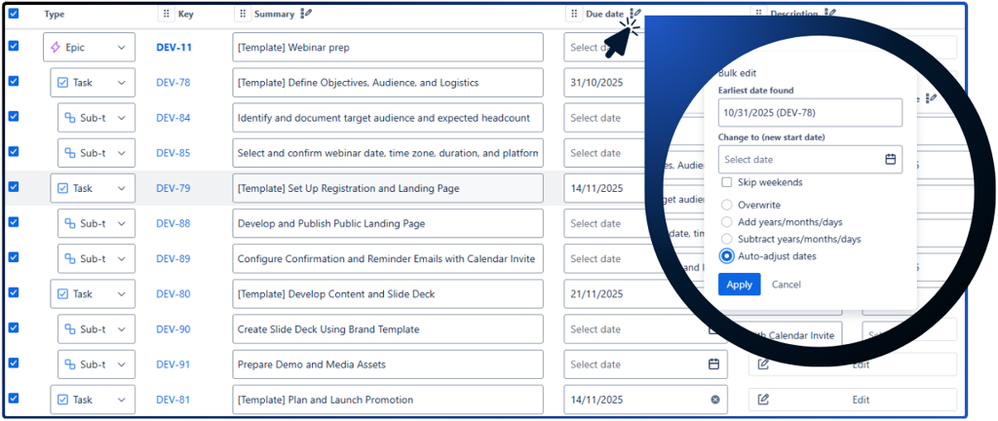

In the clone window, in the preview table, go to a date column → open Bulk Clone options → choose Auto-adjust dates.
There are two adjustment options:
1. Auto-adjust to earliest date (forward planning).
2. Auto-adjust to latest date (backward planning)
with two date calculation logics:
Calendar days
Working days (skip weekends)
This mode shifts the entire timeline forward, starting from the new earliest date you provide during cloning.
This option calculates the difference between:
the earliest date in your template, and
the new earliest date you choose,
…then applies this shift to all other dates.
EXAMPLE: Forward-planning with Calendar Days
|
Template task |
Template Due Date |
|---|---|
|
Task A |
01.01.2026 |
|
Task B |
07.01.2026 |
|
Task C |
20.01.2026 |
➡️ New earliest due date: 10.02.2026
Offset = +40 calendar days
|
Task |
Adjusted Date |
|---|---|
|
Task A |
10.02.2026 |
|
Task B |
16.02.2026 |
|
Task C |
01.03.2026 - End date |
EXAMPLE: Forward-planning with Working Days (skipping weekends)
|
Task |
Template Due Date |
Template offset |
|---|---|---|
|
Task A |
01.01.2026 |
Start date |
|
Task B |
07.01.2026 |
Task A + 4 WD |
|
Task C |
20.01.2026 |
Task B + 9 WD |
➡️ New earliest due date: Monday 10.02.2026
|
Task |
Adjusted Date |
|---|---|
|
Task A |
10.02.2026 |
|
Task B |
16.02.2026 |
|
Task C |
27.02.2026 - End date |
Many processes are driven not by a start date, but by a fixed deadline:
EXAMPLE: Backward-planning with Calendar Days
|
Task |
Template Due Date |
Template offset |
|---|---|---|
|
Task A |
01.01.2026 |
Task B - 6 days |
|
Task B |
07.01.2026 |
Task C - 13 days |
|
Task C |
20.01.2026 |
End date |
➡️ Finish by: 21.08.2026, Offset: +213 calendar days backward-shift anchor
|
Task |
Adjusted Date |
|---|---|
|
Task A |
02.08.2026 - Start date |
|
Task B |
08.08.2026 |
|
Task C |
21.08.2026 |
EXAMPLE: Backward-planning with Working Days (skipping weekends)
|
Task |
Template Date |
Relative Offset |
|---|---|---|
|
Task A |
01.02.2026 |
Task B - 4 WD |
|
Task B |
07.02.2026 |
Task C - 9 WD |
|
Task C |
20.02.2026 |
End date |
➡️ Finish by: 21.08.2026
|
Task |
Adjusted Date |
|---|---|
|
Task A |
04.08.2026 - Start date |
|
Task B |
10.08.2026 |
|
Task C |
21.08.2026 |
As a result, your entire workflow finishes exactly on time, while every other task falls into the correct place.
Use Auto-adjust to earliest date when…
You know your start date
✔ You plan forward
✔ Workflows: onboarding, implementation, project kickoff, migrations
Use Auto-adjust to latest date when…
You know your end date
✔ You plan backward
✔ Workflows: releases, go-live, events, compliance deadlines, audits, contract expiries
Below is a real sequence of tasks with working-day offsets and a new anchor date of 15.04.2026.
Here, we consider a scenario in which the template structure determines the start and end dates.
|
Task |
Template date |
Offset |
Adjusted date |
|---|---|---|---|
|
Scope preparation |
01.01.2026 |
0 WD |
15.04.2026 |
|
Kickoff scheduling |
07.01.2026 |
+4 WD |
21.04.2026 |
|
Environment provisioning |
20.01.2026 |
+9 WD |
01.05.2026 |
|
Workshop |
27.01.2026 |
+5 WD |
08.05.2026 |
|
Configuration |
10.02.2026 |
+10 WD |
22.05.2026 |
|
Validation |
17.02.2026 |
+5 WD |
29.05.2026 |
|
Final delivery |
19.02.2026 |
+2 WD |
02.06.2026 - End date |
What if we only know the expected final delivery date?
Then we use the Auto-adjust to latest date option – the new backward-planning mode.
In this scenario, you provide the deadline, and Clone Expert automatically calculates the correct start date and all intermediate dates.
Let’s assume that the Final delivery must be done on 22.07.2026.
|
Task |
Template date |
Offset |
Adjusted date |
|---|---|---|---|
|
Scope preparation |
01.01.2026 |
0 WD |
03.06.2026 - Start date |
|
Kickoff scheduling |
07.01.2026 |
+4 WD |
09.06.2026 |
|
Environment provisioning |
20.01.2026 |
+9 WD |
22.06.2026 |
|
Workshop |
27.01.2026 |
+5 WD |
29.06.2026 |
|
Configuration |
10.02.2026 |
+10 WD |
13.07.2026 |
|
Validation |
17.02.2026 |
+5 WD |
20.07.2026 |
|
Final delivery |
19.02.2026 |
+2 WD |
22.07.2026 |
Reminder:
In the preview table, you can review all calculated dates before cloning and verify that the timeline aligns with your current project.
All automatically assigned dates can be edited afterward. Clone Expert does not block changes – you remain fully in control.
If you'd like to experiment with Auto-Adjustment, it's available in Clone Expert for Jira on Atlassian Marketplace.
To learn more, check the Documentation or request a live Demo.
Stop wasting time on manual date adjustments – let Clone Expert for Jira handle your project timelines automatically!
