If you’ve ever ended a sprint staring at a half–burned-down chart, a pile of rolled-over issues, and a grumpy team, you already know this: a sprint is not just a date range in Jira.
Still, many teams treat it that way. They:
Then they look at Jira’s Sprint Report or Velocity Chart and conclude:
“These reports are useless. Our work can’t be measured.”
Usually, the truth is harsher: the way we use sprints makes the data meaningless.
In this article, we’ll unpack:
The goal isn’t perfection. It’s to turn your sprints from a source of stress into a reliable feedback loop.
On paper, Jira’s sprint workflow is simple:
That’s the mechanics. But good sprints are less about mechanics and more about agreements.
A healthy sprint in Jira is basically three agreements wrapped in a timebox:
Jira is where those agreements are stored and tested. When those agreements are missing or weak, you can feel it in the UI:
So when we talk about “using sprints correctly”, we’re not talking about pushing the right buttons. We’re talking about making these agreements explicit and letting Jira’s data show whether we’re honoring them.
Most anti-patterns around sprints are not about people being careless. They’re usually about teams trying to cope with pressure, uncertainty, or unclear priorities.
Let’s look at the usual suspects – and the deeper story behind them.
“We need to show progress, so let’s at least start the sprint.”
This often happens when leadership wants “sprints,” but the team hasn’t yet built a refinement habit. So the ritual becomes: start sprint first, plan later.
From Jira’s perspective, this destroys the meaning of a sprint. The platform assumes that the moment you click “Start Sprint” is the moment your commitment becomes real. If there’s nothing (or almost nothing) in it at that moment, your reports no longer answer a simple question:
“Did we deliver what we said we’d deliver?”
Instead, they show a blur of scope changes and half-formed plans.
Deeper fix:
Jira doesn’t care when you push the button. But your ability to trust its data depends on what’s inside when you do.
“We’ll add story points later; we just need to move fast now.”
This is extremely common in teams under time pressure or that don’t fully trust estimation. It feels like you’re saving time by skipping the “planning overhead”.
In reality, you’re pushing that cost into the future:
Estimation is not about worshipping story points. It’s about forcing a conversation: “Do we understand this work well enough to bet on it for this timebox?”
Deeper fix:
Your reports will always be “garbage in, garbage out”. Late estimation is one of the quickest ways to make that garbage.
“Just add it to the current sprint; we’ll figure it out.”
This one is more cultural than technical. Someone important asks for something “small”. The team wants to be helpful. The sprint slowly turns into a shopping cart of everyone’s wishes.
On the charts, this shows up as:
The real result is not only missed commitments. It’s emotional: the team stops believing in planning. “What’s the point? It will all change anyway.”
Deeper fix:
Every item you drag into a running sprint changes the story your data tells. You don’t have to stop completely — but you should never do it thoughtlessly.
“Our goal is to finish everything in the sprint.”
That’s not a goal; that’s a tautology.
A goal answers: “Why does this sprint matter?”
It gives the team a narrative: “We’re doing this so that that becomes possible.”
Without a goal:
Deeper fix:
A good sprint goal won’t magically fix your workflow, but it will align everyone around what not to do.
“We’ll just move them ALL to the next sprint. Done.”
This is a surprisingly dangerous habit. On the surface, it looks harmless: unfinished work has to go somewhere. But if you never stop to ask why it’s unfinished, you erase the learning opportunity.
Rolling everything forward creates:
Deeper fix:
At the moment you complete a sprint:
The point is not to punish anyone. It’s to avoid carrying silent problems from sprint to sprint until your board becomes unmanageable.
Sometimes the problem isn’t behavior at all. Its configuration.
If “Done” isn’t mapped to the right-most column, or if your board filter doesn’t include all relevant issues, then Jira’s reports are telling you a warped version of reality.
You might think:
Deeper fix:
A good configuration doesn’t guarantee a good process. But a bad configuration guarantees misleading metrics.
Once your basic sprint hygiene is under control, Jira’s own reports transform from a guilt-inducing mirror into a reliable diagnostic tool.
Two reports matter most for sprints:

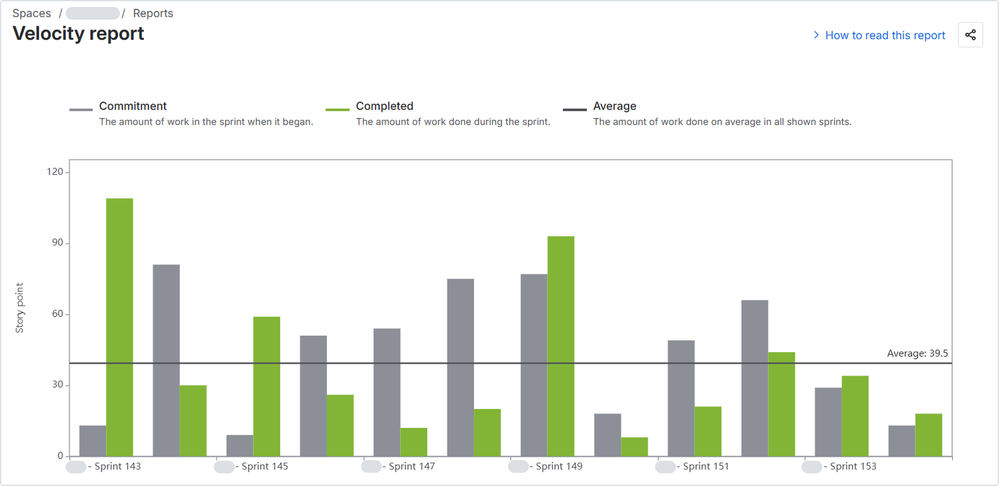

Think of the Velocity Chart not as a scoreboard, but as a diary. It’s quietly answering:
“Given how you really work, how much can you usually get done in a sprint?”
It tracks, for each past sprint:

The Sprint Report is your sprint’s black box recorder. It shows:
What makes it powerful is not the chart itself, but the conversation it enables.
Still, native reports answer mostly what and when. They say less about where time is wasted, who is overloaded, or how scope changes impact specific people. For that, you need more detailed analytics.
That’s where the Time in Status Sprint Report comes in.

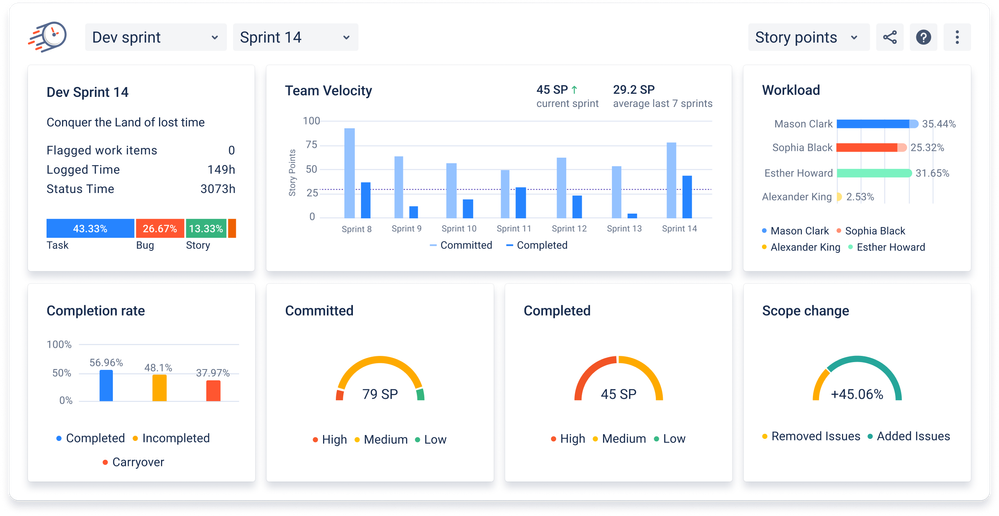

The Sprint Report in the Time in Status app takes the familiar concept of a sprint and layers richer diagnostics on top. Instead of just “done vs not done”, it lets you explore:
Let’s walk through the key sections and the kind of questions each one can answer.
This section gives you a snapshot of the sprint’s anatomy. Instead of just “we finished 20 points”, you can start to see patterns like:
This section is perfect for reframing retrospective conversations:
From “We didn’t work hard enough” to “We wasted all our time solely on fixing bugs — how to correct this?”
Here, Time in Status extends the idea of velocity over the last seven completed sprints, always including the selected sprint.
Used well, this view helps you separate strategy from noise:
This is also where you can have calmer discussions with stakeholders:
Aggregated metrics often hide a fundamental truth: teams don’t fail on average; they fail where specific people are overloaded.
This turns vague impressions into hard data:
Instead of arguing about feelings, you can talk about patterns visible in the workload chart and adjust staffing, WIP limits, or responsibilities accordingly.
The Completion Rate section shows, in plain percentages:
These numbers can be uncomfortable. A steady 60% completion rate invites tough questions. But this discomfort is productive if you treat it correctly.
The key mindset shift is:
Low completion is not a moral failing.
It’s a signal that your system’s promises don’t match reality.
High completion with little carryover suggests your planning and execution are aligned. High carryover suggests you’re repeatedly writing cheques your team can’t cash.
Over time, you can use this to define a shared “healthy band”:
These sections ask a brutal but necessary question:
“Are we finishing the work that actually matters, or just the work that’s easiest to close?”
By comparing committed vs completed work across priorities, you can see whether your process respects your own labels.
Common patterns:
These insights are gold in conversations with stakeholders:
Scope change is where many sprints die. This matters because scope changes don’t just “add work”. They erode trust in the sprint as a planning unit.
A single chart can show:
Instead of emotionally charged arguments (“we’re always interrupted”), you have concrete evidence:
“In the last three sprints, scope increased by more than 30% each time. If we want reliable delivery, we need to protect the sprint boundary.”
Using sprints in Jira “correctly” is not about obeying Scrum dogma or squeezing more work into two weeks. It’s about building a system where:
Jira’s native Sprint Report and Velocity Chart give you the first layer: are we doing what we said we’d do?
The Time in Status Sprint Report adds the second layer: where exactly are things going wrong — in people’s workload, in specific statuses, in priority decisions, or in our addiction to mid-sprint changes?
Put together, they let you move from:
“Our sprints never work, and Jira is confusing.”
to: “We know why our sprints behave the way they do, and we know what to try next.”
And once your sprints become a learning loop instead of a recurring disappointment, the data stops being a weapon – and becomes a mirror you can actually work with.
