Managing a project without reliable time data is a bit like steering without being able to see the road. You're moving, but you don't know if you'll arrive on time or run out of runway first.
The consequences tend to show up in predictable ways:
Accurate time data fixes all of this — but only if the infrastructure behind it is set up correctly and used consistently.
Before you can report on anything, the basics need to be in place.
Enable time tracking at the global level. Head to Jira administration and confirm the time tracking feature is active. It's not always on by default.
Verify permissions. Users need the "Work on Issues" permission to log time. If this isn't granted, worklogs simply won't happen — and the silence in your reports won't tell you why.
Add the right fields to your issue screens. The "Original Estimate" and "Remaining Estimate" fields need to appear on each issue type your team works with. This requires admin access. Without estimates, you lose the ability to compare planned vs. actual — which is where most of the analytical value lives.
One important limitation to be aware of: Jira's native time tracking has no automated capture. Every worklog entry is manual, which means data quality is entirely a function of team discipline.
Getting people to log time is one thing. Getting them to log it in a way that supports reporting is another.
Log daily. Time entered at the end of each day is far more accurate than reconstructing a week from memory. This is the single most impactful habit change a team can make.
Require a description on every entry. A brief note about what was done turns a raw number into an auditable record. This matters for client billing, finance reviews, and any situation where a stakeholder wants to understand where hours went.
Classify time as billable or non-billable from the start. Decide the convention before logging begins. Retroactively sorting this out is painful and error-prone.
Capture non-Jira time too. Meetings, training, internal reviews — these consume real capacity but don't live on Jira issues. If you want accurate utilization data, this time needs to go somewhere trackable.
Jira's built-in tooling covers the basics well:
Where it runs out of road:
For a small team on a single project, this may be enough. For anyone managing cross-project capacity, client billing, or team-level reporting, you'll hit these limits quickly.
ActivityTimeline is a resource planning and time tracking app for Jira that plugs directly into your existing worklogs. Here's what it brings to the table:

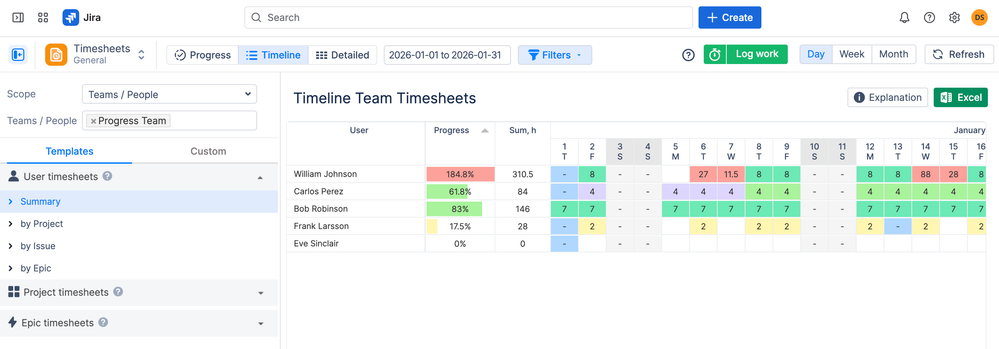

Rather than viewing time per issue, ActivityTimeline lets you see hours logged by each person across all projects for any date range. You can switch between a Timeline view (colour-coded summary of logged vs. expected hours per user per day), a Calendar view (useful for communicating schedules to stakeholders), and a Detailed view for drilling into individual worklog entries.
The timeline view uses colour indicators to flag whether someone has logged too much or too little relative to their planned involvement — useful for spotting outliers without manually checking each person's entries.

The Planned vs. Actual chart compares estimated time, time spent, and remaining time across tasks. It marks each item as:
This is the feedback loop that makes estimation improve over time. It surfaces "time black holes" — tasks that consistently absorb more effort than expected — so you can adjust how you scope similar work in future.
For billing, audits, or any situation where signed-off timesheets matter, ActivityTimeline supports a structured approval process. You can configure reporting periods (weekly is common), review submitted entries, and lock the period once approved. Locked periods prevent backdating or unauthorised changes, giving you a verifiable record.

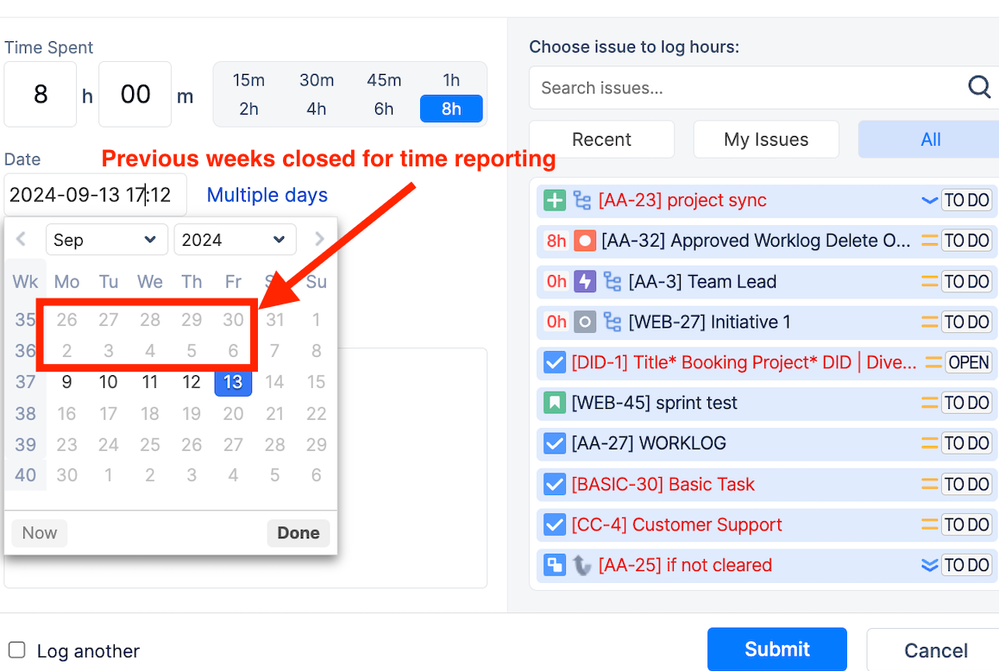

Grace periods can be configured to allow late submissions without reopening a closed period — from no grace period up to 30 days after period end. You can set both the number of days and a specific cutoff time (for example, +3 days at 12:00).

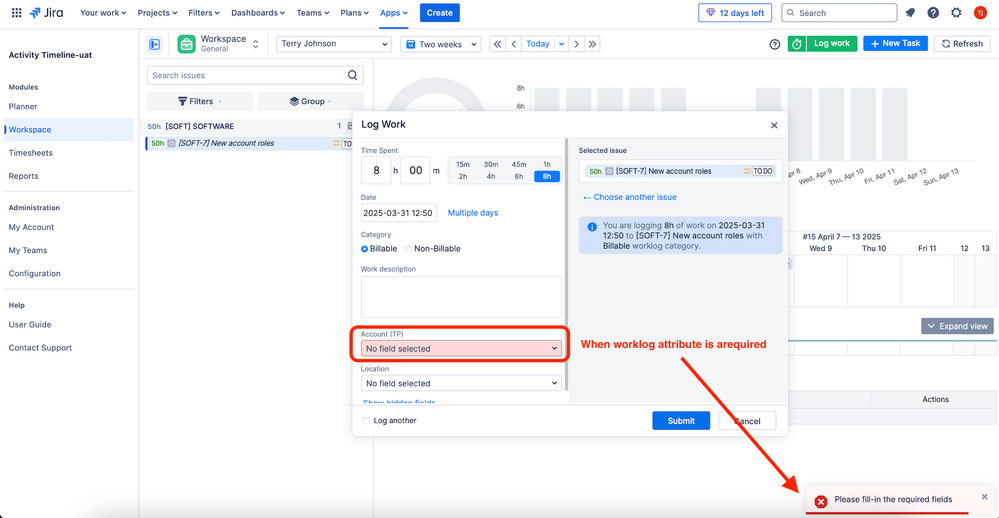

Standard Jira worklogs only capture time and a description. Worklog Attributes let you attach custom fields to each entry — things like Cost Centre, Client Name, Location, or any other dimension your billing or reporting process requires.
Each attribute can be set as:
If you're already using Tempo Timesheets Cloud, you can import existing worklog attributes rather than recreating them.
Once you have data flowing in, ActivityTimeline lets you save report configurations so they don't need to be rebuilt each time. The general approach:
Good tooling only helps if the underlying data is trustworthy. A few practices worth enforcing as team standards:
Native Jira time tracking is a solid foundation for logging work and comparing it against estimates. For many teams, though, the reporting layer doesn't go deep enough — particularly for user-level visibility, billing workflows, and the kind of planned vs. actual analysis that helps estimation improve over time.
ActivityTimeline builds on Jira's existing worklog data to add that layer without requiring you to manage a separate time tracking system alongside your project work.
If you have questions about specific configurations — approval workflows, worklog attributes, or connecting this to your billing process — drop them in the comments.
