Due Date vs. SLA Target Date: why your Jira deadlines feel broken

It’s a classic Monday morning scenario: You open your Jira queue, and half your tickets are screaming at you in red text. But as you dig in, you realize something is off. Is that a Due Date that an agent manually picked two weeks ago, or an SLA (Service Level Agreement) that represents a binding contract with a frustrated customer?

If you’re nodding your head, you aren’t alone. Many teams treat these two fields as interchangeable, but using them incorrectly is a fast track to messy reporting, missed commitments, and a very stressed-out team.

Let’s break down the real-world differences and figure out which one actually belongs in your workflow.

1. The Due Date: Your "Static post-it note"

Think of the Due Date as a post-it note on a calendar. It’s a fixed point in time. It doesn’t care if you’re busy, if it’s a public holiday, or if the customer hasn’t replied to your email in three days.

When to use it:

  • Project Milestones: "We need this feature live by March 15th."
  • External Deadlines: A hardware shipment arriving on a specific Tuesday.
  • Personal Reminders: An agent setting a date to follow up on a specific task.

The problem:

The Due Date is stubbornly manual. If a ticket moves to "Pending" because you're waiting on a vendor, the Due Date stays exactly where it is. It won’t budge unless a human manually changes it, which makes it a poor tool for measuring true service performance.

2. The SLA Target: the "Living stopwatch"

An SLA (Service Level Agreement) is dynamic. It isn’t just a date; it’s a set of rules that calculates a deadline based on priority, working hours, and ticket status.

Why it’s smarter than a Due Date:

  • It respects your sleep: If an issue comes in at 2 AM on a Saturday, a 4-hour SLA won’t breach by 6 AM if your working hours are Monday–Friday, 9–5.
  • It hits the "Pause" button: When you move a ticket to "Waiting for Customer," the timer stops. You aren’t penalized for the customer’s delay. (Note: This logic applies to standard, rule-based SLAs).
  • Multi-layered goals: You can track "Time to First Response" and "Time to Resolution" on the same ticket simultaneously.



The side-by-side comparison

Feature

Due Date

Standard SLA Target Date

Nature

Static / fixed date field

Dynamic / calculated target

Logic

Manually set on the issue

Calculated automatically based on SLA rules

Working Hours

Does not use working calendars by default

Can respect configured working calendars and schedules

Pause Logic

No pause logic

Can pause and resume based on configured conditions

Use Case

Individual deadline or reminder

Service performance tracking against defined SLA commitments

Reporting

Basic deadline visibility in Jira

SLA reports, charts, and performance tracking



The "Gray area": when fixed dates need SLA power

Sometimes, you need a "hybrid" approach. Perhaps a VIP customer requests a specific delivery date, or a vendor promises a fix by "next Friday." This is a manual handshake agreement (like a Due Date), but you still want the professional tracking and visibility of an SLA.

This is where native Jira can get tricky, and where specialized tools like SLA Time and Report for Jira bridge the gap with the Negotiated Date SLA type.

What is a Negotiated Date SLA?

A Negotiated Date SLA allows you to use a Jira date field (such as Due Date or a custom Date/Time field) as the reference point for an SLA goal.

Instead of calculating the SLA purely from fixed time targets (like 4 hours to resolution), the SLA is measured against a specific date stored in the issue field. This makes it possible to track deadlines that are agreed individually for each ticket.

In SLA Time and Report for Jira, you can configure a Negotiated Date SLA by selecting the date field that defines the target time and setting the conditions that start and stop the SLA timer.

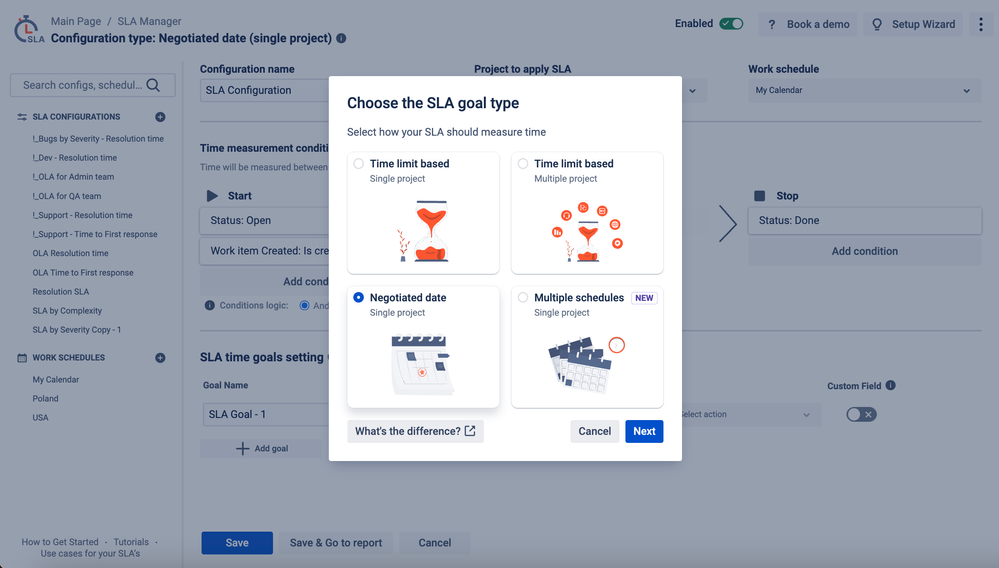

Знімок екрана 2026-03-10 о 20.18.25.png

Why this helps your team:

Using a Negotiated Date SLA helps teams turn manually agreed deadlines into trackable and reportable SLA commitments.

1. Unified SLA reporting

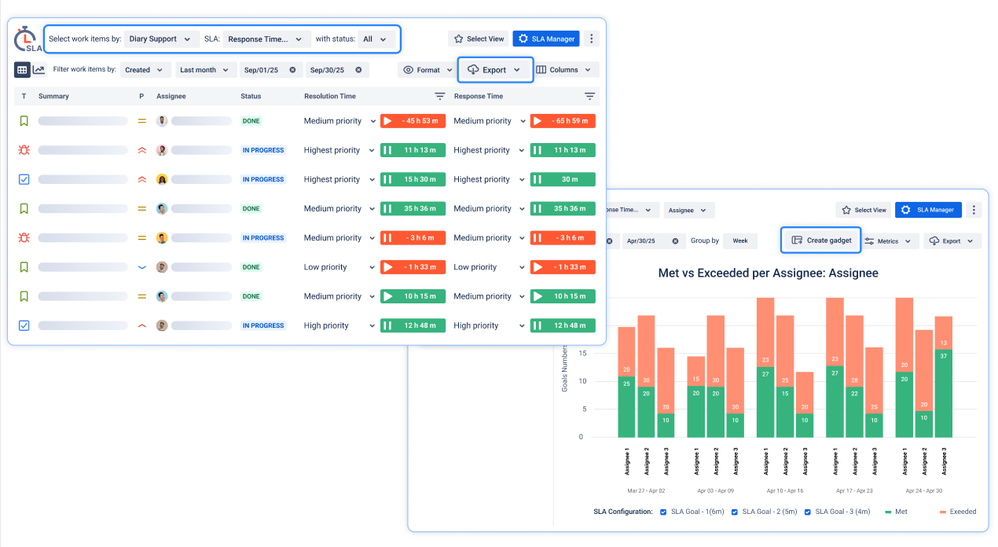

Знімок екрана 2026-03-10 о 20.20.12.png

Normally, fields like Due Date are used only as visual reminders in Jira and are not included in SLA performance metrics.

By linking a date field to a Negotiated Date SLA, those deadlines become part of your SLA reporting, allowing them to appear in reports and charts such as:

  • Met vs. Exceeded SLA charts
  • SLA performance reports
  • dashboard gadgets

This helps managers see both standard SLA goals and individually negotiated commitments in the same reporting layer.

2. Deadline-based automation and actions

When configuring an SLA goal, you can define actions that occur when the SLA is breached.

For example, you can automatically:

  • notify a responsible user in a comment
  • change the issue priority
  • update the issue status
  • reassign the ticket

These actions allow teams to react when a negotiated deadline is missed.

3. Clear deadline visibility for special cases

Negotiated dates are useful when a ticket requires a specific delivery date instead of a standard SLA rule.

Rather than modifying your global SLA configuration, you can simply set the date field on the issue, and the SLA will track progress against that deadline.

Real-world use cases

The Special Customer Request

A customer asks for a custom report by next Tuesday. Your standard SLA might require a 4-hour response, but that does not represent the real commitment for this request. You set the Due Date to Tuesday and configure a Negotiated Date SLA based on that field.

Now the deadline becomes part of your SLA tracking and will appear in your SLA reports.

Hardware Procurement or External Delivery

Your team orders a laptop for a new employee. The vendor confirms delivery on the 10th of the month. You set the Negotiated Date field to that date, and the SLA monitors whether the issue reaches completion before the agreed deadline.

If the deadline is exceeded, the configured SLA actions can notify the responsible team or trigger escalation steps.

When to use Due Date vs SLA vs Negotiated Date SLA

Each option serves a different purpose in Jira.

Use Due Date when:

  • you simply need a reminder or task deadline
  • reporting and SLA tracking are not required

Use Standard SLA rules when:

  • you want consistent service targets (for example response or resolution time)
  • SLA timers must respect workflow statuses and working schedules

Use Negotiated Date SLA when:

  • each issue may have its own agreed deadline
  • you want those deadlines included in SLA reporting
  • you want automated actions when the deadline is missed

Conclusion

Deadlines in Jira can mean different things depending on how they are used.

A Due Date is a simple task deadline. A standard SLA measures operational performance against predefined targets. A Negotiated Date SLA, available in the SLA Time and Report, connects these two worlds by turning individual ticket deadlines into trackable SLA commitments with reporting and automated actions.

This approach helps teams maintain flexibility for special cases while still keeping clear SLA visibility, reporting, and accountability across their Jira projects.

If your team frequently works with custom deadlines or negotiated delivery dates, configuring a Negotiated Date SLA can be a practical way to bring those commitments into your SLA reporting and service performance analysis.
