Cycle Time Isn’t Enough in Kanban Analytics: What Else You Should Measure in Jira

 ChatGPT Image Apr 17, 2026, 02_42_37 PM 1.png

If you use Kanban in Jira, Cycle Time is probably one of the first metrics you look at. And that makes sense: it helps you understand how long work takes once it has started.

But Cycle Time alone does not tell the whole story.

Two teams can have the same average Cycle Time and still work very differently. One may deliver steadily with little waste. The other may be overloaded, frequently blocked, and slowed down by hidden delays. If you only watch Cycle Time, you can easily miss those signals.

To understand how work really flows, you need a broader set of Kanban metrics.

Why Cycle Time Alone Is Not Enough

Cycle Time shows how long an issue spends between the start of work and completion. It is useful for spotting trends and forecasting delivery, but it has clear limits.

It does not show:

  • how much work is in progress at the same time
  • where items spend most of their time
  • how much waiting or blocked time exists
  • whether work moves smoothly or repeatedly gets stuck
  • how many items your team actually completes over time

That is why Kanban analytics in Jira should never rely on a single metric. A better approach is to look at several flow metrics together so you can understand both speed and stability.

First, How to Calculate Cycle Time in Jira

Before moving on to other metrics, let’s quickly define Cycle Time.

Cycle Time is the time from the moment your team starts working on a task to the moment it is completed. In other words, it measures execution speed, not the total waiting time before work begins.

In Time Metrics Tracker, you can calculate Cycle Time by configuring the appropriate metric in just a few clicks. Once it is set up, Cycle Time appears directly in your table, making it easy to analyze each work item individually.

This allows you to:

  • see the Cycle Time for every issue
  • compare items side by side
  • view the average metric value at the top
  • sort values in ascending or descending order to identify issues with the highest or lowest Cycle Time

That level of detail is useful, but it becomes much more powerful when you combine Cycle Time with additional Kanban metrics.

Lead Time: The Full Delivery Experience

The metric most often paired with Cycle Time is Lead Time.

While Cycle Time measures how long work takes after it starts, Lead Time tracks the total time from when a task is requested to when it is delivered.

In Time Metrics Tracker, Lead Time is calculated automatically by measuring the time from a task’s first status, such as To Do, to its final status, such as Done.

Why does it matter?

A team may have a reasonable Cycle Time but still deliver slowly if work spends too much time waiting before anyone starts it. That is exactly what Lead Time helps reveal. It shows how efficient your process is from end to end, not just during active execution.

High Lead Time usually means slower delivery, longer wait times for stakeholders, and a greater chance of frustration for customers. It also helps teams set more realistic expectations and detect issues in intake, prioritization, or handoff stages.

Throughput: How Much Work You Actually Finish

Cycle Time tells you how long one item takes. Throughput tells you how many items your team completes in a given period.

This matters because speed without delivery volume can be misleading. A team might improve Cycle Time simply by focusing on smaller or easier tasks while overall output stays flat. In that case, the process may look faster, but not necessarily more effective.

Tracking Throughput helps answer questions such as:

  • Are we finishing work consistently?
  • Is delivery becoming more predictable?
  • Are process changes improving actual output?

A Control Chart can help visualize throughput over time, making it easier to identify trends, anomalies, and changes in predictability.

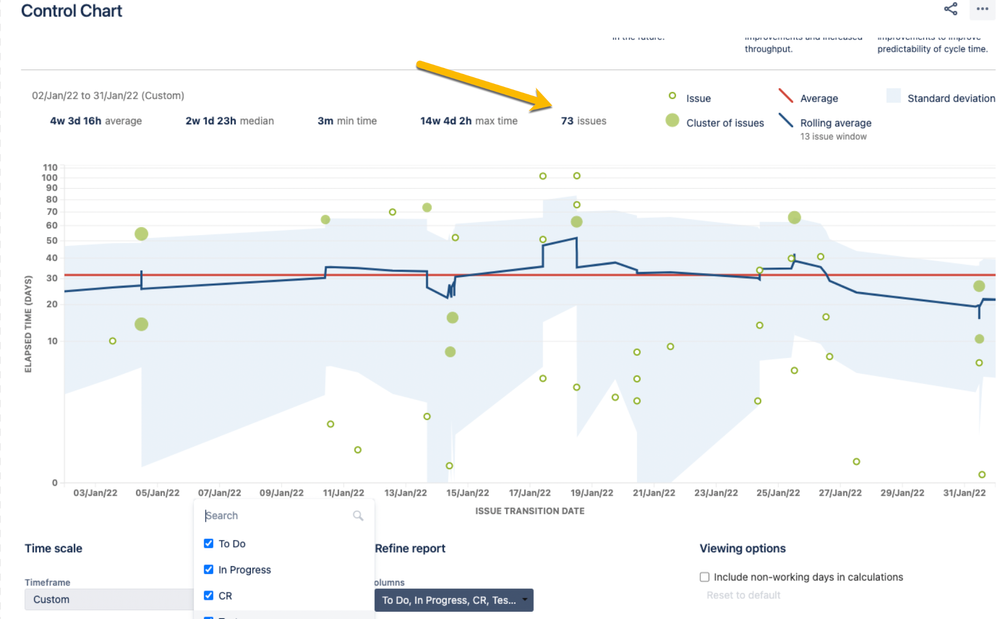

 Знімок екрана 2025-03-27 о 13.20.51.png

Work in Progress (WIP): See Risk Before It Becomes Delay

Another essential metric is Work in Progress, or WIP.

At its core, WIP shows how many issues are being worked on at the same time. Monitoring it helps teams understand whether too much work is active at once, which often leads to slower flow, more context switching, and less focus.

In practice, it is also useful to monitor how long current in-progress issues have already been open. In Time Metrics Tracker, the WIP Run Chart gadget helps visualize this and makes it easier to spot items that may be at risk.

This is one of the best ways to identify trouble before it turns into a delivery delay.

For example, if most tasks are usually completed in five days, but a current item has already been in progress for eleven days, that item likely needs attention. It may be blocked, under-prioritized, too large, or simply forgotten in the workflow.

Why it matters:

WIP visibility helps prevent team overload, improves focus, and makes blockages easier to spot early. Instead of waiting until delivery metrics worsen, you can act while the issue is still in progress.

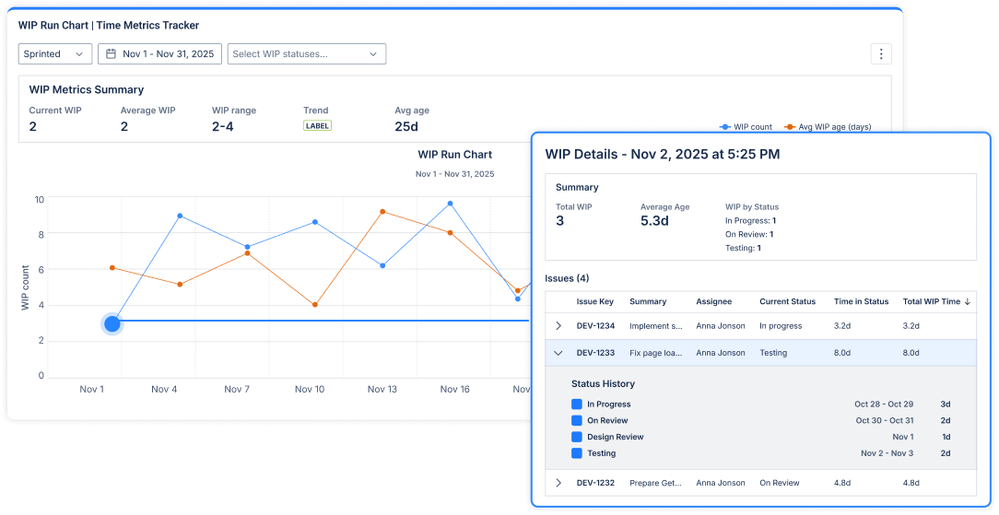

 Group 22 (1).png

For Kanban teams, this is especially valuable because it supports one of the core principles of flow: finish work before starting too much new work.

Blocked Time: Measure Waiting, Not Just Working

Not all delays look the same. Sometimes work is technically in progress, but nothing is actually moving.

That is where Blocked Time becomes important.

Blocked Time measures how long issues spend in statuses such as Blocked, Waiting, or any similar state in your Jira workflow. This metric helps you separate active work time from passive delay.

Why does this matter? Because a task can have an acceptable Cycle Time on paper while still wasting a large share of that time waiting for dependencies, clarifications, approvals, or external input.

When you track Blocked Time, you start seeing patterns such as:

  • repeated dependency issues
  • slow handoffs between teams
  • delays caused by missing information
  • workflow steps that look active but are actually stalled

If your team wants to improve flow, reducing blocked time is often one of the fastest wins.

Time to Approval: Reveal Friction in Review and Decision-Making

For many teams, work is not truly done when development ends. It still has to go through review, validation, or approval.

Time to Approval measures how long it takes for an issue to move from a status such as Ready for Review to Approved.

This metric is especially useful for teams where delivery depends on stakeholders, product owners, QA, legal review, design validation, or management sign-off. Even if development is fast, a slow approval step can quietly extend delivery time and create frustration.

Tracking Time to Approval helps you understand whether your review process is smooth or whether decision-making is becoming a bottleneck. If approval consistently takes longer than expected, the problem may not be in execution at all — it may be in communication, ownership, or review capacity.

 Group 6273236 (1).png

Time in Status: Find Where Work Really Spends Its Life

Time in Status shows how long issues spend in each workflow status.

This is one of the most practical metrics for understanding where flow slows down. Instead of only seeing that an issue took twelve days from start to finish, you can see exactly how those twelve days were distributed. Maybe development took two days, review took one day, and waiting for testing took nine days. That tells a very different story.

Time in Status helps teams:

  • identify bottlenecks
  • compare stages of the workflow
  • understand where waiting accumulates
  • validate whether the workflow reflects reality

It is also useful when discussing process changes with the team because it makes inefficiencies visible and concrete.

Transition Health: Is Work Moving Smoothly or Bouncing Around?

A workflow can look structured on the board and still behave inefficiently underneath.

That is why it is useful to pay attention to transition health — in other words, how smoothly issues move from one status to another. If tasks frequently move backward, return to previous stages, or pass through unnecessary transitions, that is usually a sign of workflow friction.

Transition-related analysis helps uncover issues such as:

  • too many handoffs
  • rework after review
  • unclear entry or exit criteria
  • statuses that add reporting complexity without adding real process value

Healthy flow is not just about moving fast. It is also about moving forward with minimal bouncing, waiting, or rework.

Tips to Improve Performance

  • Reduce WIP — fewer tasks in progress means better focus
  • Review blocked tasks regularly
  • Look beyond averages and pay attention to outliers
  • Simplify approvals and handoffs
  • Analyze metrics together, not separately

Final Thoughts

Cycle Time is an important metric, but it is only part of the picture.

To understand how work really flows in Jira, you need to look more broadly:

  • Lead Time — the full journey of a task
  • Throughput — the amount of work completed
  • WIP — workload and delivery risk
  • Blocked Time — delays caused by waiting
  • Time to Approval — friction in review and sign-off
  • Time in Status — where bottlenecks appear

Together, these metrics help you understand not only how long work takes, but also why it takes that long — and what needs to be improved.
