Hi all,

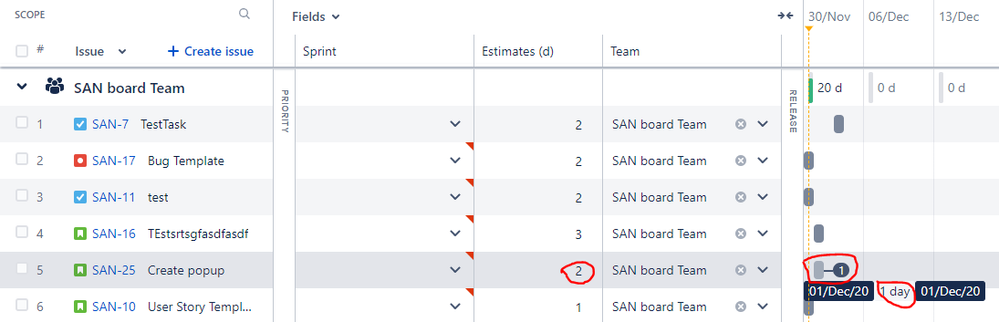

we are currently testing the Advanced Roadmaps feature within the Jira Premium subscription. I used the 'Auto-schedule' feature to plan a few dummy tasks with a team of the 'Kanban' team type. After auto-scheduling, many of the tasks obtain the duration of one although some of them have a duration > 1 (see image below) . Is this the expected behavior or a bug?
Kind regards
Alex
Hi,
is this still an issue? How many hours or days have you allocated to the team?
Hi Ollie,
thank you for your reply.
The team has a capacity of 200 hours per week. I think the duration of one on the timeline above is due to the team capacity of 40 per working day. An estimate of 2 days corresponds to 16 hours (due to our global time tracking settings). So the task could be processed in one day by the whole team. However I find this a bit confusing because if a person is assigned to a task I cannot assume that the whole team is working on the task.
I think I would have to generate a team for every assignee such that this works as I expect it to.
Kind regards
Alexander
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
Online forums and learning are now in one easy-to-use experience.
By continuing, you accept the updated Community Terms of Use and acknowledge the Privacy Policy. Your public name, photo, and achievements may be publicly visible and available in search engines.
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
