Hello,
I am having an issue where dates are not rolling up more than one level in JIRA plans unless the bottom most issue (in this case a JIRA story) has set Start and Due dates.
Here is what I am seeing:
Scenario 1:
- Story 1 has no set start and due dates, is a child of Epic 1, which itself is a child of Initiative 1

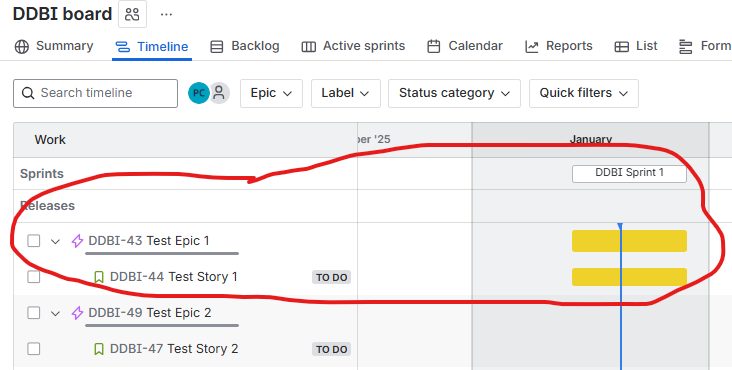

- Story 1 has been added to a sprint starting Jan 14 and ending Jan 28

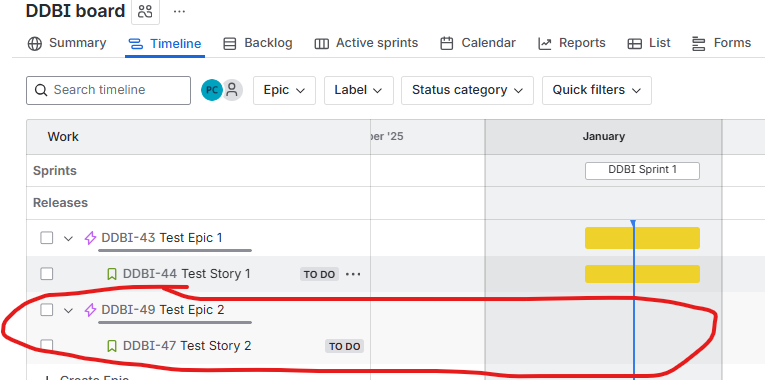

- In the Timeline view of the JIRA space that Story 1 belongs to, I see that the dates from the sprint that Story 1 belongs do roll up to Epic 1, which is expected since the timeline is configured to Schedule by sprint dates, not start/due dates

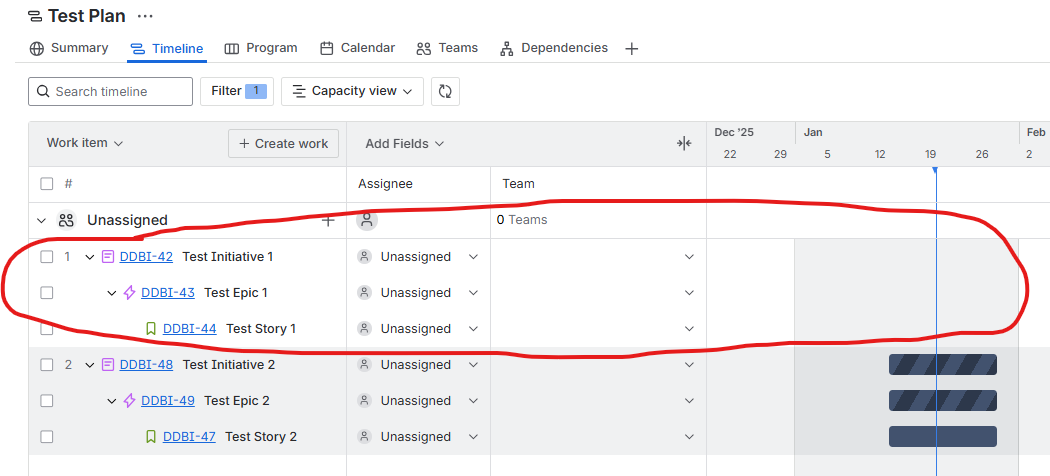

- In the JIRA plan which includes work from the JIRA space that Story 1 belongs to, there is no rollup of dates from Story 1 to Epic 1 or to Initiative 1, which is unexpected

Scenario 2:
- Story 2 has a set start date of Jan 14 and set due date of Jan 28, is a child of Epic 2, which itself is a child of Initiative 2
- Story 2 does not belong to any sprints yet
- In the Timeline view of the JIRA space that Story 2 belongs to, the start and due dates from Story 2 do not roll up to Epic 2, which is expected since the timeline is configured to Schedule by sprint dates, not by start/due dates

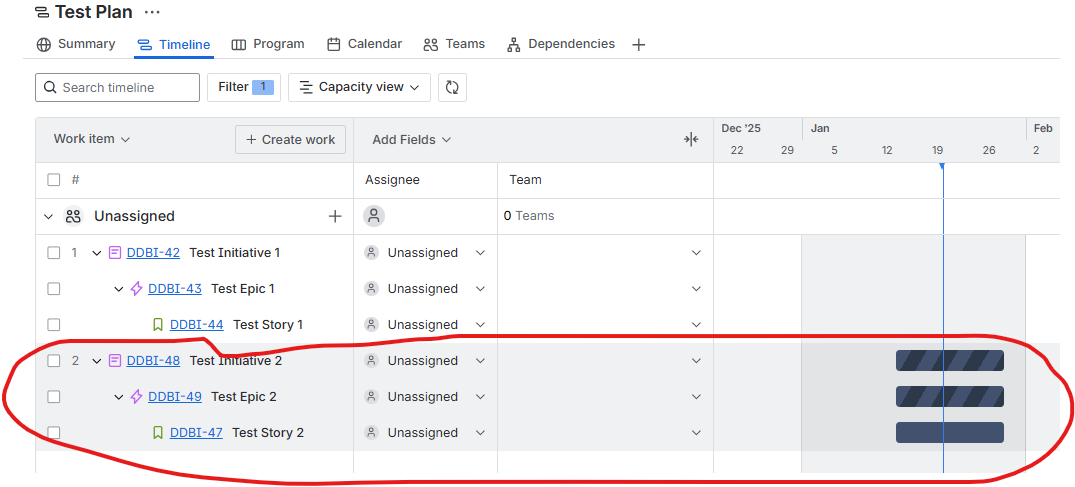

- In the JIRA plan which includes work from the JIRA space that Story 2 belongs to, there is a rollup of dates from Story 2 to Epic 2 and unto Initiative 2, which is expected

---
Is there something I am missing here? Shouldn't the sprint dates rollup, just like fixed start and due dates do, from a Story to its parent Epic and then the parent Initiative in the JIRA plan like it does in the JIRA Board Timeline?
Thanks,
Peter
