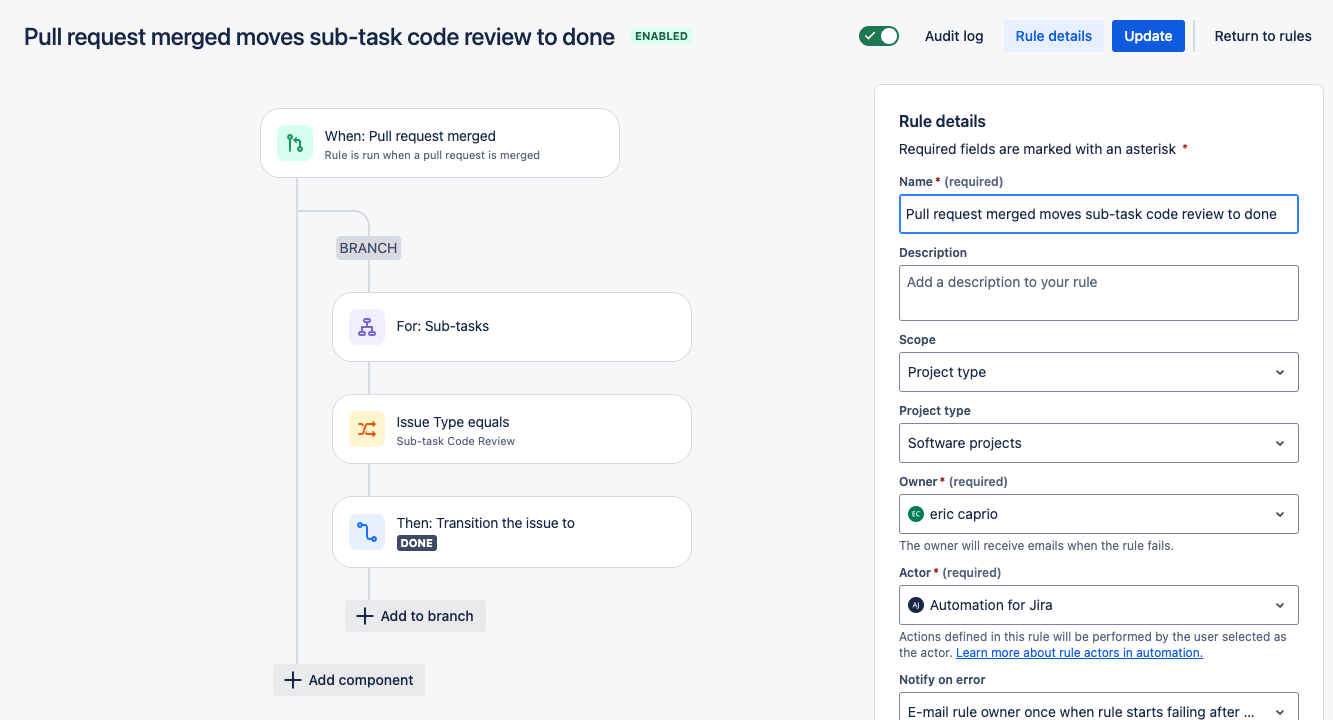

In a company based software project, the flow is a story is created. When it is moved to Code Review status, a sub-task Code Review is created. The below is an attempt at automating the transition to Done for the sub-task Code Review when a PR is merged in the parent task. This is to ensure tasks are up to date as developers may not go into JIRA to close the sub task after merging the PR.

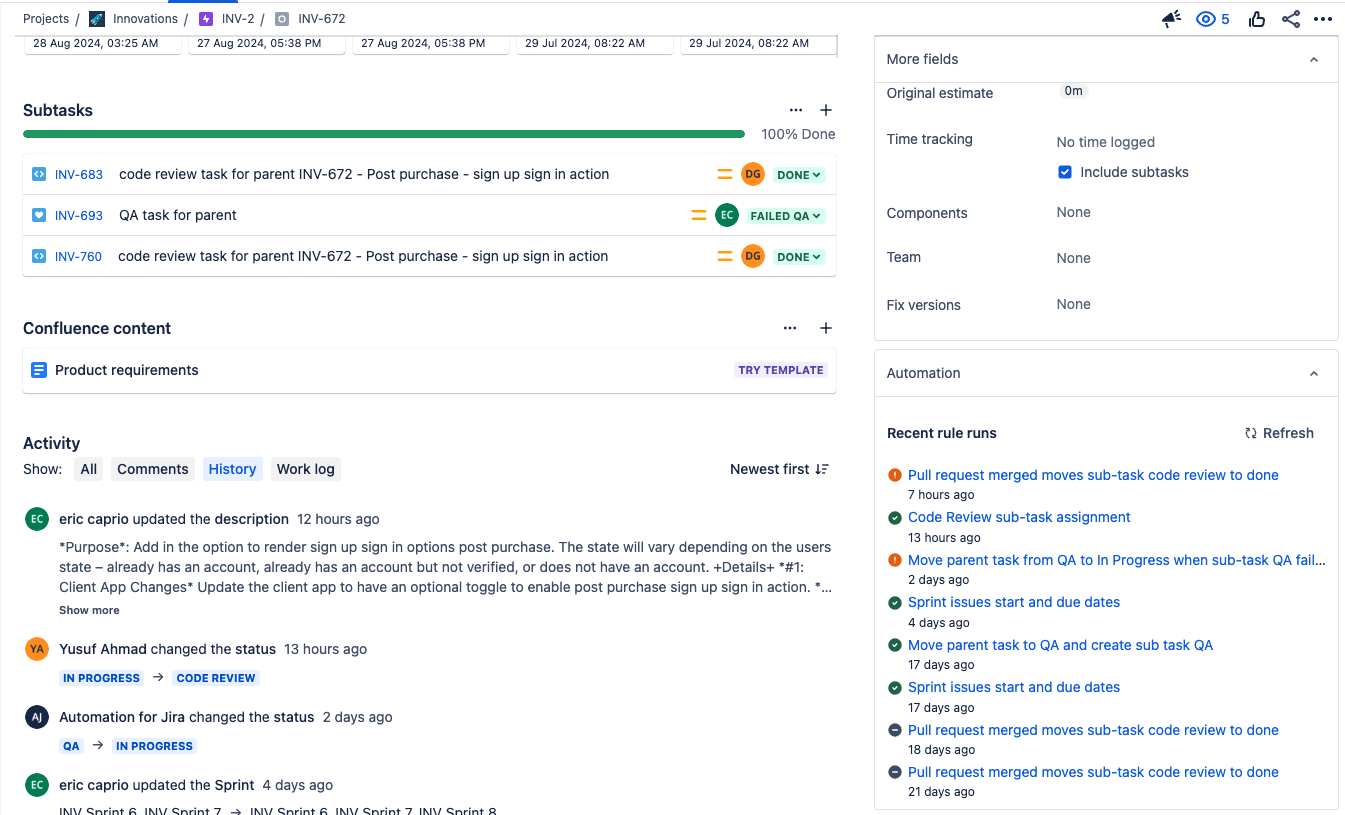

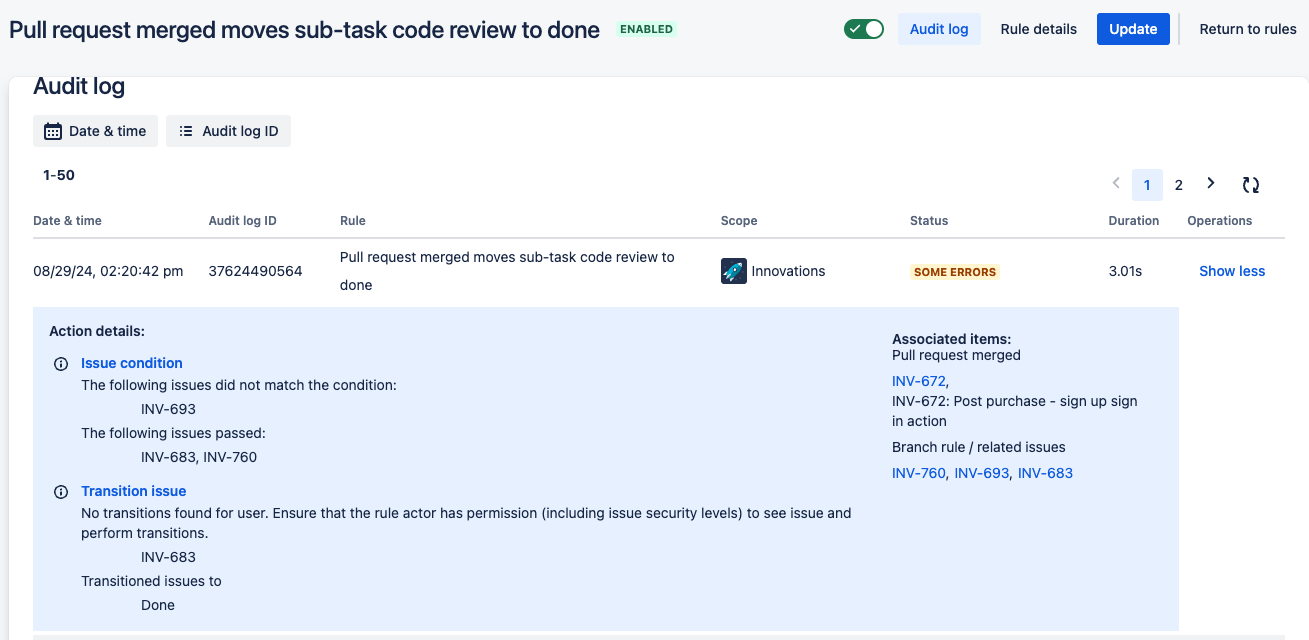

I am getting an error back... it does look like the sub-task QA INV-760 did get closed. Not sure if the error is in relation to the previous code review task which was already closed. The flow when failed QA, will complete the sub-task QA - moves parent back to in progress - which creates another sub-task code review when parent task has the new or adjusted PR
Any insight would be great!
