Our team was used to work with Story and Task and reference multiple Tasks in a Story.
A Story is generally written by the Product Owner, whereas the Tasks are then created by the Engineers with the pieces of work necessary to accomplish that given Story.
This is not optimal because we prioritize the work in Story level, so whenever a Story changes position in the backlog, you have to manually reposition all the Tasks related to it so they follow eachother.
To get rid of the behavior explained above, we migrated from using Tasks to using Sub-tasks. Right now, prioritization and backlog organization is perfect: we just need to reorder a Story and all the Sub-tasks will go along. It has also enhanced our vision of Story completion as there's a progress bar on the Story with the amount of Sub-tasks that are already marked as Done.
The problem of switching to Subtasks is that now the tab Insights is not working properly neither in the Backlog nor in the Active Sprint.

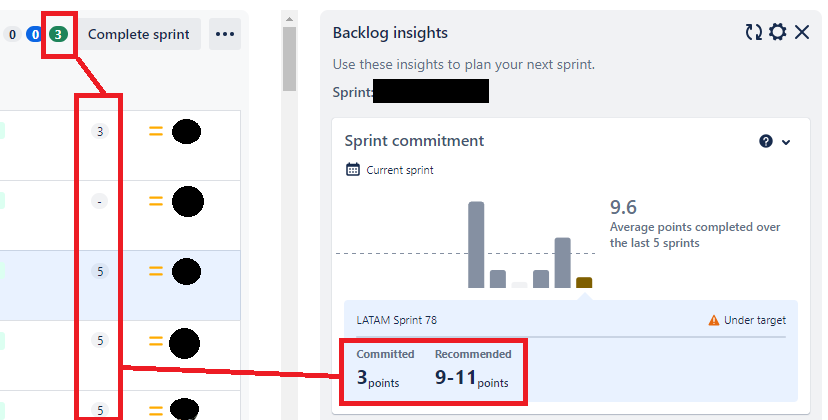

As you can see below, our current Sprint is only being considered to have a total of 3 points, despite lots of points in the Sprint Backlog. (The 3 counted points are from a Bug, not a Subtask). This is a problem for Sprint Planning as now the points from Subtasks needs to be summed manually by the team, as well as the Sprint commitment chart is already completely wrong as it is not summing the points correctly.

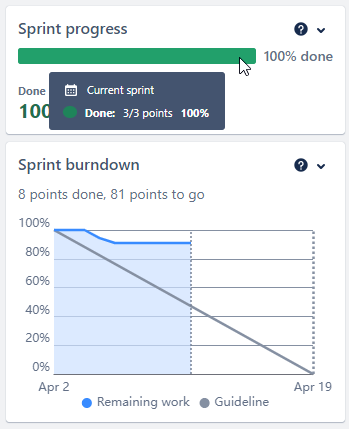

And if you check the Insights in the Active Sprint, the Sprint burndown considers the points correctly, but the Sprint progress presents the same bug as above.

Do you agree it should be fixed? Can you think of any workarounds for that?
