Kinda strange situation and i'm looking for Atlassian's community wisdom!
- I create an issue, pass it to our engineer to estimate the task.
- He evaluates it and sets 'Original estimate', let's say a week (40 hours).

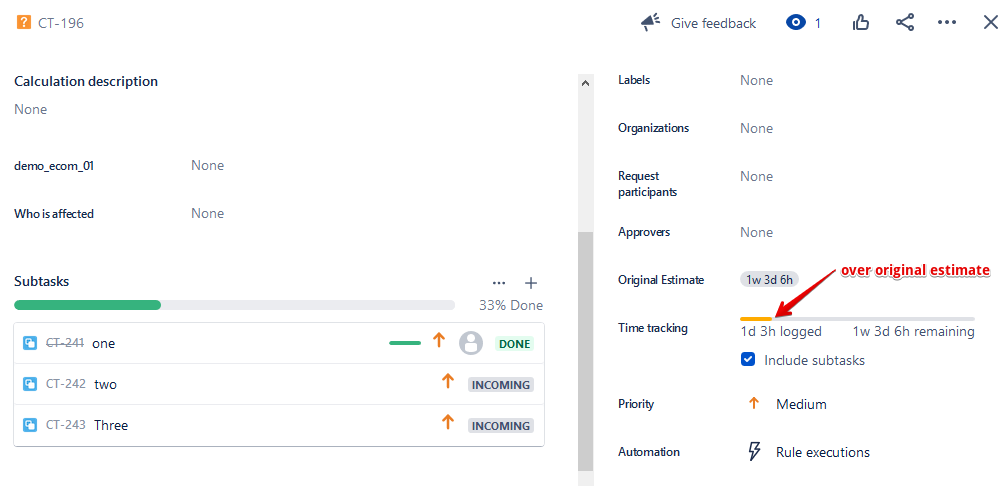

- Later a developer starts to work on it, and creating several sub-tasks.
Now, the problem: He opens a sub-task and...

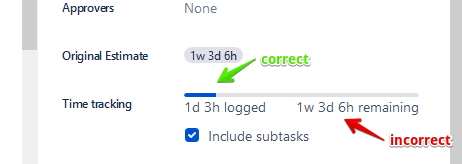

- If he start logging time to specific sub-task he currently working on, then all that time becomes 'orange' (over estimate) and still it adds to the total time of parent's card.

- If he sets 'original estimate' in each sub task and then start logging, then that extra time adds to Parent's task original estimate.

- If he logs time to parent task, then we all lose a valuable data (sub-tasks can be done by different people and parents / sub's can be on different stages).
- Creating sub-tasks and evaluating each individually is too complex on an early stages, plus not always an estimator is the same person who will work on this tasks.
Changing original task's estimate i.e. treating it as a budget and editing original estimate (subtracting) from parent task each time then anyone want to set original estimate on a sub task. Dunno if that's possible via automation rule, but cant figure out how to solve it.
My goal is to keep visible total planned time vs used and ability to log time on sub-tasks where you actually doing something.
P.s. i tied two more ways: utilize 'epics' and generic tasks linking (dependency), but both losing visibility for managers (Estimated vs already wasted/remaining), its no longer possible to track at glance.
Please Help!
