(Still looking for help on this issue I'm having)
Struggling with what I think should be a straightforward Jira automation.

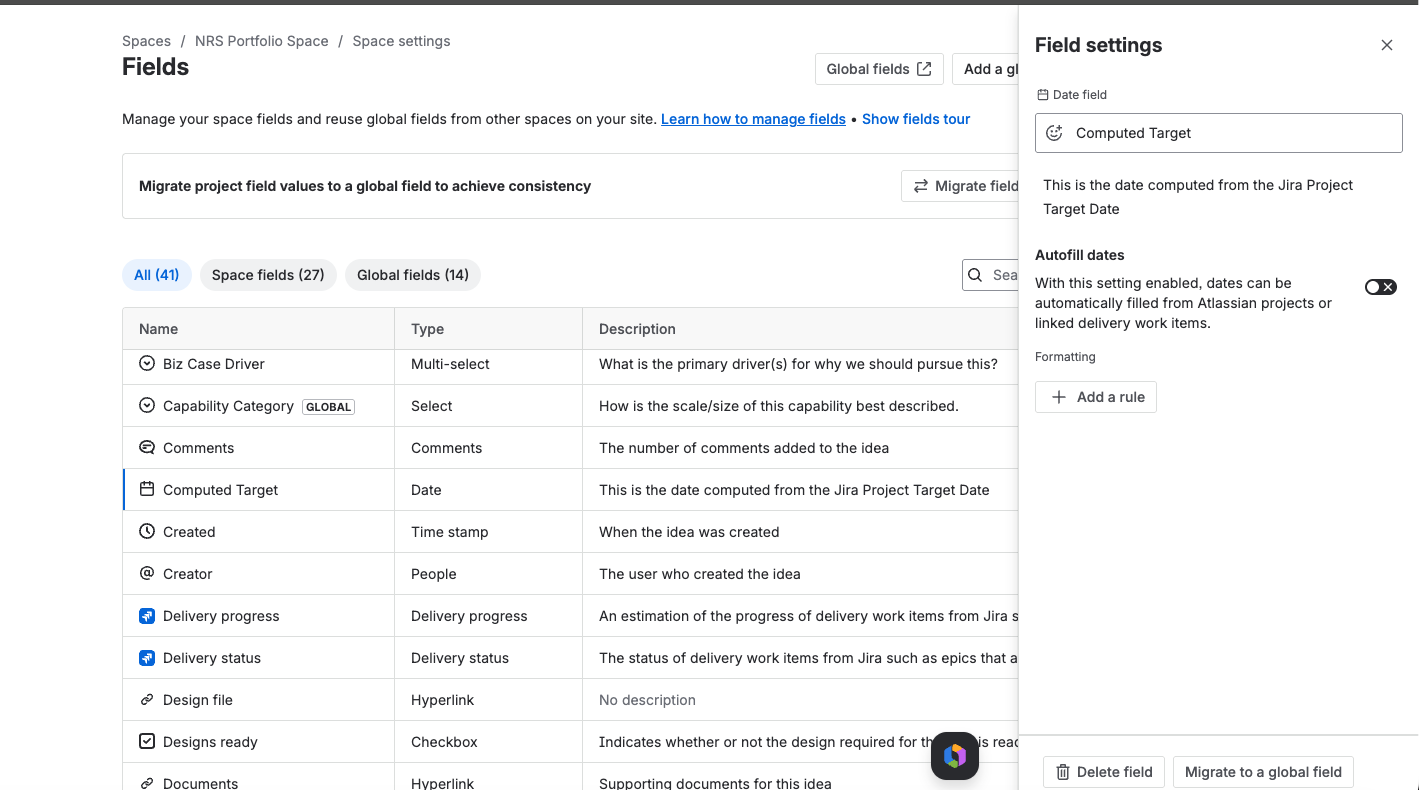

Because Jira doesn't support using the Target date field for group by period (Year, Quarter etc), I've created a custom date field "Computed Target" and created a flow that evaluates the Roadmap field value such that when equals "Completed", then the custom field will get updated with the current date (date the user has updated the roadmap field. Its not a perfect solution but its not terrible.

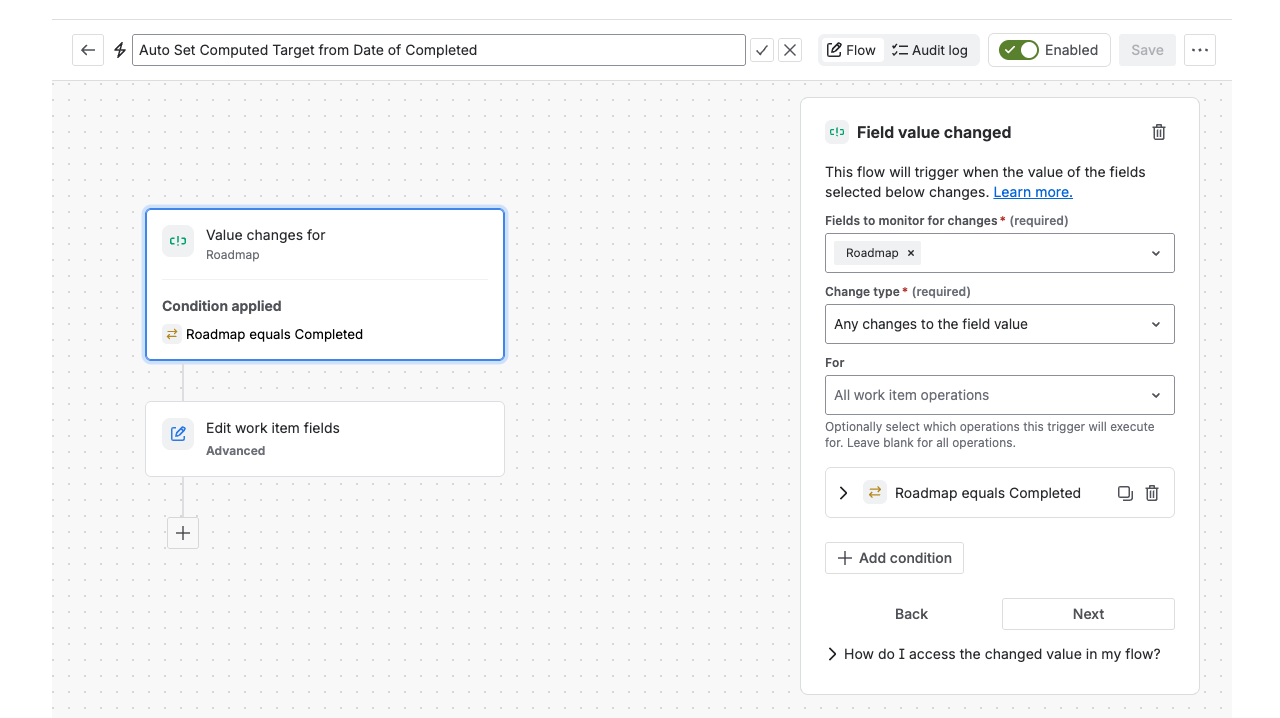

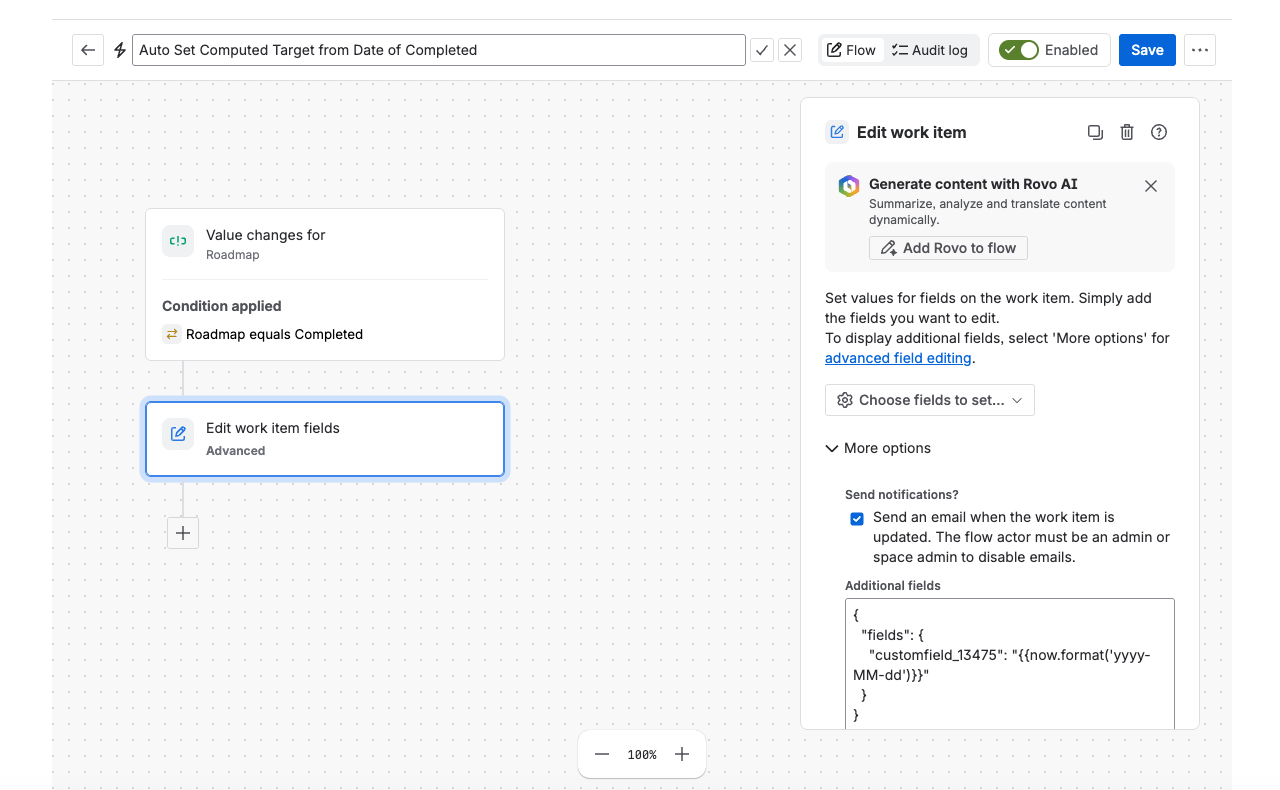

Here are the screenshots of the configuration.
